A SCADA integration is a design decision before it is a product category. An engineering team should begin with the operating outcome: information can cross a defined boundary without accidentally extending a business system's authority into control operations. That framing keeps the discussion tied to SCADA systems, PLC-facing data, enterprise applications, and operator workflows, rather than to a shopping list of tools. The decision becomes concrete when a team can describe a normal action, the authority that permits it, the evidence it creates, and what must happen when the normal path is unavailable. For example, a maintenance platform receives equipment state and alarm context through a gateway, but it cannot issue a command to a PLC or redefine a safety interlock. The first build should make that path dependable and visible; it should not hide unresolved ownership behind a promising demonstration.
SCADA control integration — Define the SCADA integrations decision
Set the boundary in plain language. For SCADA integrations, record tag namespace, source system, read or write authority, update cadence, quality semantics, time basis, mapping version, and owning engineer. Separate observations from commands, convenience from required behavior, and a temporary workaround from a supported capability — in SCADA integration commissioning. A useful design review asks who owns the decision, which system is authoritative, what changes state, and how a person will recognize an exception — in SCADA integration commissioning. The operational-technology guidance in NIST SP 800-82 Rev. 3 is a useful reminder that availability, safety, and reliability can constrain an otherwise sensible IT pattern — in SCADA integration commissioning. A boundary is credible only when it names the action that is allowed, the action that is deliberately excluded, and the route for requesting a change.
| Decision area | Question to settle before build | Evidence to retain |
|---|---|---|
| Outcome | What must SCADA integrations make possible under ordinary conditions? | A named user decision and acceptance example |
| Authority | Which record, policy, or person is decisive for SCADA systems, PLC-facing data, enterprise applications, and operator workflows? | Owner, source of truth, and approval path |
| Failure | What is the safe state when a dependency or connection fails? | Test case, recovery path behavior, and recovery owner |
| Change | Who can alter the rules, mappings, or access? | Reviewed change record and rollback point |
SCADA control integration — Model the SCADA integrations operating context
For SCADA integrations, a model that only shows components leaves important context out. Map the actor, asset or service, input, decision rule, output, and evidence for each important exchange — in SCADA integration commissioning. Include time semantics: distinguish when something was measured, received, processed, and confirmed. Include quality semantics too, because an unavailable, estimated, stale, or rejected value should not look identical to a current one. The NIST Cybersecurity Framework 2.0 provides a practical organizing lens for governance, identification, protection, detection, response, and recovery. It is not a substitute for local engineering judgment, but it helps expose gaps between an attractive architecture drawing and a runbook people can actually use.
Use realistic cases while modeling. Ask how a SCADA integration behaves during a planned maintenance window, a partial outage, a credential change, a delayed upstream record, and an operator handoff. A capable system preserves context across those moments. It does not force the next person to infer intent from an ambiguous status or a timestamp without a source. The design should also state which data is sensitive, which decisions need human confirmation, and how long evidence must remain available. These choices determine operational cost as surely as CPU, bandwidth, or licensing.
SCADA control integration — Set SCADA integrations controls and trust boundaries
Controls should reduce a specific failure mode, not decorate an architecture. For this topic, use read-only defaults, protocol gateways, explicit write approval, schema and tag mapping reviews, monitoring, and a tested method to disable the exchange. The essential question is whether access and automation remain proportionate to the consequence of an error. NIST SP 800-207 emphasizes that trust should not be granted merely because a request appears on a familiar network; identity, policy, and context still matter — in SCADA integration commissioning. Apply that principle without assuming every system can support the same mechanism. Older equipment may require a mediated boundary, compensating monitoring, and a carefully limited maintenance path rather than an unsupported security agent.
- Give SCADA integrations a named technical owner and an operations owner.
- Document the normal path, the degraded path, and the recovery path.
- Keep privileged actions separate from routine observation where possible.
- Record exceptions with an expiry, approver, and evidence of removal.
- Test that unavailable or low-quality inputs produce an understandable state.
- Review changes against the consequence to people, equipment, and service.
SCADA control integration — Design SCADA integrations for degraded operation
The important question is not whether a failure can occur; it is what the system will do next. An integration maps a vendor-specific status code incorrectly, creates false work orders, and obscures the original value needed to diagnose the error. Design the degraded state deliberately: preserve the last known fact with its age, stop actions that need fresh authority, queue only work that can later be reconciled, and tell the user what is pending. Do not equate retrying with recovery. Retries need stable identifiers, bounded timing, and a way to detect that an action already succeeded. A recovery procedure should identify the evidence to compare, the owner who can decide a disputed outcome, and the conditions that permit normal processing to resume.
SCADA control integration — Build and release SCADA integrations in bounded steps
A SCADA integration release needs topic-specific proof, not a generic readiness claim. Start with one controlled path and its uncomfortable cases. Build a representative test environment, then validate identity, data quality, authorization, behavior during loss of a dependency, and recovery. Release first to a bounded cohort or a noncritical workflow when the consequence allows it. Instrument the handoffs before volume arrives, including rejected input, delay, policy denial, and manual bypass. The NIST IoT device cybersecurity capability baseline is helpful here because it treats configuration, data protection, logical access, software update, and cybersecurity state awareness as operating capabilities rather than a one-time procurement checklist — in SCADA integration commissioning. Keep the release decision reversible until real evidence shows the path is understood.
| Release checkpoint | What to prove | Decision if it fails |
|---|---|---|
| Inventory | The participating assets and owners are known | Pause expansion and repair the inventory |
| Normal flow | A representative SCADA integrations transaction completes with traceable evidence | Correct the contract or mapping before rollout |
| Degraded flow | Loss, delay, or invalid input produces the intended safe state | Fix recovery behavior and repeat the exercise |
| Operations | The support team can identify, contain, and reconcile an exception | Keep the change in a limited cohort |
SCADA control integration — Measure SCADA integrations operational fitness
Choose measures that reveal whether the promised outcome still holds. Track mapping exceptions, stale tags, rejected writes, integration lag, change-review completion, and time to isolate an unhealthy connector. Pair the number with a review question: what decision will change if this worsens? A dashboard with twenty unowned counters creates attention without accountability. A smaller set connected to a threshold, owner, and response habit can improve the system. Review both leading signals, such as an overdue credential rotation or rising backlog, and lagging signals, such as a failed recovery exercise. Sample successful cases as well as incidents, because silent drift often appears in ordinary work before it becomes a visible outage.
SCADA control integration — Key takeaways for SCADA integrations
- SCADA integrations should begin with an operational outcome and a named decision owner.
- Make identity, time, quality, authority, and recovery visible in the design.
- Treat degraded operation as a first-class user and support experience.
- Release in a bounded scope, then expand only with observed evidence.
- Use measurements to trigger review and improvement, not to create passive reporting — in SCADA integration commissioning.
SCADA control integration — SCADA integrations frequently asked questions
Is SCADA integrations mainly a technology selection? No. Technology matters, but the durable choice is the operating contract around it: what is trusted, who can act, what happens under failure, and how change is reviewed. A tool that fits those constraints is usually easier to operate than a feature-rich product adopted without them. How much should the first implementation cover? Cover one valuable path end to end, including a realistic exception and recovery exercise — in SCADA integration commissioning. The first release needs enough scope to prove ownership, evidence, and support, but not so much that the team cannot learn from a contained failure. Add adjacent paths only after the initial behavior is reliable. When should the design be revisited? Revisit it after a material incident, a new device or integration class, a change in data sensitivity, or evidence that manual workarounds are becoming routine. Those are signs that the original boundary no longer matches the work — in SCADA integration commissioning.
SCADA control integration — Conclusion: make SCADA integrations operable
Good SCADA integration design makes the next action clearer when the system is under pressure. It connects SCADA systems, PLC-facing data, enterprise applications, and operator workflows to an accountable outcome, makes its limits explicit, and retains enough evidence to investigate and improve. Begin with the example that matters most to the people doing the work, specify the normal and degraded paths, and prove that the team can recover before broadening the scope. That is how an early technical decision becomes a dependable operating capability rather than a fragile layer of complexity.

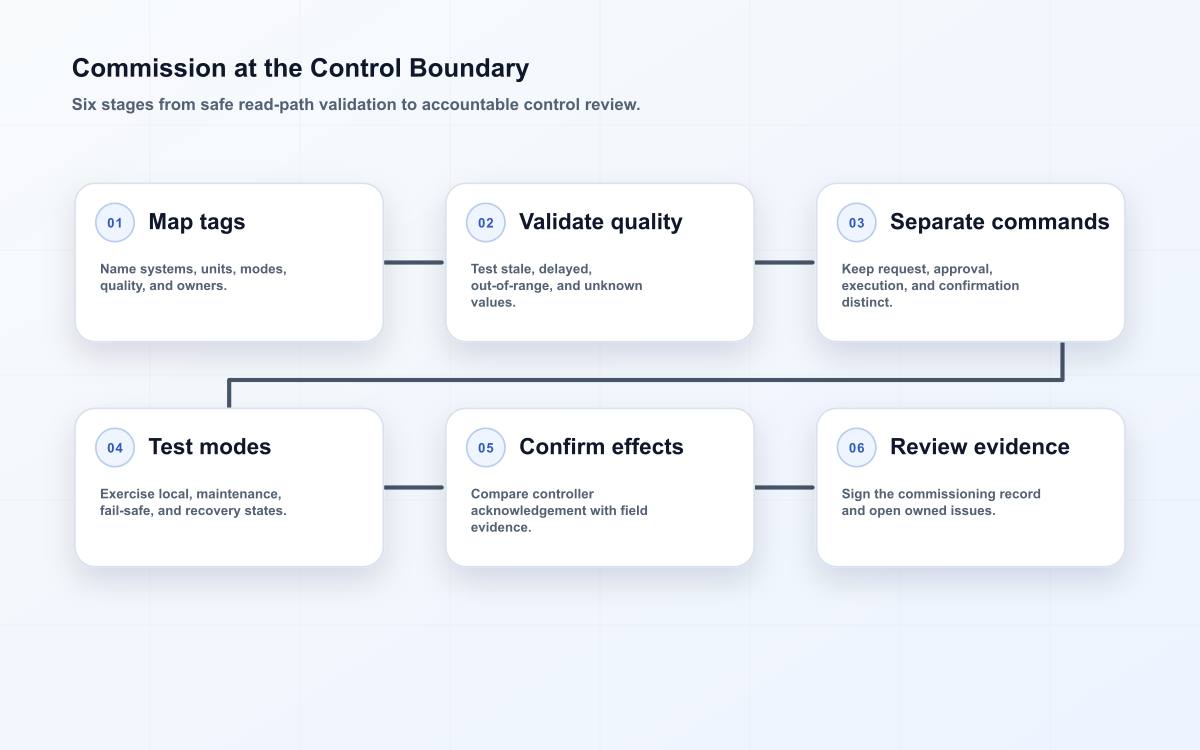

SCADA control integration — Commission the Integration at the Control Boundary
SCADA integrations should be commissioned as controlled exchanges, not as a successful screen refresh. Start with a read-only path that proves identity, units, timestamps, quality flags, and scan behavior. Then test what happens when a tag is stale, a controller is in local mode, a historian is delayed, or a mapped value is outside its expected range. Only after the read path is explainable should the team consider a write or command path. That sequence limits the consequence of a mapping mistake while giving operators a concrete way to challenge assumptions.

| Commissioning test | Question answered | Stop condition |
|---|---|---|
| Tag mapping | Are name, unit, range, time, and quality preserved? | Any silent conversion or unknown quality. |
| Mode change | What does the integration do in local or maintenance mode? | A remote action remains available without policy. |
| Command replay | Can a duplicate request cause a second physical effect? | No operation identity or idempotency rule. |
| Historian delay | Is stale data shown as stale to the operator? | Old value appears current without warning. |
For each command, separate request, approval, execution, and confirmation. A button click is not proof that the field action occurred. The integration should preserve who requested it, which current state was observed, which policy allowed it, what the controller acknowledged, and whether a subsequent reading confirms the expected result. NIST SP 800-82 emphasizes safety and availability constraints in OT environments; NIST SP 800-207 adds a useful discipline of explicit identity and policy at each boundary. Use those principles to shape a commissioning script that a control engineer can run and sign.
Selected references for this topic include NIST SP 800-82 Rev. 3: Guide to Operational Technology Security, NIST Cybersecurity Framework 2.0, NIST SP 800-207: Zero Trust Architecture, NISTIR 8259A: IoT Device Cybersecurity Capability Core Baseline. The selected publications anchor SCADA control integration; apply them with site procedures and deployment obligations.
For adjacent operating patterns, compare What Changes When SCADA Integrations Moves into Production, What Changes When Sensor Data Pipelines Move Into Production, What Changes When MQTT Brokers Move Into Production. The neighboring references connect scada integrations decisions that matter before the first build to its wider operating context.
