What Changes When a SaaS MVP Moves into Production

A SaaS MVP entering production needs more than extra traffic capacity: it needs accountable data boundaries, repeatable changes, observable customer outcomes, and a recoverable operating model.

Krishnam Murarka Updated 2026-07-12 Product Engineering

SaaS MVP production is a product-engineering concern because it changes what customers can safely do, what teams must explain, and what evidence is available when the path fails. A SaaS MVP entering production needs more than extra traffic capacity: it needs accountable data boundaries, repeatable changes, observable customer outcomes, and a recoverable operating model. The practical work is to define the boundary, make state authoritative, design for exceptions, and inspect the outcome after a release rather than trusting a happy-path demonstration.

Why SaaS MVP Production Matters

An MVP proves that a problem and product approach may be worth pursuing. Production adds an obligation: people will depend on the service, bring real data, invite colleagues, and expect recovery. The transition is not a rewrite triggered by user count; it is explicit commitments around identity, ownership, access, changes, observability, support, and recovery.

The durable pattern is to translate a promised experience into explicit states and decisions. AWS Well-Architected SaaS Lens: General design principles gives domain-specific evidence, while AWS Well-Architected Framework: Reliability Pillar frames the surrounding architecture and operating practice. A team does not need an oversized platform to begin; it needs a shared definition of the customer outcome and a way to demonstrate that the system produced it.

DecisionPractical ruleEvidence to retain
Customer boundaryName the tenant, actor, and scope governing SaaS MVP production.Validated context and authorization outcome.
Authoritative stateKeep the server-side source of truth, not a browser assumption.Version, source event, and transition time.
Exception pathState the response when a dependency or prerequisite is missing.Reason code, owner, and recovery outcome.
Change controlExpose behavior gradually and make reversal possible.Cohort, rollout decision, and audit trail.

Design The SaaS MVP Production Decision

Create a readiness map for core journeys. For each, identify tenant and actor, data changed, permissions, dependencies, expected result, failure state, owner, and evidence. This turns vague readiness into a prioritized backlog and exposes where a prototype shortcut needs a production control without demanding unrelated complexity.

  • Write a one-sentence outcome statement for SaaS MVP production that a customer and operator both recognize.
  • Give each consequential transition an owner, stable identifier, and causal record.
  • Make the default path safe for asynchronous work, retries, and repeated requests.
  • Keep a human-readable explanation next to the machine decision so support does not guess.

Build A Safe SaaS MVP Production Path

Harden interfaces that cross trust or time. Replace shared accounts with individual identities and roles, move configuration and secrets out of source, validate service-boundary input, make retryable writes idempotent, and version schema changes with a backward-compatible path. Exercise backup and restore; a provider setting alone is not a recovery capability.

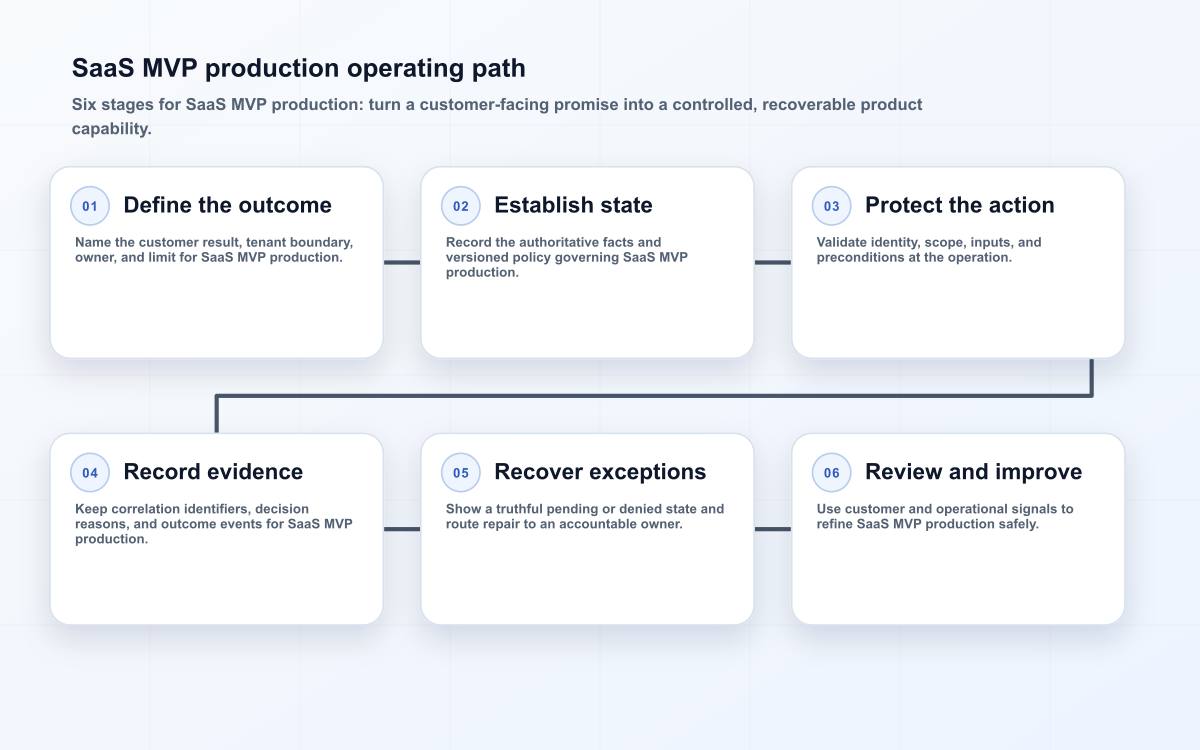

SaaS MVP production operating path
The SaaS MVP production path links an explicit decision to safe delivery, operating evidence, exception handling, and improvement.

SaaS MVP production needs security and reliability controls across the entire path, including administration and background work. Security and reliability apply to the entire path, including administration and background work. OWASP Application Security Verification Standard is a useful verification reference for controls around access, input, and logging where they apply. Fail closed or fail predictably according to the consequence of the action; a friendly message is useful only when it accurately represents a state the customer can recover from.

Failure modeDesign responseCustomer-safe result
Repeated requestUse a stable idempotency key and replay-safe transition.One outcome with the same confirmation on retry.
Delayed dependencyPersist intent and show a pending, inspectable state.Work is not lost and status can be refreshed.
Invalid scopeValidate tenant and actor at the protected operation.Access is denied without exposing another customer's data.
Partial completionRecord the completed step and route a compensating action.The customer sees the next safe action or support route.

Operate And Measure SaaS MVP Production

Name the person who receives alerts, decides rollback, communicates impact, and maintains support handoff. Record deployments, configuration, and significant administration with investigation context. Keep a small set of runbooks for predictable failure, then improve them after use. Production quality is an operating habit.

Track core-journey reliability, deployment frequency and failure, restore tests, access-review completion, customer-impact response, and manual repair time. A growing manual-work queue often shows the next hardening priority better than a polished diagram.

Release SaaS MVP Production With Evidence

Promote through controlled cohorts. Freeze irreversible changes until rollback and support plans exist, enable detailed telemetry for early customers, and review readiness after each cohort. A bounded exposure and evaluation cycle makes the next change safer. Google SRE Workbook: Canarying Releases supports the surrounding practice. Before wider exposure, exercise a meaningful unhappy path and confirm that a named person can find the event, understand the status, and take the documented recovery action.

Test SaaS MVP Production In Real Conditions

A production-readiness exercise is a rehearsal of a normal customer day with one inconvenient interruption. Create a tenant, invite a colleague, make a change that triggers asynchronous work, deploy a compatible update, and then restore the affected record from a tested backup. Confirm that individual identities, audit history, configuration, support handoff, and rollback all behave as the operating model claims. The goal is not to prove the MVP has every enterprise feature. It is to identify the shortest list of controls that keep real customer work safe and recoverable before the next cohort arrives.

Turn the exercise into a repeatable release check for SaaS MVP production. Record the fixture, policy version, expected outcome, observed outcome, and owner for any repair. Keep customer-safe test data separate from production records, but make the sequence close enough to real work that it tests queues, permissions, integrations, and human handoffs together. When the result differs from the design, update the workflow or its documentation before broadening exposure; a known exception is useful evidence only when it changes the next decision.

There is also a governance benefit to this discipline. SaaS MVP production decisions often cross product, engineering, support, security, and commercial responsibilities, so a narrowly defined scenario gives those groups a concrete artifact to review. It makes assumptions visible: which system is authoritative, who can override a state, how long a pending condition may last, and what communication is owed to a customer. That clarity reduces the temptation to solve a production surprise with an undocumented manual change.

Governance And Ownership For SaaS MVP Production

Production governance makes the next shortcut an explicit decision. Maintain a short readiness record for high-consequence changes: data classification, access impact, migration and rollback, observability, customer communication, and operational owner. A founder or product lead does not need to approve every pull request, but someone should decide when a prototype assumption is no longer acceptable for customer work. This gives the team a practical way to invest in controls as risk grows instead of treating production readiness as an all-or-nothing destination.

Make the decision record practical enough to use in normal work. For SaaS MVP production, capture the proposed change, the customer segments affected, the policy or state version, the reviewer, the intended effective time, and the evidence that will confirm or challenge the decision. Link that record to the deployment, support, and operational artifacts rather than burying it in a meeting note. This does not add bureaucracy for its own sake: it gives the person responding to a customer or incident a reliable account of why the product behaved as it did and who can make the next correction.

Ownership also improves learning after release. A weekly review can sample exceptions, unexpected outcomes, and customer questions for SaaS MVP production, then decide whether the next improvement belongs in policy, interface design, automation, documentation, training, or a deeper architectural change. Close the loop by assigning a due date and checking the outcome against the original evidence. Teams gain confidence when they can see that a small operational signal led to a specific, traceable improvement instead of being filed away as an anecdote.

Use a short operational review to keep SaaS MVP production connected to the product's actual conditions. Ask whether the customer promise still matches the enforced behavior; whether the authoritative record can be located quickly; whether the exception route has an accountable owner and expiry; and whether recent support or telemetry evidence reveals an unrepresented state. Review changes in customer segment, plan, region, integration, or role because these often create a valid new case that a narrow initial design did not cover. The outcome should be concrete: confirm the current policy, add a test case, adjust documentation, refine a control, or schedule a larger piece of work. Avoid a meeting that only restates metrics. A review is valuable when it changes a future decision and leaves evidence that the next operator can understand. That discipline turns SaaS MVP production from a one-off implementation into a maintained product capability.

SaaS MVP Production Takeaways

  • SaaS MVP Production should be a product contract, not an informal convention.
  • Keep authoritative state, protected operation, and customer explanation connected.
  • Design retries, missing prerequisites, and partial completion as first-class states.
  • Use telemetry and case evidence to improve the path after release.

SaaS MVP Production FAQ

Where should a team begin? Start with the journey where a poor SaaS MVP production decision creates the most customer confusion, risk, or manual repair. Define its state and evidence before expanding scope. Is a tool enough? No. A product team still owns the boundary, policy, accountable person, and recovery behavior. When is it ready? When the normal path, a meaningful failure, an audit trail, and a safe correction can all be demonstrated.

Conclusion: Make SaaS MVP Production Reviewable

The useful test for SaaS MVP production is simple: can a customer get a truthful answer, can an operator explain the decision, and can the team recover without improvising in production? Build the smallest path that meets that test, observe real cohorts, and refine the model as the product and its obligations grow.

Continue with related articles

Multi-tenant SaaS Architecture: Production Boundaries That Hold

Multi-tenant architecture becomes a production operating model when isolation, noisy-neighbor behavior, support access, migrations, and cost ownership are explicit. This guide helps CTOs make those decisions before scale makes them costly.

Product Engineering · 10 min

How IT Managers Should Think About Product Analytics

A practical product analytics guide for IT managers: define decision-ready events, protect privacy, align telemetry with service outcomes, and keep the operating model trustworthy.

Product Engineering · 12 min
