Device Provisioning Decisions That Matter before the First Build

A practical production guide to device provisioning: define the decision, authority, evidence, controls, and operating signals before expanding a connected workflow.

Krishnam Murarka Updated 2026-07-15 Glossary & FAQs

Device provisioning changes character in production. Before launch, a prototype can show that a device identity can enroll; after launch, an operator must decide what the provisioning record means, who can change it, and how to recover when the expected path breaks. For product teams, the useful question is not which platform is fashionable. It is whether the first production scope can make how a physical device proves its identity, receives only its intended configuration, and can be replaced or retired without leaving trust behind. This guide treats device provisioning as an operating capability: a bounded workflow, an accountable owner, explicit evidence, and feedback that changes the next release.

Set the production boundary for device provisioning

Start with one device type from first power-on through assignment to a customer or site. Write the normal path, the delayed path, and the unsafe path in plain language. Name the device product owner with explicit responsibility from manufacturing through service and decommissioning before configuring software, because a technical component cannot resolve a business disagreement by itself. The boundary should say where device identity begins, which system may create or amend the provisioning record, how long uncertainty is acceptable, and which human role can override a result. That is small enough to rehearse and broad enough to expose missing controls before real work depends on it.

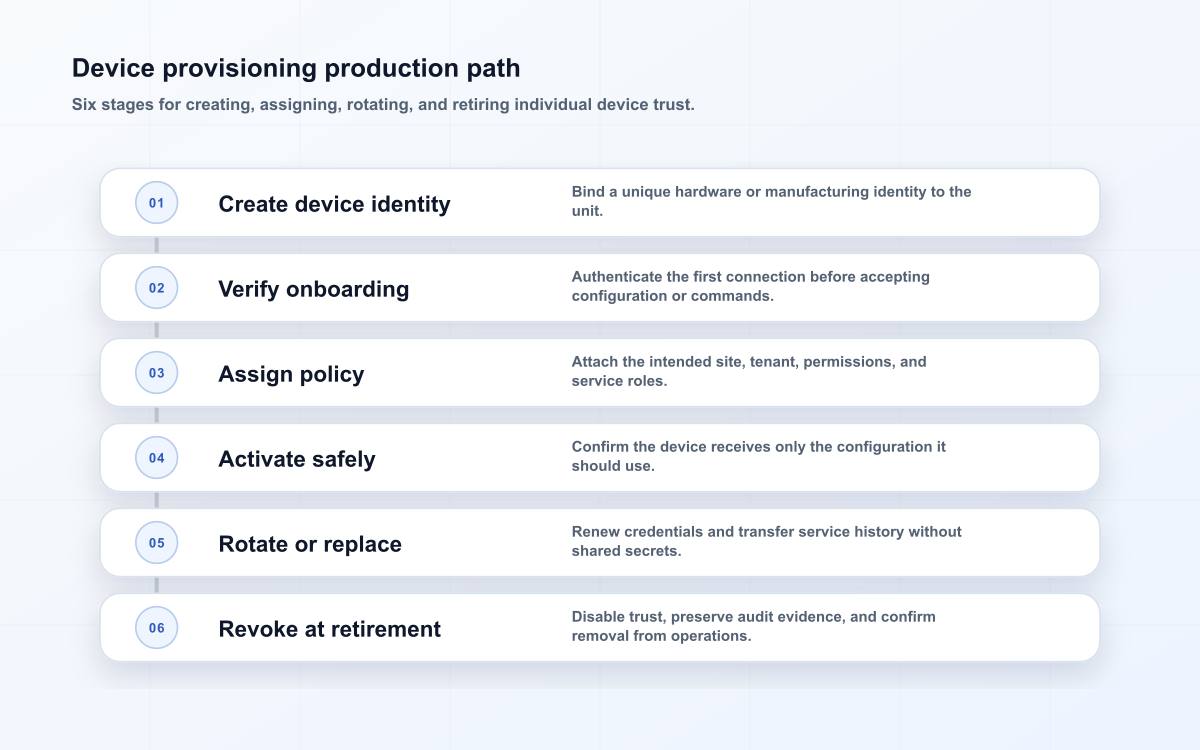

Device provisioning production path
The device provisioning path keeps a device identity accountable through its full lifecycle.
Decision to settleQuestion for the first releaseEvidence to retain
AuthorityWho is permitted to decide how a physical device proves its identity, receives only its intended configuration, and can be replaced or retired without leaving trust behind?Named role, policy version, and decision timestamp
ScopeWhich instance of one device type from first power-on through assignment to a customer or site is included?A concrete inclusion and exclusion rule
DataWhich fields make the provisioning record understandable later?hardware identifier, initial trust anchor, manufacturing batch, enrollment time, assigned tenant or site, credential status, policy version, and retirement state
RecoveryWhat happens when the expected flow is incomplete?Visible exception state, owner, and correction record

Treat the record as more than a payload. A reliable provisioning record preserves enough context for a later reviewer to distinguish a real condition from a late arrival, a duplicate, a configuration change, or an operator correction. The BRSKI bootstrapping specification and NIST IoT device cybersecurity capability baseline are useful anchors for designing contracts and controls, but neither replaces a local decision about safety, availability, or accountability. Keep the business meaning separate from transport convenience: a message being delivered does not prove the underlying work is complete.

Design the device provisioning architecture around decisions

The first architecture diagram should follow the decision, not the vendor boundaries. Show the producer or entry point, validation step, authoritative store, operator surface, and reporting path. For device provisioning, the critical facts are hardware identifier, initial trust anchor, manufacturing batch, enrollment time, assigned tenant or site, credential status, policy version, and retirement state. Decide where each fact is first known, who can correct it, and whether a correction produces a new record or amends an earlier one. This prevents the familiar production surprise in which dashboards, logs, and field staff each have a plausible but incompatible version of the same situation.

  • What action becomes safer, faster, or more accountable when this provisioning record is available?
  • Which identity is being trusted when a device identity attempts to enroll?
  • Which fields are required before an automated action can proceed, and which merely improve later analysis?
  • How is time represented when devices, sites, and services have different clocks or lose connectivity?
  • What can be retried without creating a second operational effect, and what requires human confirmation?
  • Who investigates an exception, and what evidence will let that person reconstruct the sequence?
LayerProduction responsibilityFailure to make visible
Entry and validationAccept only a provisioning record that meets the agreed contract.an installer uses a shared secret or a manual workaround, creating a fleet that cannot be individually authorized, rotated, or confidently revoked
Authority and storagePreserve the source, current state, and corrections with their owners.A convenient replica becomes an accidental source of truth.
Operator experienceShow uncertainty, age, and the next responsible action.Users work around an ambiguous status outside the product.
ObservabilityConnect technical health to the operational decision.A green component dashboard masks delayed or unusable work.

Make the device provisioning operating path explicit

Production readiness is proven by a rehearsed path rather than a successful happy-path demonstration. Run a normal case, a delayed case, a duplicate or conflicting case, and a case where the responsible person is unavailable. Confirm that the person on call can find the provisioning record, identify its source and age, see the policy that applied, and return the workflow to a safe state. Unique credentials, authenticated onboarding, least-privilege policies, protected secrets, revocation, audit records, and a tested replacement process are not a compliance appendix; they are the practical ingredients that make the operating path dependable under ordinary pressure.

Review device provisioning risks as operational failures

The riskiest implementation choice is usually the invisible assumption. In device provisioning, that assumption may concern identity, time, delivery, measurement quality, a local network, or a human handoff. Make it testable. Ask what happens if the upstream system is unavailable, the same input arrives twice, a configuration changed between collection and use, or a technician disputes the status. The OWASP Internet of Things project frames useful security or interoperability concerns; the MQTT Version 5.0 specification helps keep protocol and lifecycle choices grounded in an external specification rather than folklore.

Measure whether device provisioning supports better work

Choose signals that reveal whether the workflow is becoming easier to run. For this capability, monitor enrollment success by batch, duplicate identity attempts, unclaimed-device age, credential rotation completion, failed attestation, and revocation propagation time. Pair quantitative measures with a short weekly sample of real exceptions: what took longest to resolve, which fact was absent, which owner was unclear, and whether a user bypassed the intended system. A lower error count is welcome, but it can be misleading if people stop reporting problems. The better test is whether a new operator can understand the current condition and safely make the next decision without private knowledge.

SignalWhat it can revealReview response
Freshness and completenessWhether the provisioning record arrives with usable context.Trace gaps to the producer, interface, or contract owner.
Exception ageWhether a failure has a clear route to resolution.Escalate unowned or repeatedly reopened cases.
Manual bypassesWhether the designed workflow fits real operational conditions.Observe the workaround before removing it or automating it.
Change and recovery timeWhether device provisioning remains manageable as conditions change.Improve the runbook, test, or ownership boundary that slowed recovery.

Use a staged implementation sequence

First, inventory the actors, systems, and records involved in one device type from first power-on through assignment to a customer or site; do not start by copying every available field. Second, publish the contract and authority rules for hardware identifier, initial trust anchor, manufacturing batch, enrollment time, assigned tenant or site, credential status, policy version, and retirement state. Third, build one observable route through the workflow, including the error and correction states. Fourth, exercise it with production-like timing and permissions. Fifth, train the people who receive exceptions and give them a short decision record rather than a technical diagram alone. Finally, compare the initial signals with the manual baseline and change only the constraint that the evidence exposes. This sequence keeps device provisioning tied to a decision the organization actually needs to make.

Key takeaways for product teams

  • Device provisioning is production-ready when its operational decision and accountable owner are explicit.
  • Keep hardware identifier, initial trust anchor, manufacturing batch, enrollment time, assigned tenant or site, credential status, policy version, and retirement state close to the provisioning record; later reconstruction is a product requirement.
  • Test delayed, duplicated, unavailable, and disputed conditions before broader rollout.
  • Use enrollment success by batch, duplicate identity attempts, unclaimed-device age, credential rotation completion, failed attestation, and revocation propagation time to judge the workflow, not only component uptime.
  • Expand from one device type from first power-on through assignment to a customer or site only after exception handling has become routine and observable.

Device provisioning FAQ

What is the smallest useful first release? It is the release that handles one device type from first power-on through assignment to a customer or site with an explicit owner, trusted record, visible exception path, and one measure of operational value. Should every possible edge case be automated first? No. Classify the edge case, make its safe handling visible, and give a named person a workable recovery route. Who owns quality? The device product owner with explicit responsibility from manufacturing through service and decommissioning owns the operating decision; technical, security, and field teams contribute the controls and evidence that keep it credible. When should the design be revisited? Revisit it after an incident, a material workflow change, a recurring workaround, or a signal that shows rising manual recovery.

Conclusion: make device provisioning dependable in daily operations

Device provisioning earns its place in production when it gives people an honest view of what is known, what is uncertain, and who must act next. Begin with one device type from first power-on through assignment to a customer or site, preserve the context that makes the provisioning record defensible, and rehearse recovery before adding adjacent features. Continue with device provisioning security review, device provisioning practical guide, and device provisioning for founders to deepen the implementation choices around this operating capability.

Continue with related articles

Network Segmentation: Designing Boundaries, Flows, and Exceptions

Network segmentation decisions made before the first build shape security, reliability, support, and recovery for years. This guide helps IT managers choose boundaries, flows, identities, enforcement, and evidence before infrastructure hardens around assumptions.

Glossary & FAQs · 12 min

Network Observability: Mistakes and Fixes

A practical network observability guide for connected estates where operators need to explain reachability, performance, and policy behavior across sites, covering design choices, security controls, operational tests, and accountable recovery.

Glossary & FAQs · 10 min
