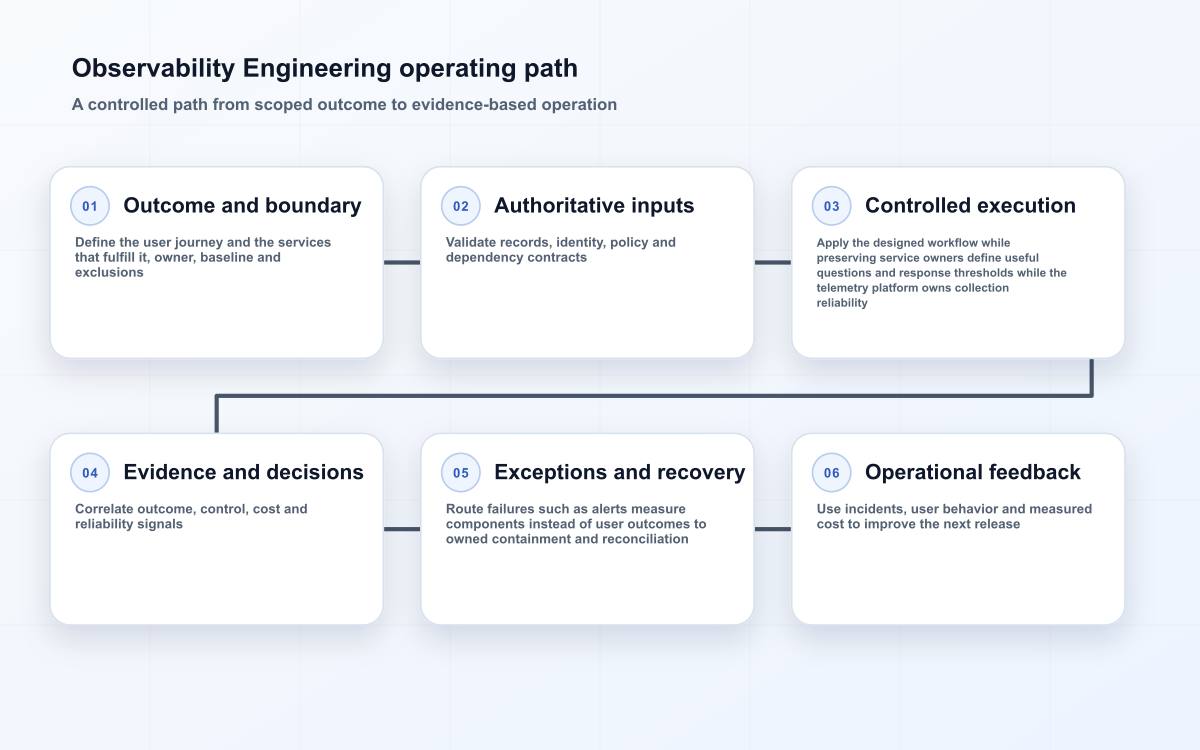

Observability Engineering is valuable only when it improves a named operating outcome and leaves behind a service that people can govern. The practical unit of scope is the user journey and the services that fulfill it. That framing exposes data, identity, integration, controls, people and provider dependencies that a tool list misses. It also makes trade-offs reviewable: leaders can decide what authority changes, what evidence proves readiness, what remains outside scope and what must happen when the new path fails.
Define the outcome and service boundary
Start with questions operators must answer: which users are affected, where time is spent, what changed, whether data is wrong and which dependency is failing. Tool acquisition is not an observability strategy. Scope should name the current baseline, target behavior, affected users, authoritative records and material failure consequences. It should also identify exclusions. A bounded first release can exercise the full path without pretending to solve every adjacent process. The accountability model is equally important: service owners define useful questions and response thresholds while the telemetry platform owns collection reliability. Record that boundary in the service design and acceptance criteria, not only in a presentation.
Discovery should trace several real cases from start to finish, including delayed, disputed and high-risk examples. Interviewing leaders reveals policy; observing operators reveals how work actually completes. Inventory applications, data stores, identities, scheduled jobs, third parties, manual handoffs and calendar constraints. For each dependency, record an owner, expected behavior, failure signal and continuity method. This produces an evidence-backed scope and a list of unknowns that can be priced and retired. For observability, sample uncorrelated signals and incident-specific diagnostic gaps explicitly.
| Scope question | Decision evidence | Acceptance signal |
|---|---|---|
| Outcome | Baseline, target and accountable owner | A measurable change tied to a real user or operation |
| Authority | Decision rights and system-of-record boundaries | No critical state or approval has two owners |
| Failure | Impact, fallback and recovery objective | Teams can complete or safely pause the workflow |
| Change | In-scope population, exclusions and rollback | The first release is bounded and reversible |
Design the operating architecture
Use metrics for trends and alerting, traces for request paths, logs for event detail and profiles for code-level resource use. Correlation identifiers and consistent resource attributes make the signals mutually explanatory. Architecture is not only a component diagram. It is a set of contracts about state, authority, access, timing and failure. Define inputs and outputs, versions, retry behavior, reconciliation, audit events and the point at which responsibility changes hands. Prefer managed or shared capabilities when their operating boundary is understood; keep custom logic where the business rule or control genuinely differentiates the service.

Define service-level indicators at the user-visible boundary. Availability, latency and correctness should reflect completed outcomes; component health can support diagnosis but should not masquerade as the service objective. Security and privacy belong in those contracts. Separate human, service, privileged and emergency identities; minimize access; protect secrets; classify data; set retention; and test authorization at the action boundary. Logging must preserve enough provenance to investigate decisions without creating a new uncontrolled copy of sensitive content. Threat modeling should cover abuse, dependency compromise, configuration drift and recovery, then assign each treatment to an owner.
Build an evidence model, not a dashboard collection
Instrument context deliberately. High-cardinality attributes can be diagnostically powerful and financially expensive; secrets, personal data and unbounded payloads should not enter telemetry by default. Evidence should connect an observed condition to a decision. Define each measure with a formula, source, population, timing, owner and known limitation. Pair outcome measures with leading indicators such as exception age, failed controls, backlog, saturation or unsupported cases. Counts without denominators and averages without distributions can conceal concentration; use segmented results where user, workload or risk differences matter.
Keep provenance from source through transformation to report. Version definitions and disclose material changes. A control result should identify what was tested, when, against which configuration and by whom. An operational signal should route to someone able to act. Review unused dashboards and noisy checks as debt: evidence that does not change a decision still consumes attention and cost, and it may create false confidence during an incident. Here, preserve resource attributes, trace context and instrumentation versions.
Model cost across discovery, change and operation
No universal price or timeline is credible for a observability program. Estimate ranges from inspected evidence and separate one-time delivery, transition and recurring operation. Major cost drivers include instrumentation and semantic-convention work; collectors, storage, query and retention; high-cardinality dimensions and trace sampling; dashboard and alert maintenance; privacy review and access controls; and incident training and platform support. Show volume, retention, availability, staffing, licensing and growth assumptions beside the numbers. Reforecast after discovery and the proof slice because uncertainty should decline as the team learns.
| Cost layer | What to estimate | Evidence to request |
|---|---|---|
| Discovery | instrumentation and semantic-convention work; collectors, storage, query and retention | Inventories, samples, interviews and dependency maps |
| Build | high-cardinality dimensions and trace sampling; dashboard and alert maintenance | Backlog, interface contracts, test scope and environments |
| Assurance | privacy review and access controls | Control mapping, evaluation plan and remediation allowance |
| Run and exit | incident training and platform support | Consumption model, support rota, retention and export plan |
Include internal labor and operational disruption, not just supplier invoices. Dual running, migration rehearsal, data repair, support training, audit participation and decommissioning are often real work even when absent from a proposal. Unit costs should follow the service's natural volume so growth can be explained. Contingency should correspond to documented unknowns, with a plan to resolve each one, rather than appear as an unexplained percentage. Budget specifically for telemetry ingestion, retention and on-call maintenance.
Control the risks that shape delivery
The primary risks are concrete: alerts measure components instead of user outcomes; signals cannot be correlated; telemetry leaks sensitive data; sampling removes rare failures; collector failure hides an outage; and retention grows without diagnostic value. Put each risk beside an early indicator, treatment, owner and stop threshold. Risk acceptance belongs to someone with authority over the consequence. Supplier assurances can inform due diligence, but they do not replace testing of the customer's configuration, workflow and shared-responsibility boundary.
| Risk | Early evidence | Practical treatment |
|---|---|---|
| alerts measure components instead of user outcomes | A representative case cannot be traced end to end | Map the path with operators and test the missing dependency |
| signals cannot be correlated | Access, policy or ownership differs across environments | Automate the baseline and review exceptions with expiry |
| telemetry leaks sensitive data | Measured behavior diverges from the planning assumption | Set a threshold, investigate by segment and reforecast |
| sampling removes rare failures | Recovery or reconciliation cannot restore trusted state | Rehearse rollback and preserve authoritative evidence |
| collector failure hides an outage | Queue age or manual work rises during the pilot | Limit the wave and strengthen ownership and runbooks |
| retention grows without diagnostic value | Exit or substitution cannot be demonstrated | Test export, revocation, portability and continuity before scale |
Use a staged, reversible delivery plan
Design collection as production infrastructure. Buffering, backpressure, sampling, schema evolution, retention and regional routing determine whether evidence survives the incident that needs it. A sound sequence is: frame the outcome and authority; discover real paths and dependencies; design contracts and controls; prove a thin end-to-end slice; pilot with a bounded population; expand only when thresholds hold; and retire old paths after consumers, records and obligations are reconciled. Every gate needs a decision maker and current evidence. Schedule pressure is not evidence that the next wave is safe.
- Frame: approve the outcome, owner, boundary, baseline, risk tolerance and exclusions.
- Discover: inspect representative cases, dependencies, data, permissions, controls, volumes and failure history.
- Design: document authority, contracts, security, evidence, recovery, support and cost assumptions.
- Prove: exercise the complete path with realistic data, failures, reconciliation and rollback.
- Pilot: limit exposure, increase review frequency and measure user and operational behavior.
- Expand: add scope only while outcome, control, cost and support thresholds remain acceptable.
- Retire: remove obsolete access, jobs, copies, contracts and runbooks after verified reconciliation.
Connect every actionable alert to ownership, a first diagnostic view and an escalation path. Review incidents and unused telemetry together so the system learns while cost remains attached to value. Production readiness should be demonstrated by the people who will operate the service. Run a simulation that includes an ambiguous case, a dependency failure and an access problem. Observe whether teams can establish authority, protect data, communicate impact, preserve evidence and recover without uncontrolled edits. Feed gaps back into architecture, training and support. This is more revealing than a checklist signed before operators see the actual service.
Implementation review checklist
| Review area | Questions before expansion | Required artifact |
|---|---|---|
| Business | Did the target outcome improve for the pilot population? | Baseline comparison and owner decision |
| Data | Are authority, quality, lineage and retention understood? | Data contract and reconciliation result |
| Security | Do least privilege, logging and response work in practice? | Access review and scenario evidence |
| Operations | Can support identify, contain and recover failures? | Runbook exercise and open-gap register |
| Commercial | Do measured unit costs and provider duties match assumptions? | Updated forecast and responsibility matrix |
| Change | Can the team roll back and retire old paths safely? | Rollback result and decommission plan |
Key takeaways
- Scope the user journey and the services that fulfill it, not a product label.
- Make authority, evidence and failure behavior explicit before implementation.
- Estimate instrumentation and semantic-convention work, dashboard and alert maintenance and ongoing incident training and platform support alongside build work.
- Treat alerts measure components instead of user outcomes and sampling removes rare failures as testable delivery risks.
- Expand through bounded waves with reconciliation, recovery and operational gates.
Frequently asked questions
Where should a observability program start?
Start with one important outcome and several representative cases. Name the owner, current baseline, users, systems of record, failure consequence and first reversible boundary. Then inspect enough real work to identify dependencies and exceptions before selecting tooling or committing to a portfolio timeline. A credible opening boundary is one user journey with a service-level indicator.
How should cost be estimated?
Use a bottom-up range built from volumes, interfaces, environments, data condition, assurance depth, service objectives and support coverage. Separate discovery, implementation, transition and recurring operation. State assumptions, price the work needed to close unknowns and reforecast after the proof slice produces measured evidence. The main sizing variables are event volume, cardinality, sampling and retention.
What should be checked when selecting a provider?
Check functional fit, architecture, data handling, security, resilience, audit access, subcontractors, service management, pricing behavior and exit. Map every material responsibility to customer, provider or another party. Test a representative normal path and failure path rather than relying on a generic demonstration or certification. Require evidence for collector behavior, semantic compatibility and data egress.
How should success be measured after launch?
Use the original outcome plus correctness, control effectiveness, reliability, exception age, user behavior, recovery performance and unit cost. Segment results where averages hide important populations. Delivery milestones show that work shipped; they do not prove that the service became safer, faster or more useful. Prioritize SLO performance, alert actionability and diagnosis time.
Conclusion
Observability Engineering should leave an organization with more than configured technology. It should create an owned service boundary, trustworthy evidence, operable controls and a realistic path for change. The disciplined approach is to begin with a consequential but bounded outcome, discover the real dependencies, design authority and failure behavior, prove the full path and expand only when operational evidence supports the decision.
That discipline also improves commercial judgment. Costs become connected to inspected work, supplier duties become explicit and risks become conditions the team can test. Most importantly, the organization retains the ability to pause, recover, reconcile and learn. A observability program is successful when the changed capability can be understood and operated under ordinary pressure as well as during the failure that planning hoped would never occur.
