Multi-Tenant SaaS Architecture Managed Services: Scope, Controls and Delivery Plan starts with a deceptively simple question: what must the organization be able to decide, change and prove after delivery? For SaaS CTOs, platform leaders, product engineers, security teams and service managers, the useful answer is not a product list. A managed service for multi-tenant SaaS architecture should operate a shared tenant fleet reliably while preserving isolation, product velocity and accountable engineering ownership. That requires an explicit service boundary, architecture decisions, control ownership, acceptance evidence and an operating loop. The guide below turns those concerns into a practical plan while leaving regulatory, contractual and risk conclusions to qualified owners in the relevant organization and jurisdiction.
Key takeaways
- Define scope through tenant catalog, identity, control plane, shared and siloed resources, data partitions, deployment stamps, integrations, telemetry, support and tenant lifecycle, not through a vendor catalog.
- Choose among shared operations with product-team escalation, co-managed platform and reliability engineering, managed fleet operations with retained architecture authority, specialist isolation and compliance operations according to risk, workload and retained ownership.
- Treat tenant-context propagation and authorization, policy-tested provisioning and offboarding, progressive fleet deployment with rollback, tenant-aware telemetry and privileged-support controls as design inputs and acceptance conditions.
- Require tenancy model and isolation tests, tenant catalog and lifecycle records, deployment cohort results, per-tenant service telemetry, incident, access and change records before declaring transition or implementation complete.
- Measure tenant-isolation tests passing, fleet versions and configuration drift, service objectives by tenant tier, noisy-neighbor saturation signals, failed lifecycle operations and repair age with stable definitions and named owners.

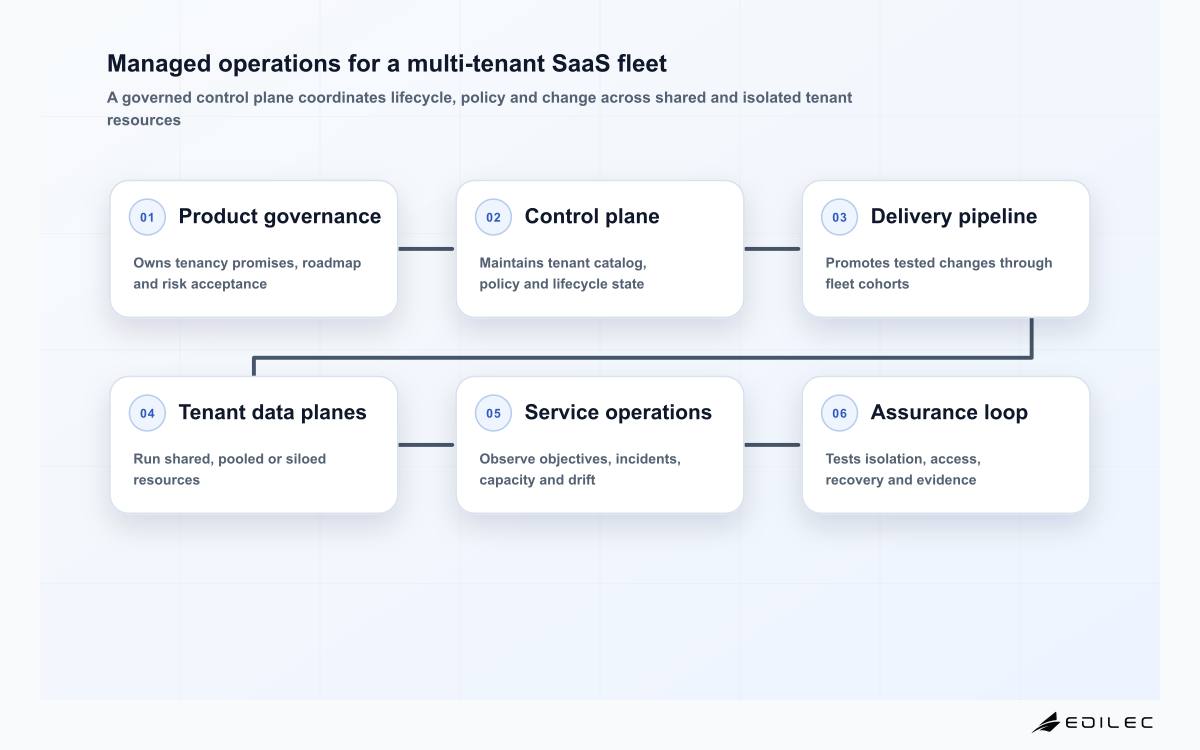

Define the capability and service boundary
Begin by mapping tenant catalog, identity, control plane, shared and siloed resources, data partitions, deployment stamps, integrations, telemetry, support and tenant lifecycle. The map should identify which team owns each decision, which system is authoritative, what information crosses the boundary and what happens when a dependency is unavailable. This prevents a familiar procurement failure: the statement of work names activities, but nobody can connect those activities to a user journey, business service or material risk. Scope representative flows end to end, including exception, recovery and retirement paths; the happy path alone cannot reveal where operational responsibility actually sits.
Write exclusions as carefully as inclusions. For every excluded component, record the dependency, continuing owner, required interface and escalation route. A boundary is credible only when adjacent teams agree with it. During discovery, separate confirmed evidence from assumptions and unresolved decisions. That distinction protects planning quality: an assumption can carry a due date and owner, while an undocumented guess silently becomes architecture. Use tenancy model and isolation tests and tenant catalog and lifecycle records as early artifacts because they expose gaps before implementation cost and organizational commitment increase.
Choose architecture from explicit tradeoffs
The credible options are not “modern” versus “legacy.” They include shared operations with product-team escalation, co-managed platform and reliability engineering, managed fleet operations with retained architecture authority and specialist isolation and compliance operations. Evaluate each against isolation, failure containment, latency, consistency, data handling, operational skill, portability and change frequency. A design can be technically valid yet wrong for the operating organization. Record why an option was selected, what it makes harder, which assumption could invalidate it and who may revisit the decision. This turns architecture into governed reasoning rather than a diagram that ages without explanation.

For a managed service for multi-tenant SaaS architecture, design failure behavior before optimizing the normal path. Ask what is retried, what is idempotent, what can be partially completed, where state is authoritative and how an operator knows the difference between delayed, failed and absent work. Define capacity and dependency limits without inventing precision that available evidence cannot support. Representative tests should cover malformed input, stale identity, unavailable dependencies, duplicate requests and interrupted change. The goal is bounded behavior across tenant catalog, identity, control plane, shared and siloed resources, data partitions, deployment stamps, integrations, telemetry, support and tenant lifecycle: failures should be visible, diagnosable and recoverable without creating a second uncontrolled process.
Turn controls into enforceable behavior
Controls are useful only when the system and operating process make them observable. Start with tenant-context propagation and authorization and policy-tested provisioning and offboarding; then add progressive fleet deployment with rollback and tenant-aware telemetry and privileged-support controls. For each control, identify the threat or obligation addressed, enforcement point, accountable owner, evidence source, failure signal and exception path. Policy language such as “access is restricted” is incomplete. A testable statement names the protected resource, permitted actor, decision context, denied cases and retained audit event.
Apply least privilege throughout a managed service for multi-tenant SaaS architecture to people, workloads and support processes. Separate read, change, approval and emergency privileges; avoid shared accounts and permanent provider access. Sensitive production data should not be copied merely because it is convenient for troubleshooting. Define masking, sampling, retention and deletion rules before access begins. Logging must support investigation without becoming an ungoverned replica of secrets or personal data. Finally, test revocation, recovery and exception expiry against tenant-aware telemetry and privileged-support controls: controls often look strongest at onboarding and weaken during change or offboarding.
| Control area | Implementation question | Proof to retain |
|---|---|---|
| Identity and authorization | Where are tenant-context propagation and authorization and policy-tested provisioning and offboarding enforced? | Positive and negative access tests plus reviewed assignments |
| Data handling | How does progressive fleet deployment with rollback apply to collection, use and deletion? | Data flow, configuration and deletion verification |
| Change safety | How are validation, approval and rollback separated? | per-tenant service telemetry with correlated deployment records |
| Detection and response | How does tenant-aware telemetry and privileged-support controls behave under a realistic scenario? | incident, access and change records plus exercise actions |
| Exceptions | Who accepts, expires and rechecks a deviation? | Exception record with scope, owner, compensating control and review date |
Deliver in evidence-producing waves
A practical delivery plan moves through discovery, baseline, design, proof, controlled rollout and operational acceptance. Discovery validates scope and access. Baseline establishes current behavior with tenancy model and isolation tests and tenant catalog and lifecycle records. Design records target decisions and control tests. A proof wave then exercises one representative path from implementation through failure and recovery. Only after that evidence is reviewed should the team expand to additional systems, tenants, feeds or workflows. This sequence reduces uncertainty early without pretending that a prototype proves fleet-wide readiness.
Each a managed service for multi-tenant SaaS architecture wave needs entry criteria, test data, change authority, rollback conditions and an accountable acceptance decision. Track dependencies and waiting time separately from active engineering effort so schedule discussions remain honest. When urgent exposure is found, route it through the incident or emergency-change process instead of waiting for the final report. At handover, use shadow and reverse-shadow work around incident, access and change records: the receiving team first observes, then performs the task while the delivery team observes. Documentation is necessary, but demonstrated operation is stronger evidence of transfer.
| Stage | Primary work | Exit evidence |
|---|---|---|
| Discover | Confirm journeys, owners, systems, data and obligations | tenancy model and isolation tests |
| Baseline | Observe current configuration, behavior and failure modes | tenant catalog and lifecycle records |
| Design | Record target decisions, controls and tests | deployment cohort results |
| Prove | Implement one representative path and exercise recovery | per-tenant service telemetry |
| Scale | Roll out in bounded cohorts while monitoring guardrails | tenant-isolation tests passing and fleet versions and configuration drift |
| Accept | Revoke temporary access and demonstrate normal and emergency operation | incident, access and change records |
Estimate cost and commercial scope responsibly
The cost of a managed service for multi-tenant SaaS architecture is driven by uncertainty and operating diversity more than by a generic label. Important drivers include the number and variety of in-scope flows, environments, identities, data classes, integrations, inherited components, control mappings and support windows. Documentation quality, automated tests, representative non-production environments and deployment repeatability can reduce discovery and validation effort. Conversely, unclear ownership across tenant catalog, identity, control plane, shared and siloed resources, data partitions, deployment stamps, integrations, telemetry, support and tenant lifecycle, undocumented interfaces and bespoke exceptions create work that a simple unit price cannot honestly represent.
For a managed service for multi-tenant SaaS architecture, separate discovery, implementation, validation, transition and continuing operation in the commercial model. State assumptions and customer responsibilities, including access, subject-matter participation, change windows and acceptance turnaround. Fixed scope can fit a bounded assessment or well-understood migration wave; uncertain remediation benefits from stage gates and refreshed estimates. Avoid incentives based only on tickets closed, findings counted or hours consumed. Payment milestones should correspond to per-tenant service telemetry and usable capability, while risk acceptance remains with an authorized organizational owner.
Operate with service and risk signals
Operating measures should answer whether the capability is dependable and whether exposure is changing. Use tenant-isolation tests passing, fleet versions and configuration drift, service objectives by tenant tier, noisy-neighbor saturation signals and failed lifecycle operations and repair age. Define every numerator, denominator, time window, data source and owner. A percentage without a stable population can improve merely because scope shrank. Pair aggregate trends with a short narrative about material exceptions and decisions. Teams should be able to move from a dashboard signal to the affected service, evidence and owner without assembling a manual investigation each reporting cycle.
For a managed service for multi-tenant SaaS architecture, balance reliability, security, delivery and user impact. A control that repeatedly blocks legitimate work may be bypassed; a performance optimization that removes deployment cohort results may weaken investigation; a change freeze that protects one metric may leave known vulnerabilities unresolved. Review tenant-isolation tests passing, fleet versions and configuration drift, service objectives by tenant tier, noisy-neighbor saturation signals, failed lifecycle operations and repair age together and agree guardrails before rollout. Incidents, support demand, rejected actions and near misses are learning inputs, not merely counts. Feed resulting actions into one prioritized backlog so reliability, product and risk work compete transparently for capacity.
Recognize delivery risks early

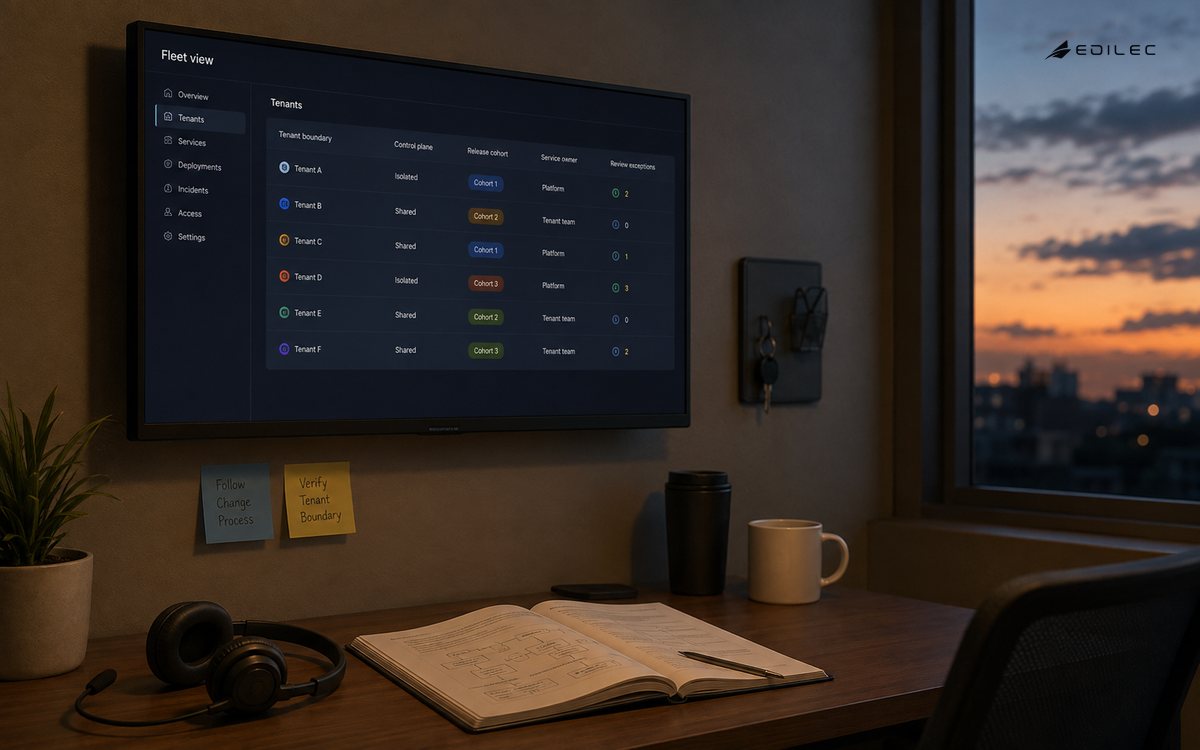

The most damaging risks in a managed service for multi-tenant SaaS architecture are often visible before implementation: infrastructure-only scope, fleet-wide change, opaque provider access, custom tenant forks. Wider warning signs include absent owners, unavailable test data, overbroad access and acceptance postponed until a final presentation. Treat those signs as delivery risks with owners and response dates. The table below turns them into evidence-based review prompts for the actual environment, not universal claims.
| Risk | Early signal | Response |
|---|---|---|
| Infrastructure-only scope | Application isolation and control-plane logic are ignored | Include code, identity, data and lifecycle responsibilities |
| Fleet-wide change | One release reaches every tenant simultaneously | Deploy through rings or stamps with tenant-aware rollback |
| Opaque provider access | Support can assume tenant context without control | Use just-in-time access, approval and immutable audit events |
| Custom tenant forks | Operations cannot patch the fleet consistently | Keep variation declarative and govern exceptions |
Frequently asked questions
What should be completed first for a managed service for multi-tenant SaaS architecture? Complete the service boundary across tenant catalog, identity, control plane, shared and siloed resources, data partitions, deployment stamps, integrations, telemetry, support and tenant lifecycle, name decision owners and trace one representative end-to-end flow. Those artifacts expose hidden dependencies and let the team choose a proof wave. Buying or configuring technology before this point can accelerate activity while leaving the central responsibility question unanswered.
How much documentation is enough? Keep documents that support a decision, implementation, test or operating task. At minimum, retain tenancy model and isolation tests, tenant catalog and lifecycle records, deployment cohort results, per-tenant service telemetry, incident, access and change records. Prefer versioned artifacts close to the system and automate evidence collection where it remains understandable. A large static repository is not proof that the current system behaves as described.
Can a provider own all risk in a managed service for multi-tenant SaaS architecture? A provider can perform tenant-context propagation and authorization, policy-tested provisioning and offboarding, progressive fleet deployment with rollback, tenant-aware telemetry and privileged-support controls and accept contractual responsibilities, but the organization still needs authorized owners for business outcomes, regulatory interpretation, residual risk and priority. Shared responsibility should be decomposed into named decisions and evidence; the word “shared” alone does not assign work.
When is a managed service for multi-tenant SaaS architecture ready to scale? Scale after the representative wave passes functional, security, failure, recovery and operational acceptance tests, and after the team has observed tenant-isolation tests passing, fleet versions and configuration drift, service objectives by tenant tier, noisy-neighbor saturation signals, failed lifecycle operations and repair age. A successful demonstration on clean sample data is useful learning, but it does not establish production readiness across the diverse scope named in this guide.
Which related guides add useful context? See multi-tenant architecture: a practical guide for operations teams, Multi-Tenant SaaS Architecture: Isolation, Control Planes and Operations, multi-tenant architecture checklist for internal operations, Admin Consoles: Buyer and CTO Guide. These are published repository records selected for adjacent architecture, implementation, control or operating concerns; they are not evidence for claims in this guide.
Conclusion
Multi-Tenant SaaS Architecture Managed Services: Scope, Controls and Delivery Plan is ultimately an ownership and evidence problem expressed through technology. Define tenant catalog, identity, control plane, shared and siloed resources, data partitions, deployment stamps, integrations, telemetry, support and tenant lifecycle; choose architecture through explicit tradeoffs; implement tenant-context propagation and authorization, policy-tested provisioning and offboarding, progressive fleet deployment with rollback, tenant-aware telemetry and privileged-support controls; and accept delivery through tenancy model and isolation tests, tenant catalog and lifecycle records, deployment cohort results, per-tenant service telemetry, incident, access and change records. That discipline gives SaaS CTOs, platform leaders, product engineers, security teams and service managers a common basis for procurement, engineering and operation. It also keeps improvement practical: each incident, exception and delivery wave can update the same service map, decision records, tests and backlog instead of creating a parallel governance exercise.
