Edge Gateways Checklist for Reliable Digital Operations

Use this edge gateways checklist to verify local authority, identity, buffering, time, synchronization, recovery, and support before a connected site depends on a gateway in daily operations.

Krishnam Murarka Updated 2026-07-14 Glossary & FAQs

Edge gateways are deployed where systems meet the physical world: sites with unreliable links, proprietary protocols, constrained power, safety constraints, and technicians who cannot simply restart a service from a terminal. The right gateway architecture is shaped by that site reality. It must decide which work stays local, what can wait for the cloud, how data survives an outage, how updates are staged, and how support can diagnose a failure without opening an unsafe administration path.

Edge Gateway Checklist: State the Site Decision

Timestamp semantics, device-defender audit checks, the IoT Edge security manager, and control-assessment guidance provide the evidence model for site acceptance, lifecycle control, and review. Date and Time on the Internet: Timestamps; AWS IoT Device Defender audit checks; Azure IoT Edge security manager; SP 800-53A Rev. 5: Assessing Security and Privacy Controls.

Control areaWhat to specifyEvidence to review
PurposeFor a site acceptance checklist, state the operational decision, user, completion evidence, and cost of a wrong result. At the gateway opening, name the boundary instead of inheriting a default setting.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the purpose rule works in production conditions.
AuthorityGateway acceptance: name the system, role, or device that may create or correct this record. At the identity boundary, document the permitted authority instead of relying on a default.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the authority rule works in production conditions.
TimeKeep observation time, handling time, and review deadline distinct and visible. For gateway timing, show where observation ends and accountable handling begins.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the time rule works in production conditions.
ChangeGateway acceptance: version the contract or rule and publish a migration and rollback decision. Tie each version change to an explicit gateway boundary and owner.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the change rule works in production conditions.

Edge Gateway Checklist: Define the Authoritative Record

Separate local control and safety functions from work that can tolerate cloud loss. Use durable local queues or stores with defined bounds, backpressure behavior, and a reconciliation plan. Give the gateway a stable identity, record configuration and software version, and distinguish source event time from upload time. Offline sync is relevant when local work must later merge with a central record; the merge rules should be designed before field deployment.

Edge Gateway Checklist: Turn Controls Into Tests

Use signed, staged updates and a rollback decision that considers both software health and workflow state. Restrict local administrative interfaces, protect secrets, and segment local device networks from business or management networks. Define what happens when storage fills, time drifts, a protocol adapter fails, or upstream authentication expires. Health checks should exercise the meaningful path, such as reading a required protocol or delivering a bounded message, rather than only proving that a workflow exists.

Control areaWhat to specifyEvidence to review
FailureFor a site acceptance checklist, describe the safe response to loss, delay, duplication, malformed input, and access denial. During link loss, keep the local boundary visible to the operator.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the failure rule works in production conditions.
EvidenceFor a site acceptance checklist, retain identity, correlation, configuration, result, and accountable owner for investigation. The evidence record should identify the gateway boundary that produced it.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the evidence rule works in production conditions.
ReleaseFor a site acceptance checklist, test representative field conditions, permissions, degraded connectivity, and recovery before scale. Make the site test prove which gateway actions remain local.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the release rule works in production conditions.
ReviewFor a site acceptance checklist, measure decision impact, exception burden, and unresolved work; assign the next improvement. Use the review to tighten the gateway boundary where operators hesitate.For a site acceptance checklist, A named owner, an example record, and a repeatable test that shows the review rule works in production conditions.

Edge Gateway Checklist: Operate on Fresh Evidence

A remote fleet needs asset-level observability. Capture heartbeat, power and storage state, connectivity, software and configuration version, adapter health, queue depth, and update outcomes. Group indicators by site and operational role so support can prioritize an impaired plant over a lab device. Test recovery with the same connectivity and access constraints that technicians face. The useful standard is not zero incidents; it is knowing which gateway is impaired, what service is affected, and the next safe action.

Edge Gateway Checklist: Expand With Review Evidence

For a site acceptance checklist, use a limited rollout that includes representative assets, roles, connectivity, and exception cases. For edge gateways, publish the success measure, a containment trigger, and the person allowed to pause the change. For a site acceptance checklist, review observed behavior with the people who perform the work, then update the operating record, test fixtures, and recovery guidance. For a site acceptance checklist, A feature is not mature because it is deployed; it is mature when a new operator can understand the boundary and a support owner can resolve a failure without guessing.

A deeper edge gateways review should connect site constraints, local continuity, and remote recovery. Rehearse a site outage with the actual gateway hardware or a faithful environment: remove the upstream link, constrain storage, interrupt power during a noncritical operation, and attempt a controlled recovery. Confirm which functions continue locally, what facts are queued, and how a support engineer can identify the exact state without weakening the management boundary. This is where a diagram becomes a viable field procedure. For a site acceptance checklist, keep the review concrete by naming the records, people, assets, and time windows involved. For a site acceptance checklist, it is tempting to call an architecture sound because its normal path is tidy, but operational confidence comes from explaining an incomplete path: a message that arrived after a decision, a device that was replaced, a technician who worked offline, or a credential that should no longer work. For edge gateways, record the observed result, the expected result, the owner who decides the difference, and the smallest corrective action. For a site acceptance checklist, that creates a reusable acceptance test for the next release and prevents a local workaround from quietly becoming a permanent rule. For a site acceptance checklist, review this evidence with engineering and the people who carry the operational consequence. For a site acceptance checklist, when their accounts disagree, preserve both facts and resolve the authority rather than smoothing the difference in a dashboard or export. The goal is not perfect data. For a site acceptance checklist, it is a system that tells people when its evidence is incomplete, states which record remains authoritative, and gives them a safe accountable way to respond.

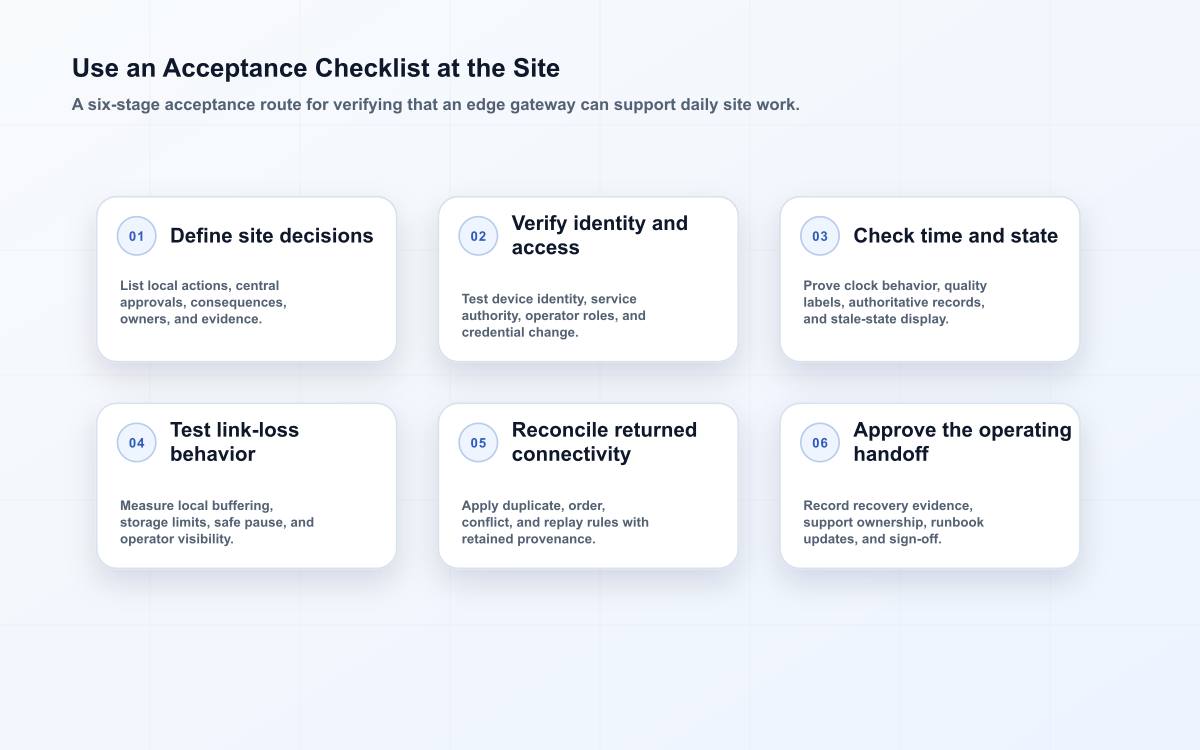

Use an Acceptance Checklist at the Site

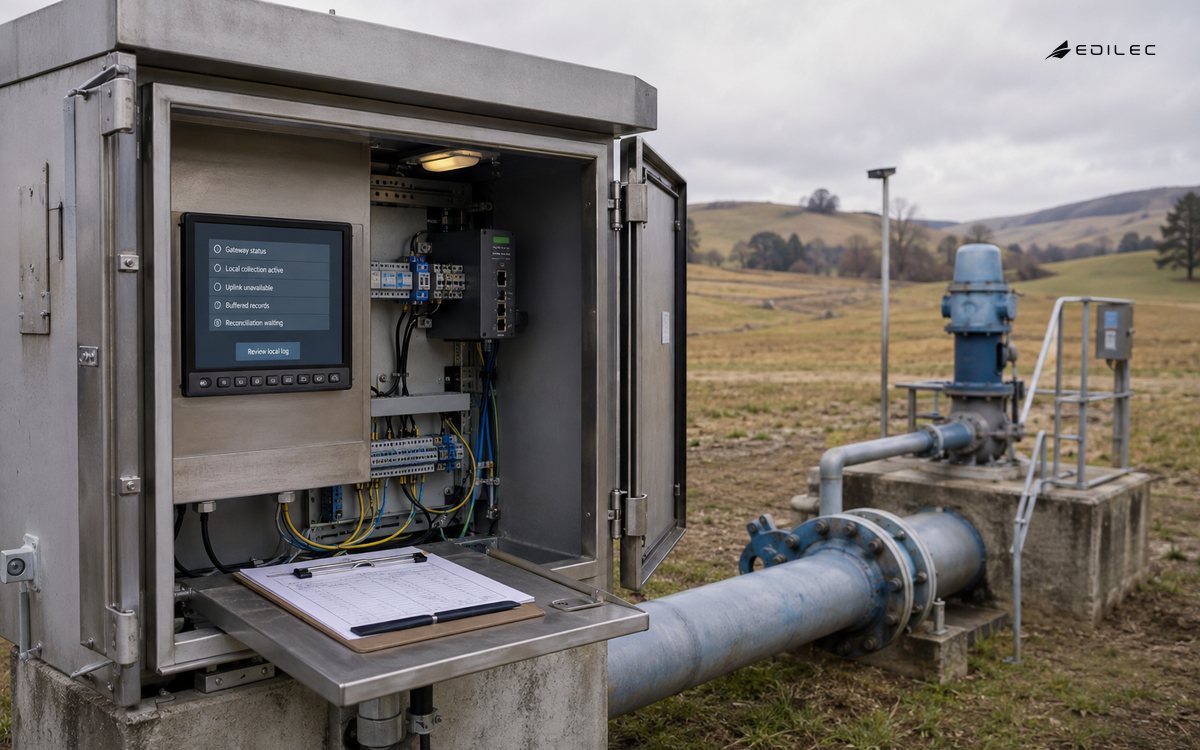

Example: Verify a Remote Pump Station Gateway

Use an Acceptance Checklist at the Site
Edge gateway reliability checklist path linking site authority, identity, time, link-loss behavior, reconciliation, and operator approval.

For a remote pump station, start the checklist with the decisions that must remain safe during a six-hour link outage. The gateway may continue collecting pressure and run-state signals, but a remote start command may require central confirmation or local operator presence. Record that distinction beside the topic, protocol, or service rule that enforces it. A checklist is useful when it names evidence and an owner, not when it merely lists components.

Check time as carefully as storage. A gateway that preserves every record but cannot explain when the pump changed state will complicate reconciliation and incident review. Define the clock source, drift tolerance, behavior during clock loss, and the fields that carry observed, received, and applied times. Use a consistent timestamp format such as the one described in RFC 3339.

Finish with a recovery walk-through. Remove upstream connectivity, fill the local queue to its threshold, restart the gateway, restore the link, and compare the central result with the physical log. The outcome should show what was retained, what was marked uncertain, what was replayed, and who approved any manual correction.

The MQTT Version 5.0 specification informs device messaging behavior; RFC 8446 is the authoritative TLS 1.3 reference; RFC 3339 supports unambiguous timestamps; and NISTIR 8259A provides a device cybersecurity baseline.

Use the offline-sync planning guide, the edge-gateway field guide, and the device-identity primer to turn this checklist into a repeatable site review. For a site acceptance checklist, Edge Gateways: An Implementation Checklist That Holds Up clarifies one boundary; Edge Computing: Buyer and CTO Guide adds a complementary operating pattern; and Offline Sync: Hands-on Planning Guide helps connect the decision to a wider connected-systems workflow.

Edge Gateway Checklist Key Takeaways

  • Design edge gateways from real site constraints, not only cloud architecture diagrams.
  • Keep safety and time-critical work local when cloud dependency would create unacceptable risk.
  • Bound local storage, queues, and reconciliation so outages are survivable and explainable.
  • Stage signed updates with observability and a workflow-aware rollback plan.
  • Operate every gateway as a known asset with a site, owner, version, and health record.

For deeper acceptance and lifecycle context, compare this checklist with Sensor Data Pipelines Checklist for Reliable Digital Operations, Firmware Updates Checklist for Reliable Digital Operations, and The Plain-language Guide to MQTT Brokers. The checklist is complete when a site operator can explain the authoritative record, the current state, and the safe next step during a disconnected period.

Edge Gateway Checklist FAQ

How Much Local Gateway Data Is Enough?

Store enough to bridge expected outages and support recovery, with an explicit retention and backpressure policy. The amount follows message volume, decision criticality, storage durability, and how safely the system handles a full disk.

Can Cloud Management Cover Every Gateway Task?

Central management is valuable, but local recovery and safe maintenance procedures are still necessary. A site may be disconnected precisely when a technician needs to diagnose or replace the gateway.

Keep a compact decision record for edge gateways changes. It should capture site identity, connectivity state, local queue condition, software version, and recovery action. For a site acceptance checklist, this record is not bureaucracy for its own sake: it lets the next engineer, operator, or support owner understand what changed, what evidence was reviewed, and which question remains open. For a site acceptance checklist, during an incident, it also prevents the team from relying on a screenshot or an unverified recollection when deciding whether to contain, correct, or continue the service.

Conclusion: Use the Checklist to Protect Site Work

Edge gateways turn difficult field conditions into an engineering boundary that can be managed. Start with the site, preserve local continuity, stage change carefully, and make fleet health explainable at the asset level. Those choices keep a gateway from becoming a remote unknown when operations need it most.

Continue with related articles

The Plain-language Guide to MQTT Brokers

Krishnam Murarka explains mqtt brokers with practical context for operations leaders: architecture, risks, implementation choices and operating signals.

Glossary & FAQs · 12 min

Device Identity Lifecycle: Core Principles

Krishnam Murarka explains device identity with practical context for engineering teams: architecture, risks, implementation choices and operating signals.

Glossary & FAQs · 8 min
