Offline Sync Checklist for Reliable Digital Operations is a practical planning guide for engineering teams. Offline sync is valuable only when it supports a real operational decision: let field work continue without a connection while preserving who changed what, what was based on stale context, and how competing changes are resolved. Treat it as an operating design problem, not a product category. The team needs to know the protected or controlled asset, the people who may act, the evidence that makes an outcome credible, and the condition that requires a different response. That framing makes early trade-offs visible. It also prevents a polished implementation from becoming an opaque dependency that nobody can safely change during an incident.
Define The Decision
Begin offline sync work by writing down the decision in a form an operator can challenge. For this topic, the core asset is a local record model with immutable identifiers, client-created change IDs, observed revision or version, author, device context, and durable sync checkpoint. The boundary matters because offline creation is separate from centrally approved state changes; the client may capture evidence and propose an action without pretending that every remote rule has run. Ask what must still be true when an integration is delayed, a credential fails, a device is replaced, or an engineer is unavailable. A good answer names the system of record, the accountable owner, the required evidence, and the default safe behavior. It does not claim that a network, dashboard, gateway, or service is inherently trustworthy simply because it is familiar.
| Decision area | Question to settle | Evidence before release |
|---|---|---|
| Purpose | Which repeated operation does offline sync improve, and what is the cost of a wrong result? | A named user, decision, and acceptance scenario. |
| Authority | Who can change policy, data, or configuration, and who may approve an exception? | Role mapping, approval record, and audit event. |
| Time | Which timestamps describe observation, receipt, action, and review? | Examples showing time zone, clock source, and stale-state behavior. |
| Failure | How should the system behave when there is silent last-write-wins loss, duplicate submission after retry, a client clock treated as authoritative, or a conflict that disappears before the reviewer sees it? | A tested fallback, notification owner, and recovery decision. |
Design The Operating Boundary

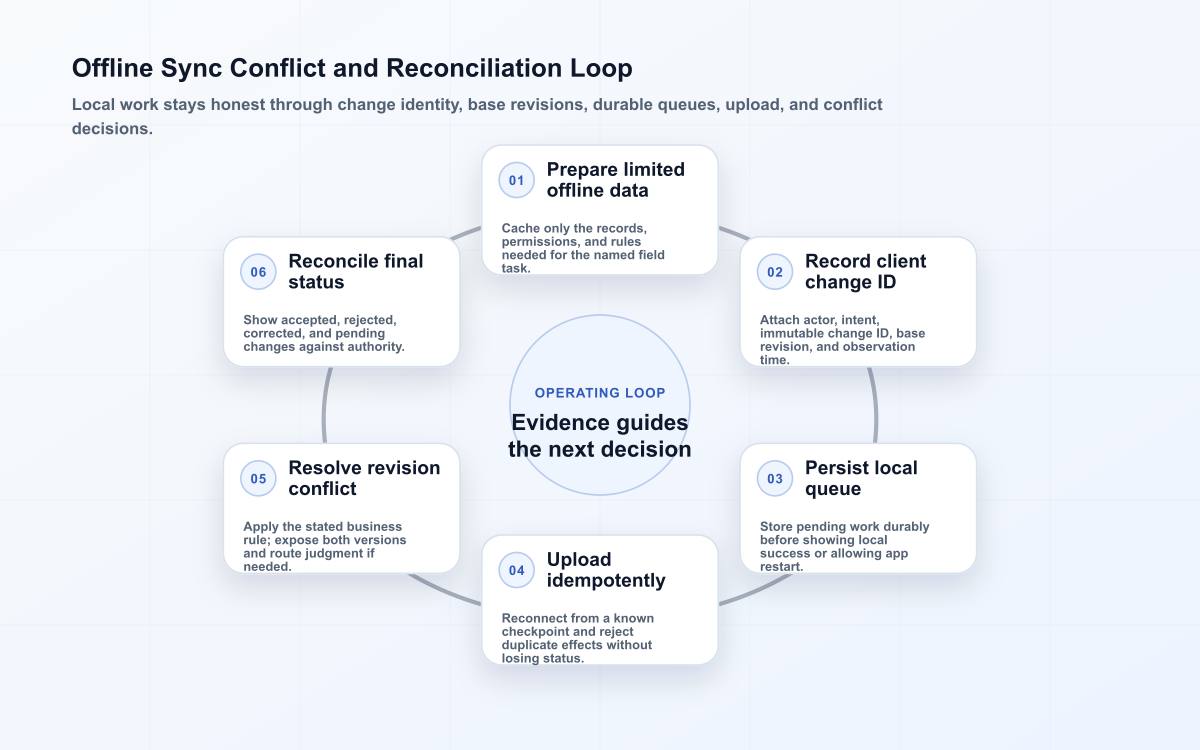

The architecture should make normal work and exceptional work equally legible. With offline sync, that means separating the authoritative record from derived views, and separating a request for action from evidence that the action occurred. Avoid an all-or-nothing trust model. Constrain identities and connections to the least access that supports the workflow; keep policy, configuration, and operational records versioned; and retain the context needed to interpret older data. This is how a team can investigate an outcome without reconstructing intent from chat messages or a vendor console after the fact.

- Model the smallest offline sync workflow that changes an important operational decision, including its unhappy path.
- Name the owner of the source record, the integration, the control rule, and the first-line support response.
- Make freshness, quality, identity, and authorization visible wherever a user is asked to rely on a signal.
- Use stable identifiers and change records so retries, replacements, and corrections can be explained rather than guessed.
- Set explicit limits for access, retention, rate, and scope before a convenient temporary exception becomes permanent.
- Test silent last-write-wins loss, duplicate submission after retry, a client clock treated as authoritative, or a conflict that disappears before the reviewer sees it with the people who would actually diagnose and recover it.
Stage The Rollout
A controlled rollout is evidence gathering, not merely a smaller deployment. For offline sync, start with one task that has clear local ownership, define its conflict policy in plain language, and test airplane-mode, retry, and concurrent-edit cases with real records. Select a cohort that exposes meaningful variation but has clear operational cover. Decide in advance what result pauses expansion: a security control that cannot be verified, a mismatch between displayed and source state, a performance threshold, or a failed recovery test. Review both successes and near misses with the operating team. The aim is to make adoption repeatable, so the next site, device group, or workflow is added through a known decision rather than improvisation.
| Rollout gate | What to observe | Decision when it fails |
|---|---|---|
| Readiness | Inventory completeness, named owners, and documented preconditions. | Hold the cohort until the missing condition is resolved. |
| Behavior | Normal and adverse offline sync scenarios under representative load and connectivity. | Correct the design or reduce the scope before expanding. |
| Control | Authentication, authorization, logging, and exception approval in the live path. | Remove the uncontrolled path and retest. |
| Recovery | Whether the team can execute keep the local queue inspectable, make rejected changes visible with the reason, and provide a governed re-submit or escalation path instead of deleting work. | Keep rollout paused until recovery evidence is repeatable. |
Make Controls Operable
Controls only help when people can operate them under pressure. Design offline sync so an on-call engineer or supervisor can see what changed, why the system took its current state, and what they are permitted to do next. Temporary access needs expiry and ownership. Changes need a version and a traceable approver. Sensitive actions need both a technical check and a humanly understandable confirmation. These habits reduce the chance that a local fix silently shifts risk elsewhere. They also give leadership a usable account of how the service is governed rather than a collection of screenshots.
Measure And Review
Choose measures that reveal whether offline sync is reducing uncertainty in daily work. Track oldest unsent change, successful checkpoint rate, conflict rate by workflow, duplicate rejection rate, and time from reconnect to a reconciled record. Pair each indicator with a review question: is the number telling us about the controlled system, or only about the collector? Is a lower count a genuine improvement, or has visibility been lost? Can the owner explain a material change in the measure? This prevents dashboards and reports from becoming decorative. Review thresholds after incidents, staffing changes, and architecture changes, because the operating context can change faster than the metric definition.
| Signal | Why it matters | Review cadence |
|---|---|---|
| Coverage | Shows whether important assets and paths are represented, not just easy ones. | Weekly during rollout; monthly once stable. |
| Freshness | Distinguishes delayed evidence from a current operating state. | Continuously, with a visible stale threshold. |
| Exceptions | Shows where policy or workflow does not fit real work. | Each exception and a monthly trend review. |
| Recovery evidence | Proves the team can restore a known-safe state. | After change and through scheduled exercises. |
Use Authoritative References
This guide draws on Apache CouchDB Replication Protocol, RFC 7232: HTTP Conditional Requests, RFC 3339: Internet Timestamps, MQTT Version 5.0. These references do different jobs: they define security principles, protocol behavior, lifecycle expectations, or monitoring practices. They do not replace site-specific engineering review. Use them to test assumptions, especially where offline sync crosses a trust boundary or affects a safety-relevant workflow. For related implementation context, read Offline Sync: Hands-on Planning Guide, Sensor Data Pipelines: Common Mistakes and Practical Fixes, and Firmware Updates: Operations Playbook. Those pieces help turn the checklist into a connected operations plan rather than a stand-alone technical artifact.
Takeaways
- Offline sync should begin with a named operational decision and accountable owner.
- Keep the authoritative record, derived view, and action request distinguishable.
- Prove the unhappy path and recovery path before widening a rollout.
- Measure uncertainty reduction with freshness, exceptions, coverage, and recovery evidence.
- Review temporary access, policy changes, and operating thresholds as first-class work.
Faq
When is offline sync worth doing? It is worth doing when the current workflow has a consequential decision that depends on fragmented, late, insecure, or difficult-to-explain information. Start where better evidence or a safer action would change an outcome, rather than where a new platform is easiest to buy. What is the smallest credible first release? Build one observable path with a real owner, one system of record, one exception route, and a tested recovery action. A narrow release that survives an outage teaches more than a broad launch that relies on manual workarounds. How should a team handle uncertainty? State it in the workflow. Mark data as stale or estimated, preserve the original evidence, and route ambiguous cases to a named reviewer. Hiding uncertainty creates faster-looking but less reliable operations.
Conclusion
Reliable offline sync is less about adopting a fashionable architecture than about keeping promises through normal work, change, and failure. Establish the decision, identify the authoritative evidence, constrain access, stage the rollout, and rehearse recovery. Then use operational signals to revise the design. That sequence creates a system the team can run and explain, even when connectivity, staffing, or upstream services are not behaving politely.
