Hybrid Cloud Solutions: Architecture Choices, Cost Drivers, Risks and Delivery Plan

Plan hybrid cloud around workload needs, identity, connectivity, data and operations, with explicit placement criteria, failure modes, cost ownership and migration evidence.

Edilec Research Updated 2026-07-15 Cloud & DevOps

Hybrid Cloud Solutions: Architecture Choices, Cost Drivers, Risks and Delivery Plan is for technology leaders, cloud architects, security teams and service owners deciding how on-premises and cloud environments should work together. The aim is to place workloads deliberately and operate them through consistent controls without pretending that different environments are identical. That changes the planning question from “which tool or supplier looks impressive?” to “what operating result must be true, which boundaries carry risk, and what evidence will let accountable owners approve the next step?” A useful plan makes those choices inspectable before implementation and keeps them visible through release.

Estimate a hybrid cloud solution from the work that creates uncertainty: workload dependencies, network and DNS changes, identity federation, data replication, platform licenses, dual operations, migration waves and retirement of legacy components. Use ranges tied to assumptions and narrow them with targeted evidence; a generic schedule or price would conceal the very conditions the plan needs to test.

1. Define the outcome and a decision-ready scope

The scope boundary should include workload dependencies, latency and availability needs, data gravity and residency, identity sources, connectivity, management planes, provider responsibilities and exit requirements. Write the boundary in operational language: who performs the work, what triggers it, which record is authoritative, what can fail, who handles an exception and what proves completion. This prevents a feature list from hiding the data, authorization, integration and support work that usually determines whether a system can be trusted.

Each business service needs an owner who approves placement and recovery; platform teams own shared controls; network, identity, data and security teams accept their boundaries instead of leaving cloud engineering to absorb every dependency. Record that division in decision and responsibility maps. A boundary is not truly out of scope until its owner accepts the dependency and the evidence expected from it.

  • Record the current baseline and the desired behavioral change.
  • Identify the first representative users, systems and data.
  • Separate known constraints from assumptions that require testing.
  • Define acceptance evidence for functional and nonfunctional behavior.
  • Set a decision forum, escalation path and expiry date for unresolved risks.

2. Make architecture and data contracts reviewable

Separate control planes from workload and data planes across datacenter, edge and cloud. Show identity sources, policy distribution, routes, DNS, management channels, writes, replication and the behavior when any cross-boundary link fails. Annotate ownership, failure behavior and retained evidence at each boundary so reviewers can reason about operation rather than merely recognize product icons.

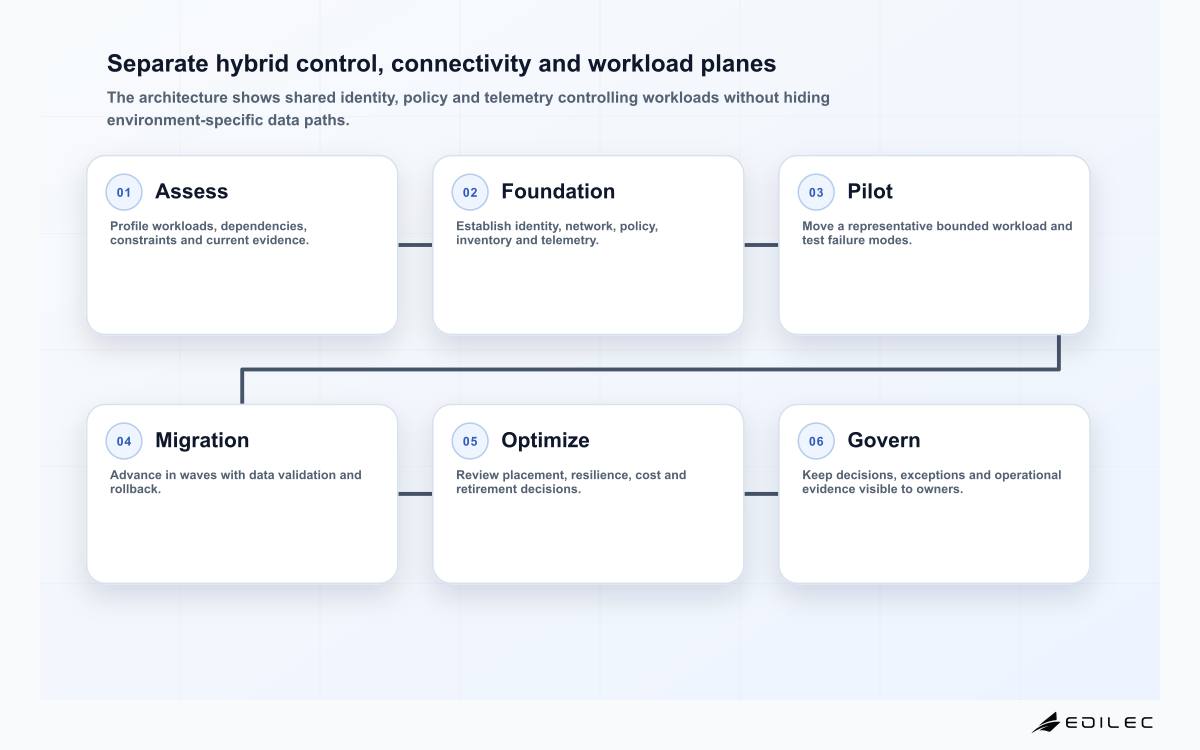

Separate hybrid control, connectivity and workload planes
Use this diagram with CLODEV-10490 to review boundaries, evidence and ownership before wider release.
Decision areaWhat must be explicitMinimum evidence
PlacementBusiness and technical reason for each locationApproved workload placement record
IdentityHuman, workload and emergency accessFederated policy and lifecycle tests
ConnectivityRoutes, DNS, encryption, capacity and failoverFailure and recovery exercise
DataAuthority, replication, consistency and residencyData-flow and recovery evidence
OperationsInventory, policy, telemetry and incident ownershipCross-environment runbook rehearsal

Pilot a representative workload and deliberately remove connectivity, identity federation or central management. Verify local behavior, queued work, alerting, emergency access and data reconciliation after service returns. Write the question and acceptance condition before building the proof, then preserve the result and changed decision. This keeps experimentation from turning into an unreviewed production component.

3. Build controls into the working path

Use authoritative inventory, workload identity, policy-as-code and normalized telemetry across locations, while preserving environment-specific safeguards. Network location alone should never grant sensitive resource access. For every important risk, identify prevention, detection, response and the safe route for a legitimate exception; a policy statement alone cannot enforce or recover the workflow.

  • Use one authoritative inventory with environment and owner metadata
  • Apply identity policy to users and workloads rather than trusting location
  • Define data consistency and conflict behavior before replication
  • Test partial connectivity loss and management-plane outage
  • Normalize telemetry context while preserving local diagnostic detail
  • Allocate shared network, licensing and operational costs to service owners

Federate human access where possible, use workload identities for automation and separate central administration from local emergency roles. Test revocation when the identity provider or management plane is unavailable. Retain only the diagnostic evidence needed for support, assurance or investigation, protect it as sensitive data and verify both routine and emergency paths.

4. Deliver through evidence gates

Profile and classify workloads first, build identity-network-policy foundations, pilot one dependency-rich service, migrate in reversible waves, then retire duplicated components according to evidence. Each gate should name its decision owner, evidence, tolerated exceptions, stop condition and next reversible commitment, making progress depend on reduced uncertainty rather than completed components.

StageDecision and evidence
AssessProfile workloads, dependencies, constraints and current evidence.
FoundationEstablish identity, network, policy, inventory and telemetry.
PilotMove a representative bounded workload and test failure modes.
MigrationAdvance in waves with data validation and rollback.
OptimizeReview placement, resilience, cost and retirement decisions.

A migration wave should define data freeze or synchronization, traffic shift, observation, rollback and reconciliation. Test failback before the original environment is dismantled, especially where writes occur in both locations. Wider exposure should follow observed evidence, not calendar confidence. Define who can stop expansion, what state must survive reversal and how affected users will be informed.

5. Explain cost through drivers and assumptions

Calculate public cloud, datacenter, connectivity, transfer, licenses, observability, backup and specialist operations together. During transition, duplicate capacity and parallel support can dominate the apparently cheaper compute line. State the unit or population behind variable charges and identify the evidence that would tighten uncertain ranges. This makes tradeoffs visible without inventing a universal budget.

Use milestone acceptance for foundation capabilities and migrated services, with explicit customer dependencies and exit artifacts. Managed hybrid operations need service boundaries for provider, enterprise and carrier failures. Document assumptions about access, data, reviewers and third parties. When they fail, choose explicitly among scope, cost and timing instead of silently discarding testing or operational readiness.

6. Measure the system as an operated service

Review user outcome and latency by location, link failures, policy compliance, recovery exercises, unallocated spend and legacy retirement. A combined average can hide an edge site or datacenter that is consistently unhealthy. Define source, population, unit, exclusions, review cadence and the action attached to each threshold so the reporting supports a real operating decision.

Signal to reviewDecision it should support
service outcome by locationFor this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.
cross-boundary latency and failureWithin this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.
configuration-policy complianceWhen implementing this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.
recovery exercise resultsBefore releasing this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.
unallocated hybrid costWhile operating this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.
legacy dependency retirement progressWhen changing this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.

Runbooks should cover route loss, DNS inconsistency, expired federation, replication lag, central policy outage and regional failure. Reconcile queued transactions and authoritative records after connectivity returns. Confirm recovery against user-visible behavior and authoritative records; a successful automation job or green infrastructure chart does not by itself prove the service is correct.

7. Expose common failure modes early

Failure modePractical response
Hybrid becomes permanent duplicationGive every transitional component an owner and review date.
Network treated as trust boundaryUse explicit identity and resource authorization.
Hidden data couplingMap writes, consistency and recovery before migration.
Central control-plane outageRetain bounded local operation and tested emergency access.
Cloud bill excludes total costInclude connectivity, licenses, facilities and operating labor.

Track permanent duplication, hidden data coupling, unsupported hardware, central-control dependence and unclear provider responsibility. Give every transitional bridge a retirement condition or a deliberate long-term owner. Keep these entries connected to architecture decisions, backlog work, tests and operating signals. Close them with evidence or carry them visibly with an accountable acceptance decision.

Key takeaways

  • Start with the operating result: place workloads deliberately and operate them through consistent controls without pretending that different environments are identical.
  • Define architecture through identity, data, trust, failure and ownership boundaries.
  • Place controls where they can enforce a decision and retain proportionate evidence.
  • Estimate from explicit drivers and assumptions; avoid universal price or schedule claims.
  • Expand through bounded cohorts and prove that receiving teams can operate and recover.

Frequently asked questions

What should the first deliverable be?

The first deliverable is a workload placement and dependency map with identity, network, data, recovery, compliance, cost and exit criteria. Select a pilot that exercises important boundaries without carrying intolerable business impact. Keep it concise enough to review and specific enough to reject a weak option. The next artifact should be the smallest proof capable of changing the decision.

Should the team select tools before architecture?

Choose management and orchestration products after workload needs are known. A unified console is useful only if it can represent all assets accurately, enforce policy safely and degrade predictably when disconnected. Compare candidates through a realistic path and inspect limits, failure behavior, portability and ownership; product selection cannot repair an undefined operating model.

When should security and operations join?

Security, network and operations teams must shape the foundation before migration. They should review workload identities, privileged paths, telemetry, emergency access and cross-site recovery during the pilot. Early participation should produce concrete requirements and tests, not a late request for policy approval after expensive boundaries have hardened.

How does the team know it is ready to scale?

Move additional workloads when the pilot meets service objectives, failure tests succeed, data can be reconciled, cost allocation is understood, operational ownership is staffed and rollback remains viable for the next wave. Require that evidence across the whole workflow, including exceptions and recovery, rather than treating one successful demonstration or a quiet pilot as proof of readiness.

Conclusion

Hybrid Cloud Solutions: Architecture Choices, Cost Drivers, Risks and Delivery Plan should end in an operable decision system: clear authority, bounded architecture, enforceable controls, staged evidence and measurable service ownership. That foundation lets teams move quickly without hiding uncertainty. It also makes a stop, redesign or narrower release a legitimate outcome when evidence does not support expansion. The durable result is not merely delivered technology, but an organization that can explain, operate and improve it.
