Cloud Consulting Services: From Workload Decisions to a Controlled Delivery Plan

A practical guide to scoping cloud consulting around business workloads, landing-zone controls, migration evidence, operating ownership and total cost rather than a generic move-to-cloud promise.

Edilec Research Updated 2026-07-15 Cloud & DevOps

Cloud Consulting Services are valuable only when they improve a named operating outcome and leave behind a service that people can govern. The practical unit of scope is the business workload and its dependent service. That framing exposes data, identity, integration, controls, people and provider dependencies that a tool list misses. It also makes trade-offs reviewable: leaders can decide what authority changes, what evidence proves readiness, what remains outside scope and what must happen when the new path fails.

Define the outcome and service boundary

Classify each workload by business criticality, data sensitivity, latency, recovery needs, change rate and dependency shape before choosing a migration disposition. Scope should name the current baseline, target behavior, affected users, authoritative records and material failure consequences. It should also identify exclusions. A bounded first release can exercise the full path without pretending to solve every adjacent process. The accountability model is equally important: the application owner remains accountable for the service while platform teams own shared cloud controls. Record that boundary in the service design and acceptance criteria, not only in a presentation.

Discovery should trace several real cases from start to finish, including delayed, disputed and high-risk examples. Interviewing leaders reveals policy; observing operators reveals how work actually completes. Inventory applications, data stores, identities, scheduled jobs, third parties, manual handoffs and calendar constraints. For each dependency, record an owner, expected behavior, failure signal and continuity method. This produces an evidence-backed scope and a list of unknowns that can be priced and retired. For cloud migration, sample workload dependencies and landing-zone exceptions explicitly.

Scope questionDecision evidenceAcceptance signal
OutcomeBaseline, target and accountable ownerA measurable change tied to a real user or operation
AuthorityDecision rights and system-of-record boundariesNo critical state or approval has two owners
FailureImpact, fallback and recovery objectiveTeams can complete or safely pause the workflow
ChangeIn-scope population, exclusions and rollbackThe first release is bounded and reversible

Design the operating architecture

Treat the landing zone as a maintained product: identity federation, account or subscription structure, policy enforcement, network patterns, logging, key management and break-glass access need named owners. Architecture is not only a component diagram. It is a set of contracts about state, authority, access, timing and failure. Define inputs and outputs, versions, retry behavior, reconciliation, audit events and the point at which responsibility changes hands. Prefer managed or shared capabilities when their operating boundary is understood; keep custom logic where the business rule or control genuinely differentiates the service.

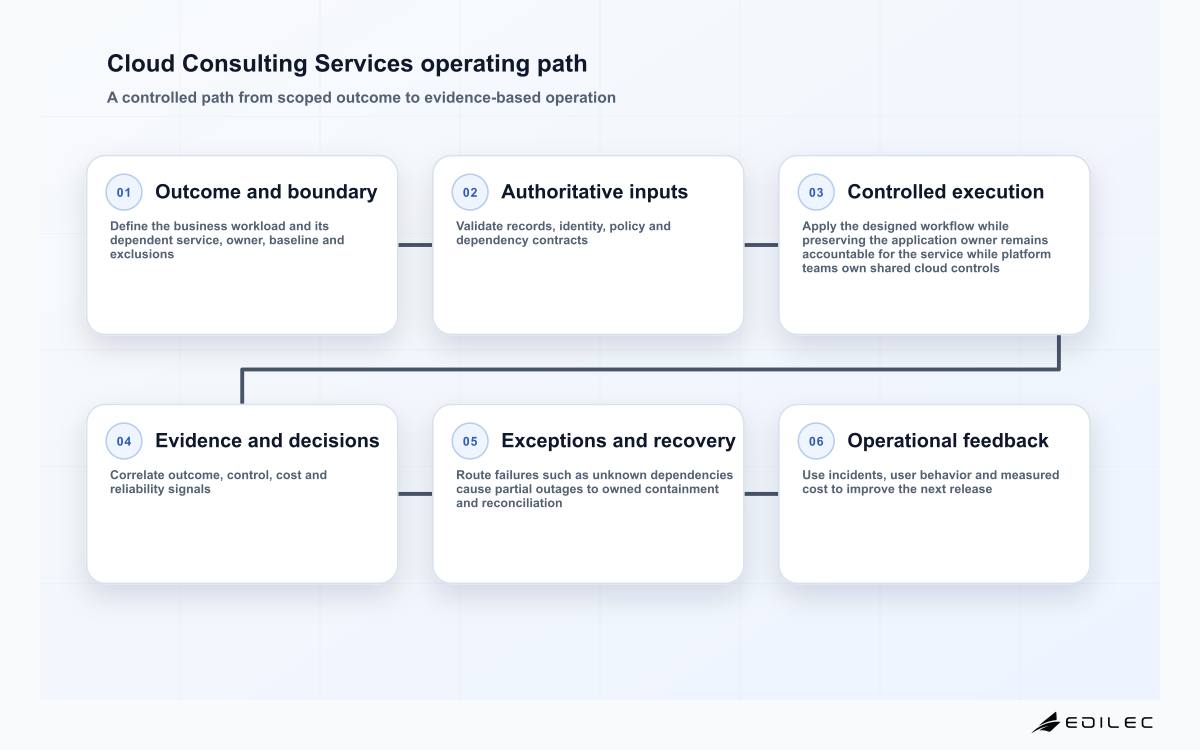

Cloud Consulting Services operating path
The diagram makes authority, delivery evidence, exception handling and operational feedback visible for a cloud consulting engagement.

Choose rehost, replatform, refactor, retain, retire or replace per workload. A portfolio slogan cannot substitute for evidence about code, data, licensing and operational readiness. Security and privacy belong in those contracts. Separate human, service, privileged and emergency identities; minimize access; protect secrets; classify data; set retention; and test authorization at the action boundary. Logging must preserve enough provenance to investigate decisions without creating a new uncontrolled copy of sensitive content. Threat modeling should cover abuse, dependency compromise, configuration drift and recovery, then assign each treatment to an owner.

Build an evidence model, not a dashboard collection

Model one-time migration, dual running, data transfer, managed services, support, resilience and exit. Consumption discounts do not repair a poorly designed workload. Evidence should connect an observed condition to a decision. Define each measure with a formula, source, population, timing, owner and known limitation. Pair outcome measures with leading indicators such as exception age, failed controls, backlog, saturation or unsupported cases. Counts without denominators and averages without distributions can conceal concentration; use segmented results where user, workload or risk differences matter.

Keep provenance from source through transformation to report. Version definitions and disclose material changes. A control result should identify what was tested, when, against which configuration and by whom. An operational signal should route to someone able to act. Review unused dashboards and noisy checks as debt: evidence that does not change a decision still consumes attention and cost, and it may create false confidence during an incident. Here, preserve account, policy and migration-wave lineage.

Model cost across discovery, change and operation

No universal price or timeline is credible for a cloud consulting engagement. Estimate ranges from inspected evidence and separate one-time delivery, transition and recurring operation. Major cost drivers include portfolio discovery and dependency tracing; landing-zone engineering and policy automation; application and data remediation; migration rehearsals and dual running; security, resilience and compliance evidence; and managed-service consumption, support and exit. Show volume, retention, availability, staffing, licensing and growth assumptions beside the numbers. Reforecast after discovery and the proof slice because uncertainty should decline as the team learns.

Cost layerWhat to estimateEvidence to request
Discoveryportfolio discovery and dependency tracing; landing-zone engineering and policy automationInventories, samples, interviews and dependency maps
Buildapplication and data remediation; migration rehearsals and dual runningBacklog, interface contracts, test scope and environments
Assurancesecurity, resilience and compliance evidenceControl mapping, evaluation plan and remediation allowance
Run and exitmanaged-service consumption, support and exitConsumption model, support rota, retention and export plan

Include internal labor and operational disruption, not just supplier invoices. Dual running, migration rehearsal, data repair, support training, audit participation and decommissioning are often real work even when absent from a proposal. Unit costs should follow the service's natural volume so growth can be explained. Contingency should correspond to documented unknowns, with a plan to resolve each one, rather than appear as an unexplained percentage. Budget specifically for dual running, data transfer and platform support.

Control the risks that shape delivery

The primary risks are concrete: unknown dependencies cause partial outages; identity or network baselines are bypassed; forecast assumptions diverge from measured consumption; rollback depends on stale data; teams inherit services they cannot operate; and provider concentration limits recovery or exit. Put each risk beside an early indicator, treatment, owner and stop threshold. Risk acceptance belongs to someone with authority over the consequence. Supplier assurances can inform due diligence, but they do not replace testing of the customer's configuration, workflow and shared-responsibility boundary.

RiskEarly evidencePractical treatment
unknown dependencies cause partial outagesA representative case cannot be traced end to endMap the path with operators and test the missing dependency
identity or network baselines are bypassedAccess, policy or ownership differs across environmentsAutomate the baseline and review exceptions with expiry
forecast assumptions diverge from measured consumptionMeasured behavior diverges from the planning assumptionSet a threshold, investigate by segment and reforecast
rollback depends on stale dataRecovery or reconciliation cannot restore trusted stateRehearse rollback and preserve authoritative evidence
teams inherit services they cannot operateQueue age or manual work rises during the pilotLimit the wave and strengthen ownership and runbooks
provider concentration limits recovery or exitExit or substitution cannot be demonstratedTest export, revocation, portability and continuity before scale

Use a staged, reversible delivery plan

Prove a representative vertical slice and recovery path before a migration wave. Reconcile records, validate performance and keep rollback possible until acceptance evidence is complete. A sound sequence is: frame the outcome and authority; discover real paths and dependencies; design contracts and controls; prove a thin end-to-end slice; pilot with a bounded population; expand only when thresholds hold; and retire old paths after consumers, records and obligations are reconciled. Every gate needs a decision maker and current evidence. Schedule pressure is not evidence that the next wave is safe.

  • Frame: approve the outcome, owner, boundary, baseline, risk tolerance and exclusions.
  • Discover: inspect representative cases, dependencies, data, permissions, controls, volumes and failure history.
  • Design: document authority, contracts, security, evidence, recovery, support and cost assumptions.
  • Prove: exercise the complete path with realistic data, failures, reconciliation and rollback.
  • Pilot: limit exposure, increase review frequency and measure user and operational behavior.
  • Expand: add scope only while outcome, control, cost and support thresholds remain acceptable.
  • Retire: remove obsolete access, jobs, copies, contracts and runbooks after verified reconciliation.

Move operational ownership with the service. Runbooks, alerts, cost allocation, incident roles, capacity decisions and provider escalation must work on the first production day. Production readiness should be demonstrated by the people who will operate the service. Run a simulation that includes an ambiguous case, a dependency failure and an access problem. Observe whether teams can establish authority, protect data, communicate impact, preserve evidence and recover without uncontrolled edits. Feed gaps back into architecture, training and support. This is more revealing than a checklist signed before operators see the actual service.

Implementation review checklist

Review areaQuestions before expansionRequired artifact
BusinessDid the target outcome improve for the pilot population?Baseline comparison and owner decision
DataAre authority, quality, lineage and retention understood?Data contract and reconciliation result
SecurityDo least privilege, logging and response work in practice?Access review and scenario evidence
OperationsCan support identify, contain and recover failures?Runbook exercise and open-gap register
CommercialDo measured unit costs and provider duties match assumptions?Updated forecast and responsibility matrix
ChangeCan the team roll back and retire old paths safely?Rollback result and decommission plan

Key takeaways

  • Scope the business workload and its dependent service, not a product label.
  • Make authority, evidence and failure behavior explicit before implementation.
  • Estimate portfolio discovery and dependency tracing, migration rehearsals and dual running and ongoing managed-service consumption, support and exit alongside build work.
  • Treat unknown dependencies cause partial outages and rollback depends on stale data as testable delivery risks.
  • Expand through bounded waves with reconciliation, recovery and operational gates.

Frequently asked questions

Where should a cloud consulting engagement start?

Start with one important outcome and several representative cases. Name the owner, current baseline, users, systems of record, failure consequence and first reversible boundary. Then inspect enough real work to identify dependencies and exceptions before selecting tooling or committing to a portfolio timeline. A credible opening boundary is one workload with a reversible migration disposition.

How should cost be estimated?

Use a bottom-up range built from volumes, interfaces, environments, data condition, assurance depth, service objectives and support coverage. Separate discovery, implementation, transition and recurring operation. State assumptions, price the work needed to close unknowns and reforecast after the proof slice produces measured evidence. The main sizing variables are workload count, data volume and recovery tier.

What should be checked when selecting a provider?

Check functional fit, architecture, data handling, security, resilience, audit access, subcontractors, service management, pricing behavior and exit. Map every material responsibility to customer, provider or another party. Test a representative normal path and failure path rather than relying on a generic demonstration or certification. Require evidence for landing-zone integration, portability and cloud exit.

How should success be measured after launch?

Use the original outcome plus correctness, control effectiveness, reliability, exception age, user behavior, recovery performance and unit cost. Segment results where averages hide important populations. Delivery milestones show that work shipped; they do not prove that the service became safer, faster or more useful. Prioritize migration accuracy, recovery tests and unit cloud cost.

Conclusion

Cloud Consulting Services should leave an organization with more than configured technology. It should create an owned service boundary, trustworthy evidence, operable controls and a realistic path for change. The disciplined approach is to begin with a consequential but bounded outcome, discover the real dependencies, design authority and failure behavior, prove the full path and expand only when operational evidence supports the decision.

That discipline also improves commercial judgment. Costs become connected to inspected work, supplier duties become explicit and risks become conditions the team can test. Most importantly, the organization retains the ability to pause, recover, reconcile and learn. A cloud consulting engagement is successful when the changed capability can be understood and operated under ordinary pressure as well as during the failure that planning hoped would never occur.
