Common Mistakes in Finance Approval Systems and How to Avoid Them

Finance approval systems fail when authority, evidence, delegation, and recovery are treated as separate concerns. This guide shows how to design a controlled approval path that operators can run.

Edilec Engineering Updated 2026-07-15 Enterprise Systems

Finance approval systems are dependable only when the people doing daily work can tell what is true, who may decide, and how a blocked case becomes visible. A workflow screen alone cannot provide that. The design has to connect records, authority, timing, and evidence across the business journey. Consider this case: A department head requests a non-routine supplier payment after a budget owner has left the company. The request has a valid invoice but an incomplete cost-centre reference and the supplier bank change was submitted yesterday. It is an ordinary operational event, but it exposes whether the system carries the necessary context or merely routes a task. The best first release makes the normal path quick while making uncertainty explicit. Teams planning connected operations can use the ERP, CRM and workflow integration guide to frame the boundaries before adding automation.

Start finance approval systems with a bounded operating outcome

Write the outcome in terms of a completed business result, not a system feature. For finance approval systems, the first journey should specify the trigger, completion test, accountable owner, required evidence, and what must happen when the evidence is incomplete. In the scenario above, a payment must not be released until the cost-centre and bank-change controls have independently passed. Interview the people closest to the work using recent cases, including the uncomfortable ones. Ask what starts the journey, which fact can change, which decision has financial, people, or customer impact, and who is allowed to repair an error. A good answer is concrete enough for an operator to challenge. It also prevents a project from stretching into every adjacent process before one useful route is proven.

Decision areaRule to agreeEvidence retained
Outcome boundaryState precisely when finance approval systems begins, finishes, pauses, and hands work to another process.Named outcome owner, representative cases, and acceptance criteria.
Business factsDefine authority and permitted changes for request, supplier, budget, purchase order, invoice, approval decision, delegation, payment instruction, and exception.Stable identifier, source reference, effective time, and status history.
Decision rightsGive requester, budget owner, procurement reviewer, finance controller, treasury approver, and payment operator a distinct action; do not confuse being informed with being allowed to approve.Role assignment, threshold or condition, delegation limit, and decision record.
Exception routeSpecify the queue, service target, and closure rule when the normal evidence is missing or disputed.Reason code, owner, next action, and resolution reference.

Model records, authority, and time before configuring finance approval systems

Most failures start when two tools appear to own the same fact, or when a correct fact has no effective date. Create a small authority register for request, supplier, budget, purchase order, invoice, approval decision, delegation, payment instruction, and exception. For every record, name the authoritative source, business owner, identifier used across boundaries, allowed changes, and whether a receiver keeps a read-only projection or may propose a correction. Record when an observation happened and when it became effective. This distinction matters when work is replayed, delayed, or corrected after a decision. A report can be useful evidence without becoming the source transaction. The provenance concepts in W3C PROV-O offer a useful mental model: retain the source, activity, and responsible actor that led to a result so a later reviewer can reconstruct the path.

Design finance approval systems controls at every handoff

A handoff needs more than a field mapping. Define the trigger, required values, allowed state, source reference, duplicate behaviour, acknowledgement, and response to rejection. The receiver should know whether an incoming message is new, a correction, a cancellation, or a replay. Pair that contract with server-side authorization: the actor or service identity is verified, the action is limited to the necessary scope, and material decisions are logged without recording secrets or sensitive content unnecessarily. NIST guidance on system interconnection and OWASP authorization guidance both reinforce the same operating lesson: connectivity changes the control boundary. Tests must cover the boundary, not merely the happy-path interface. For finance approval systems, payment approval evidence must distinguish a request from a released instruction, especially after supplier or bank details change.

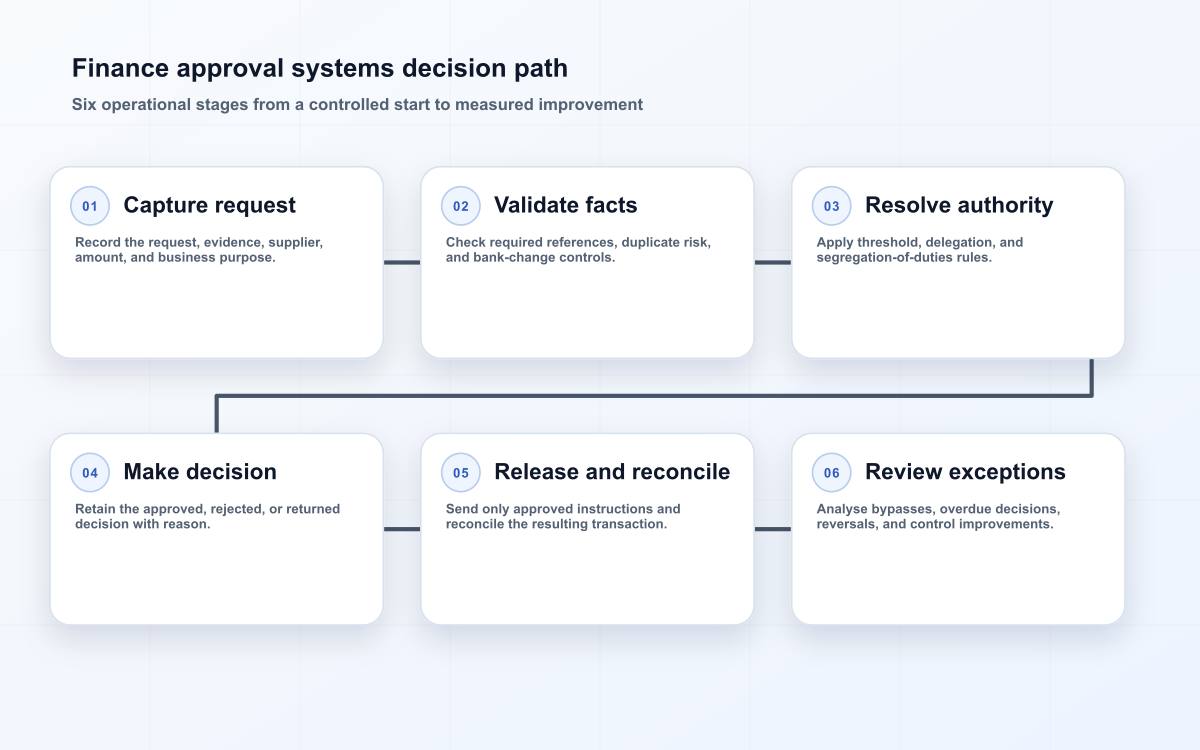

Finance approval systems decision path
A six-stage view of finance approval systems decision path, showing where evidence, decisions, recovery, and operating review belong.
ConditionExpected system behaviourAccountable owner
Required context missingHold or reject with a specific, actionable reason; do not invent a default to keep the screen green.Originating process owner
Duplicate or delayed deliveryRecognise the original business action through an idempotency key and preserve the earlier outcome.Receiving system owner
Authority or policy conflictBlock the consequential action and route a decision with the relevant policy version and evidence.Control or policy owner
Dependent system unavailablePersist a visible recovery state, retry only safe work, and avoid claiming completion before confirmation.Operations or integration owner

Make exceptions in finance approval systems operable, not invisible

The exception queue is part of the product. Each item should show the business identifier, failed step, reason, current owner, priority, source context, permitted next actions, and evidence created by repair. In this domain, the dangerous shortcut is approving on the strength of an email or allowing a delegation rule to outlive the manager's authority. That may resolve a queue count, but it leaves no durable explanation for the customer, colleague, controller, or auditor who needs to understand the outcome later. Separate temporary dependency problems from policy conflicts, disputed data, and missing information because each needs a different response. A retry can be safe for a read operation yet risky for a payment, access change, stock movement, or message that creates a commitment.

Measure the operating result of finance approval systems

Choose a compact scorecard before release and define its population, exclusions, calculation owner, and review rhythm. For this subject, useful signals include median approval age by risk tier, rejection reason, overdue delegation, bypass count, and reversal rate. Pair aggregates with a monthly sample of completed, rejected, and repaired cases. That review often reveals an apparently efficient path that is simply moving work into email, spreadsheets, or an unowned queue. A metric should lead to a decision someone can make: change a rule, fix master data, train a role, adjust capacity, or remove a redundant step. Avoid treating throughput alone as success. More closed tasks are not better if evidence, access, or customer commitments are being compromised.

  • Baseline five to ten real finance approval systems cases, including a normal path, a late change, a duplicate, missing data, and an unauthorised request.
  • Test the role boundaries for requester, budget owner, procurement reviewer, finance controller, treasury approver, and payment operator, including a departed user, a temporary delegate, and a service identity.
  • Rehearse the recovery route: identify who notices the failure, who can decide, and what record proves the repair.
  • Release to a contained group first, observe real queues and corrections, then widen scope only after the owners can explain results.
  • Review access, data quality, and exception patterns on a fixed cadence rather than waiting for a major incident.

Implementation checklist for finance approval systems

Before buildDuring buildBefore expansion
Name the outcome, owner, decision rights, and records that are in scope.Validate state transitions, input contracts, authorization, logging, and repair permissions with realistic cases.Compare measured outcomes with the baseline and keep an accountable owner for unresolved gaps.
Write the normal case and at least three adverse cases in plain language.Make reason codes and evidence useful to the person resolving a queue, not only to developers.Expand one workflow or role boundary at a time; revisit authority rather than copying rules wholesale.
Set a source of truth and effective-time rule for every material fact.Use stable identifiers so support staff can follow a case across systems without a manual search.Retire shadow spreadsheets only when the replacement has a proven recovery route and accessible history.

Key takeaways

  • Finance approval systems should make a business outcome, current owner, and next permitted action visible.
  • Record authority, effective time, and source references are prerequisites for trustworthy automation and reporting.
  • A handoff contract must address validation, duplicates, rejection, delay, and safe recovery.
  • Exception queues need their own owners, evidence, service targets, and controlled repair actions.
  • Measure outcomes and quality together; activity volume does not prove that the operating model is healthy.

FAQ: Where should a first finance approval systems release start?

Start with one frequent journey that crosses roles and contains a meaningful decision, but is still small enough to observe end to end. Do not choose it because it has the most screens. Choose it because the team can collect representative cases, identify the authoritative records, and name the person who owns the exception route. A first release should include the unhappy path from the beginning. That is the fastest way to learn whether the promised control is workable under actual operating pressure. In finance approval systems, use the scenario's decision point as the release boundary so the team can observe both speed and control.

FAQ: What should remain human in finance approval systems?

Keep a person accountable where evidence is uncertain, a decision changes money, access, employment, a customer commitment, or a material record, or where policy calls for judgement. Automation can collect facts, check complete inputs, calculate a threshold, route work, and prepare a decision view. It should not hide the rule, silently elevate authority, or make a consequential correction because an integration happened to succeed. The business workflow automation guide explains how to make this split explicit. In finance approval systems, document the decision that requires accountable review and show the reviewer the evidence needed to make it.

Conclusion

Finance approval systems become reliable when they are treated as an operating model: a bounded outcome, authoritative facts, clear decision rights, controlled handoffs, visible exceptions, and reviewable evidence. Build the first journey around a real case such as the one in this guide, rehearse its failure states, and use measured results to earn the next expansion. That discipline is less dramatic than a broad platform launch, but it produces systems people can use and trust.
