Operations control rooms are most valuable when several teams must make one coherent decision under time pressure. They are least valuable when they become expensive rooms full of screens that nobody is authorized to act on. A practical operations control room connects a defined service outcome, a small set of decision-grade signals, an incident lead, specialist responders, communication channels and a verified recovery test. It can be physical, virtual or hybrid; the operating model matters more than the furniture. Google’s monitoring guidance makes the useful distinction between telemetry that detects a condition and evidence that helps diagnose it. Growing teams should preserve that distinction, then design the room around who decides, who investigates and how customers learn what is happening.
Frame the operations control rooms decision
Before mapping fields or configuring rules, write one sentence that states the decision or action at stake: help an operator recognize and coordinate a material service condition. Then identify the initiating event, the person who owns the decision, the systems that observe it, and the deadline at which a late answer causes harm. This narrows scope without hiding dependencies. NIST defines data governance as processes that formally manage enterprise data assets and establish authority for decisions; that is a helpful lens when teams disagree about who can change a consequential record. In operations control rooms, a polished screen cannot compensate for authority that has not been decided. Document the system of record for the event, the consumer that relies on it, the failure mode, and the person allowed to accept a temporary workaround. control room engineering notes helps extend that framing into implementation detail.

Define records, states, and boundaries
The durable design unit is a record with a lifecycle, not a loose collection of fields. For service health signals, incidents, dependencies, and operator actions, make the important states explicit: proposed, valid, changed, rejected, completed, and corrected where they apply. State transitions need a business meaning, an effective time, and an accountable actor. Also define what stays in the originating application and what is distributed as a reference or event. A control room earns its place when it compresses a real operating decision: whether to declare an incident, which service owner to engage, whether a workaround is safe, or whether recovery has reached users. A wall of charts without these decisions can increase noise at exactly the wrong moment. The NIST Data Governance and Management Profile emphasizes that governance helps organizations manage privacy and cybersecurity risk alongside data use. In practice, this means that a new integration should not become the accidental owner of a record simply because it is easiest to query.
| Design question | Good operational answer | Evidence to retain |
|---|---|---|
| What starts work? | A named business event with a source and effective time | Source reference and correlation ID |
| Who may decide? | A current role or assigned owner, not an assumed inbox | Authority or assignment record |
| What can fail? | A defined rejection, retry, and escalation path | Error reason and handoff history |
| How is it corrected? | A controlled reversal or amendment, not a silent overwrite | Old value, new value, reason, and actor |
Design the exchange and exception path
A reliable path makes normal processing boring and abnormal processing legible. Define required inputs, validation rules, identity matching, timing, duplicate handling, target acknowledgement, and who investigates a failure. Organize the view by customer-facing service, then show its critical dependencies, current objective, active condition, and person accountable for the next update. Pair a fast aggregate signal with drill-down evidence; metrics establish the condition while logs and traces help investigate it. Do not use an error queue as a place to hide uncertainty. Each rejected record should show what failed, whether the source must change, whether a retry is safe, and who owns the next action. Where a workflow crosses several systems, preserve one correlation reference from the initiating event through the operational effect. That is the difference between proving a result and guessing from timestamps. This work also benefits from system-of-record design guidance, especially when the team must decide which application owns a fact rather than merely carrying a copy.
Control access and change
Controls should protect the decision that matters without turning ordinary work into an approval ritual. Treat alert rules, routing, dashboards, and runbooks as reviewed operational configuration. Test an alert from detection to notification, and protect the ability to mute or change an objective with role-based access and an auditable record. The NIST Cybersecurity Framework is a useful reference for treating governance, protection, detection, response, and recovery as connected activities. Security is also operational: a mistaken role assignment, unreviewed mapping, or undocumented manual correction can be as damaging as a technical outage. Establish a short change record for rule and interface changes, including purpose, impacted records, test evidence, rollback approach, approver, and completion result. Keep production credentials and test data separate. When sensitive data is involved, minimize the fields in logs, exports, notifications, and support tickets before adding more monitoring.
| Signal | Likely interpretation | First accountable response |
|---|---|---|
| Records wait past their target | An owner, validation, or downstream dependency is blocked | Inspect the oldest items and assign a named resolver |
| Manual corrections rise | A rule, master record, or upstream process is drifting | Sample corrections and fix the shared cause |
| Duplicates or repeats appear | Retries lack a stable business key or matching rule | Pause unsafe replay and reconcile the affected population |
| Users work around the system | The path is slow, unclear, or missing an exception state | Observe the real task before adding another form |

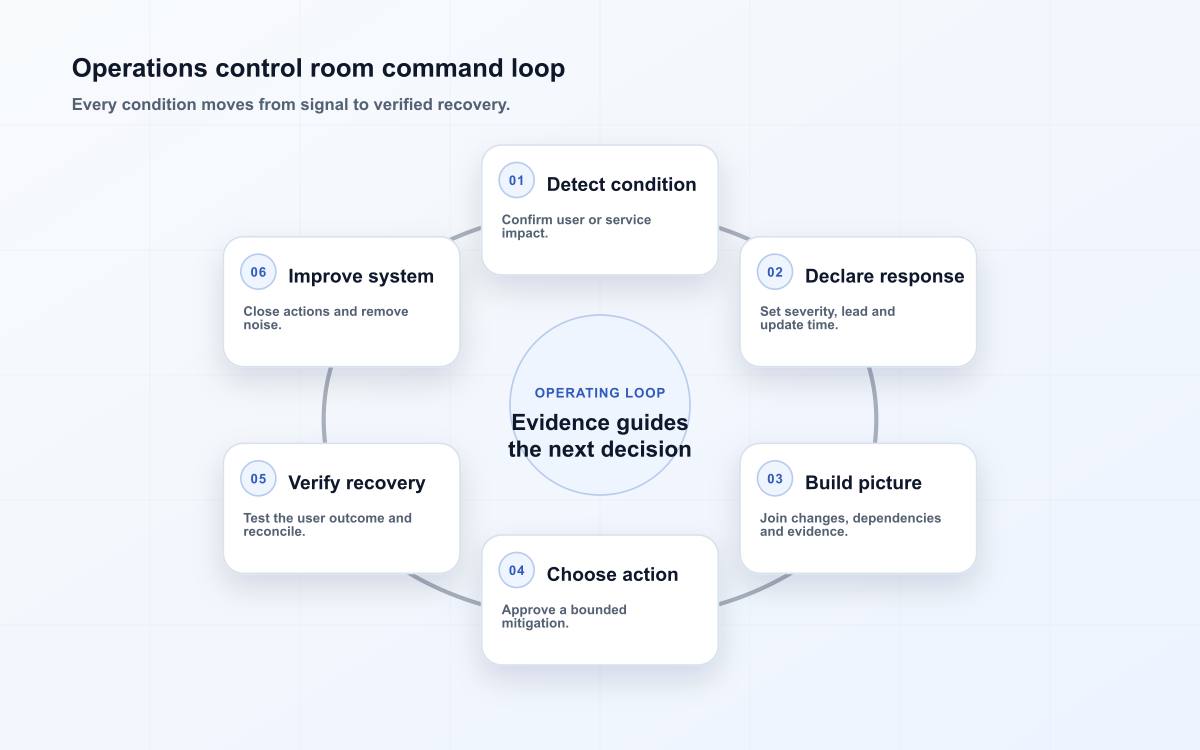

Operate The Control Room
Operating discipline keeps operations control rooms useful after the first release. Run a tabletop exercise against one service, including a dependency failure and a false-positive signal. Time how quickly the team can identify the incident lead, communicate scope, and verify recovery from the user perspective. Bring the operations lead, a frontline user, a technical maintainer, and a control or finance partner into the review. They should agree on which result is authoritative, which failures stop work, which failures can be retried, and how a customer or colleague is informed. CISA's incident response planning guidance is written for security incidents, but its emphasis on documented roles, communications, and preparation transfers well to important business-system failure paths. The goal is not to label every defect an incident; it is to ensure that a consequential failure has a practiced route to a decision.
Release in small, observable slices
Choose a bounded population, a reversible change, and a time-boxed observation period. Baseline the current process first, including hidden spreadsheet steps and side-channel conversations, so the team can tell whether operations control rooms reduced work or simply moved it. Alerts without service ownership, dashboards that hide freshness, severity based only on infrastructure symptoms, conflicting status channels, and incident notes that cannot be linked to the underlying change or dependency. A release plan should include reconciliation before and after cutover, a clear support contact, and criteria for expanding, pausing, or rolling back. Avoid a big-bang migration when old and new records cannot yet be compared. A small parallel run is often worth the effort because it reveals semantics that diagrams miss: a late edit, a user with two roles, a correction from a trusted source, or a downstream system that acknowledges work before it is actually complete.
Measure useful operation
Measure the health of the decision path, not only system uptime. For this control room, useful signals include detection-to-acknowledgement time, percentage of alerts with an owner and runbook, false-positive rate, repeated-page rate, time to confirmed recovery, and unresolved post-incident actions. Review them with examples from real work rather than a single aggregate score. Google SRE's monitoring guidance distinguishes the fast signals used to detect a condition from the detailed evidence used to diagnose it; the same distinction helps business systems. An alert should name a service or process owner and indicate the next investigation step. A monthly review can retire noisy checks, address repeated exceptions, and make planned changes visible to the teams that will discover their effects first. production operations guide offers additional context for treating those reviews as an operating routine.
Design the shift, not just the screen
Treat every active condition as a managed work item. It needs severity, affected service, declared impact, incident lead, next update time, current hypothesis and recovery criterion. A small company may combine roles, but it should not leave them implicit. The incident lead coordinates; service owners diagnose; a communications owner maintains the approved status; a scribe records decisions and timestamps. The operations control room playbook develops this command pattern, while the enterprise control-room guide covers platform considerations and the case-management security review explains why operational records need controlled access.
For example, a payment service alert should not merely show elevated latency. The control room should expose checkout success, payment-provider dependency health, the last material change, retry safety, affected regions and the person who can disable a risky route. Rehearse a provider timeout and a misleading false positive. CISA’s incident response planning guide is security-oriented, but its preparation, role and communication disciplines transfer directly. After each exercise, remove one noisy signal, repair one unclear escalation and verify one runbook step with a person who did not write it.
| Shift checkpoint | Evidence on the board | Decision owner |
|---|---|---|
| Start of coverage | Critical services, changes, risks and named on-call staff | Shift lead |
| Condition declared | Impact, severity, lead and next update | Incident lead |
| Mitigation chosen | Risk, authority, rollback and expected signal | Service owner |
| Recovery proposed | User outcome, reconciliation and watch period | Incident lead |
| Shift handoff | Open actions, hypotheses and deadlines | Incoming shift lead |
Key takeaways
- Begin operations control rooms with one consequential decision and a named operations lead.
- Define lifecycle states, authority, effective time, and correction before automating handoffs.
- Use stable references and an explicit exception path across every consequential exchange.
- Protect sensitive data and high-impact changes with proportionate access, review, and audit records.
- Release with reconciliation and real failure cases, then use operating evidence to improve the path.
Frequently asked questions
What is the first practical step for operations control rooms?
Choose one recurring control room event that currently causes rework or uncertainty, name its accountable owner, and map its source, states, consumers, deadline, and correction route. That produces a testable boundary for operations control rooms without requiring an enterprise-wide redesign.
When is automation ready?
Automation in operations control rooms is ready when the team can explain the normal result, duplicate behavior, rejection route, correction method, and who is allowed to change the rule. Test those cases with representative control room records before relying on volume or a dashboard as evidence of readiness.
Conclusion
An effective operations control room shortens the distance between a meaningful service condition and an accountable decision. Build the command model before buying more displays, make status and authority explicit, and test recovery from the user’s point of view. When a growing team can hand over a live condition without losing context, distinguish detection from diagnosis, and prove that service has recovered, the control room has become an operating capability rather than a presentation layer.
