Guidewire Cloud Services: Scope, Cost, Risks and Delivery Plan

A delivery plan for Guidewire Cloud services covering insurer outcomes, platform scope, migration, data, integrations, security, testing, cost, releases and operating ownership.

Edilec Research Updated 2026-07-06 Cloud & DevOps

Guidewire Cloud services should deliver a dependable insurance capability on Guidewire Cloud Platform, not merely complete a technical migration. The scope may include strategy, product and process design, InsuranceSuite configuration, data conversion, integrations, digital experience, testing, release engineering, security, cutover and managed support. Each workstream changes different evidence and ownership. A delivery plan must connect them through policy, billing and claims outcomes so that component completion cannot conceal an unusable end-to-end service.

This plan is distinct from the Guidewire Cloud service implementation checklist and Guidewire Cloud service FAQ. It uses Guidewire’s current platform documentation to frame environments, deployment and shared responsibility, but exact capabilities must be confirmed for the customer’s release, region, products and contract. Start with insurer decisions and constraints; then choose the smallest migration wave that proves configuration, data, integration and operations together.

1. Define outcomes and service boundaries

Name the lines of business, jurisdictions, distribution channels, user groups and lifecycle transactions in scope. Set outcome baselines such as product-change lead time, quote completion, billing accuracy, claim handling time, release effort, incident exposure and infrastructure burden. Record nonfunctional constraints for availability, recovery, catastrophe capacity, close periods, privacy and residency. “Move to cloud” is not an outcome; it cannot determine whether a design trade-off is acceptable.

Build a service decomposition across Guidewire-operated platform capabilities, insurer configuration, implementation-partner work, external systems and business operations. Assign accountable owners for product rules, integrations, data, identity, testing, cutover and production service. Define acceptance at these boundaries. A partner can deliver code, but the insurer must own product intent and residual risk. Keep commercial deliverables linked to usable business increments rather than documents or component counts.

2. Baseline the current estate and target design

Inventory applications and versions, product models, extensions, batch jobs, documents, reports, integrations, identities, operational tools, data stores and archives. Link each item to a business capability and owner. Analyze incident history, release bottlenecks, unsupported technology and manual workarounds. Mark evidence confidence; do not let an incomplete inventory delay all progress, but close gaps around the first migration wave before design is approved.

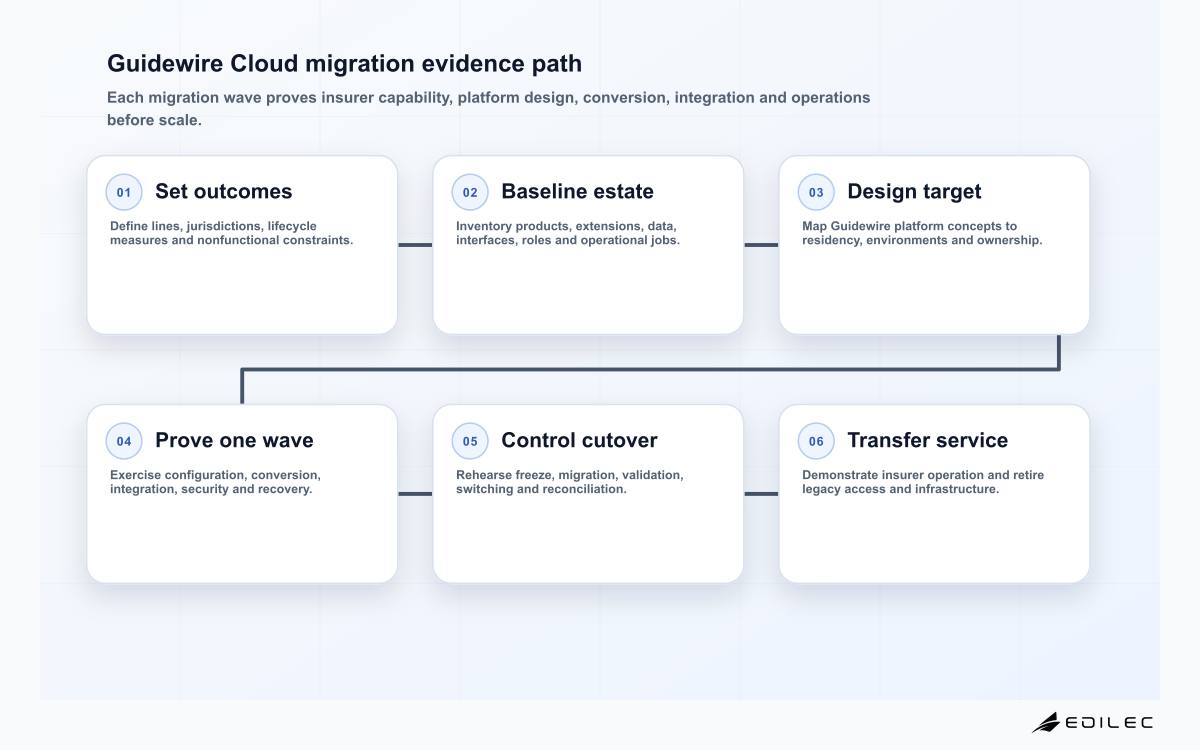

Guidewire Cloud migration evidence path
A Guidewire migration completes when permanent insurer teams can operate the target service and legacy obligations are closed.

Design the target using Guidewire Cloud Platform concepts and supported patterns for the selected release. Map isolation zone, tenant, star systems and planets to residency, business units and lifecycle environments. Decide how InsuranceSuite, integration apps, digital applications, data services and external platforms interact. Record architecture decisions with alternatives, consequences and validation method. Avoid reproducing every on-premises boundary when a simpler supported service meets the business requirement.

WorkstreamCore artifactAcceptance evidence
Product and configurationApproved product and rule designLifecycle scenario results
Data conversionVersioned mappings and reconciliation planControl totals and executable migrated cases
IntegrationOwned interface contractsFailure, retry and reconciliation tests
OperationsService model and runbooksObserved incident and recovery rehearsal

3. Plan data conversion and integration together

Profile source data for completeness, validity, duplicates, relationships, history and sensitive fields. Decide what converts, what archives and what is retired. Define canonical identifiers, transformation rules, financial control totals and record-level sampling. Rehearse conversion repeatedly with measured duration. Converted data must work in real transactions, not only satisfy counts; test renewal, endorsement, billing and claim activity on representative migrated records.

Catalog interfaces with contract, ownership, authentication, volume, latency, retry, ordering, reconciliation and degraded behavior. Redesign unsupported or tightly coupled exchanges rather than wrapping them blindly. Sequence external-system changes with conversion and cutover because data authority moves across the same boundary. During coexistence, identify the writer of record and prevent uncontrolled dual updates. Ensure replay is idempotent and business operations can see unresolved integration exceptions.

4. Establish security, privacy and delivery controls

Apply Guidewire’s shared-responsibility guidance to the actual solution. The insurer owns classification, approved use, roles and customer-introduced components; Guidewire operates underlying platform responsibilities; partners may implement controls under insurer authority. Design identity federation, lifecycle, privileged access, service identities and emergency paths. Keep production data out of lower environments unless expressly authorized and protected. Map third-party flows and confirm regional handling.

Protect code, configuration and infrastructure definitions through reviewed repositories, separated credentials, dependency inventory, automated checks and traceable promotion. Threat-model custom Gosu, integrations, documents and web experiences. Define vulnerability triage and remediation across organizations. Logs should reconstruct security and business events without uncontrolled personal-data duplication. Confirm penetration-testing boundaries and incident evidence access before a real event.

5. Prove the solution through a representative wave

Choose a wave that is narrow enough to control but complete enough to expose hard seams: one meaningful product or jurisdiction, realistic conversion, core integrations, user roles and operational support. A demonstration with clean new-business cases will not prove in-force change, billing reconciliation or claims. Establish entry and exit evidence for configuration, data, security, performance, accessibility, operations and business acceptance. Use production-like volume and governed data.

Run release and failure rehearsals. Deploy the exact promoted artifact, test rollback or forward repair, interrupt dependencies, restore data, invoke downtime procedures and reconcile after recovery. Include catastrophe or peak scenarios relevant to the insurer. Track defects by business consequence and root condition, not only severity labels. The wave is complete when permanent teams can run it and evidence meets thresholds, not when the project calendar reaches its planned end.

Cost categoryOften missed itemPlanning treatment
ImplementationInsurer subject-matter capacityNamed allocation by wave
PlatformVariable usage and extra environmentsScenario range and owner
TransitionDual run and reconciliationTime-bounded explicit budget
ExitLegacy archive and decommissioningClosure criteria and retained obligation

6. Model cost, schedule and risk transparently

Build a work breakdown for discovery, design, configuration, remediation, conversion, integration, testing, environments, partner services, training, dual run, cutover and decommissioning. Add insurer subject-matter time and ongoing platform, usage and support charges. Use ranges with assumptions rather than false precision. Schedule around product filings, renewals, billing close, catastrophe seasons and change freezes. Explicitly price rework from unknown customization and poor data quality.

Maintain a risk register with trigger, consequence, mitigation, contingency, owner and review date. Typical risks include unsupported extension, underestimated conversion, partner capacity, integration dependency, test-environment delay, role conflict and insufficient operating skill. Quantify schedule or cost exposure where evidence supports it. Do not hide uncertainty in a fixed-price boundary; unresolved assumptions usually reappear as change requests or reduced acceptance scope.

7. Cut over and transfer durable ownership

Plan cutover as a timed, rehearsed control procedure. Define data freeze, final extraction, transformation, validation, interface switching, smoke tests, business confirmation, communication and go/no-go authority. Establish rollback feasibility and a forward-repair path for transactions that cannot be reversed. Staff technical and business command, record decisions and reconcile every deferred or manually handled transaction after service begins.

Transfer production ownership through demonstrated capability. Permanent teams should deploy, monitor, handle an incident, restore data, resolve an integration exception and explain escalation. Deliver current source, configuration, data mappings, tests, runbooks, decision records and open risks into insurer-controlled systems. Retire legacy jobs, credentials, interfaces, licenses and data according to policy. Schedule post-launch reviews against outcome baselines and fund the next release backlog.

For guidewire cloud services: scope, cost, risks and delivery plan, maintain an acceptance ledger that links each material requirement to an owner, implementation evidence, test result, residual limitation and review date. Sample the evidence with people who operate the service, not only its builders. Re-open acceptance when a provider, data source, integration, user population or authority boundary changes. This ledger prevents a successful launch label from concealing expired assumptions, incomplete handover or controls that were demonstrated once but cannot be exercised by the permanent team.

Before closing each Guidewire delivery wave, reconcile the insurer’s production topology with the design inventory. Confirm which planets and applications contain sensitive data, which integrations can create financial or policy state, which batch jobs must finish before business opens and which supplier contacts can act outside normal hours. Review pending Guidewire release changes against customer configuration and regression coverage. This operational topology becomes the basis for cutover command, incident routing and future release planning; without it, knowledge remains divided among partner specialists and cannot support accountable insurer ownership.

Key takeaways

  • Anchor scope in measurable insurance outcomes and jurisdictions.
  • Map Guidewire platform responsibility to insurer and partner ownership.
  • Design conversion, integrations and coexistence as one transition system.
  • Use a representative wave to prove business and operational evidence.
  • Transfer capability and decommission legacy obligations before declaring completion.

Frequently asked questions

What usually drives Guidewire Cloud implementation cost?

Product and process variation, customization remediation, data quality, integration count and complexity, test breadth, organizational change and coexistence typically drive effort. Platform and partner commercials add separate fixed and variable elements.

Is a big-bang migration ever appropriate?

It may be necessary where state is tightly coupled or long coexistence is riskier. It requires stronger data rehearsal, capacity testing, command structure, downtime planning, reconciliation and rollback or forward-repair evidence.

What should remain under insurer control?

Business rules, data definitions, architecture decisions, production approvals, authoritative repositories, test evidence, risk acceptance and service ownership should remain controlled by the insurer even when partners perform substantial delivery work.

Conclusion

Guidewire Cloud services create value when they leave the insurer with a current, operable core platform and the ability to change it safely. The plan must integrate product, data, interfaces, security, release and business adoption. Treating these as separate supplier tracks increases late discovery and weakens acceptance.

Use evidence gates at each wave, confirm platform assumptions against current Guidewire documentation and make insurer ownership visible throughout delivery. Close the program only after permanent teams operate the service and legacy obligations are retired. That is the difference between completing a migration project and establishing a sustainable Guidewire Cloud capability.
