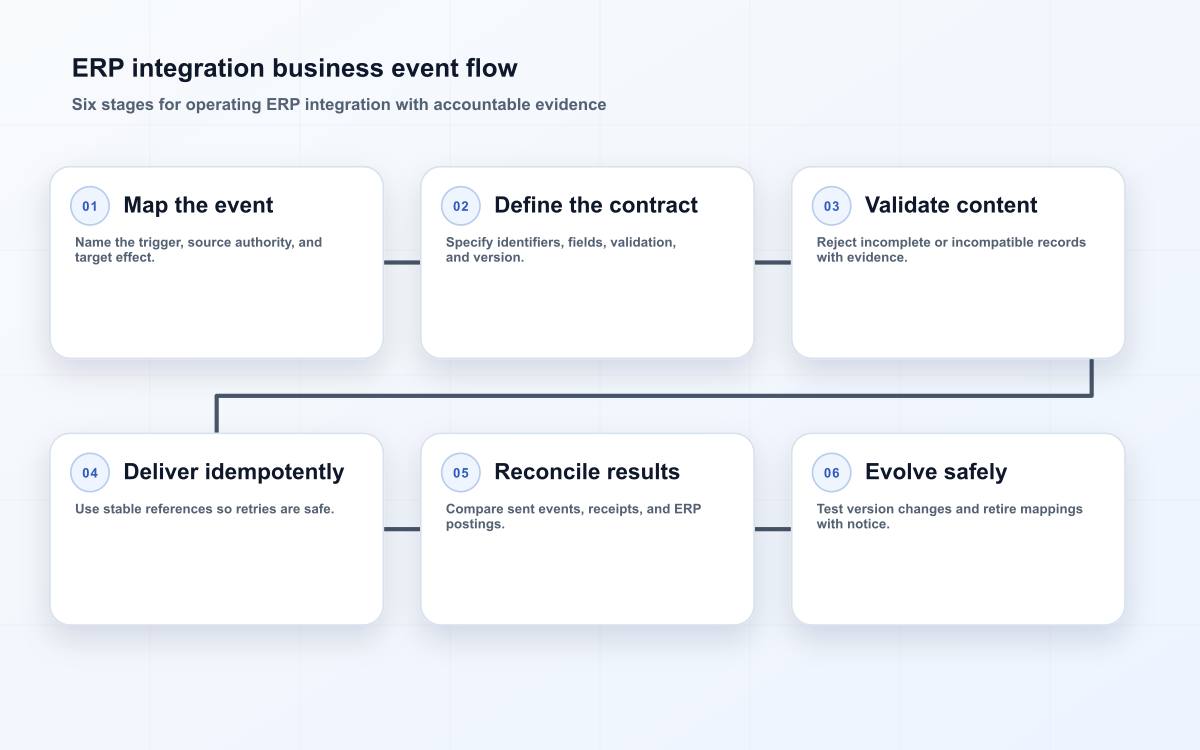

ERP integration is not a tooling category; it is a controlled way to make an approved purchase order must create the intended ERP commitment exactly once and make failures visible to procurement and finance. The first design question is therefore about the decision and its evidence, not the product logo or orchestration style. Teams should be able to identify business events, canonical identifiers, mappings, validation rules, authentication, delivery receipts, and reconciliation records, explain the moment at which each becomes authoritative, and reproduce the result when an upstream record changes. Starting here prevents a familiar failure: a useful operational question becomes a broad platform programme with no testable first release.
Map the business event and target effect
Write the workflow as a short decision record. For ERP integration, specify the actor who needs the answer, the event that starts work, the system that owns each material fact, the time boundary, and the action that follows. Then walk through a source event is created, amended, cancelled, retried, or rejected by the target system. This exercise turns vague requirements into observable behavior. It also exposes whether the proposed design can preserve context when a person joins midstream, when data arrives twice, or when a corrective action needs to be explained months later.

| Question | Working rule | Evidence |
|---|---|---|
| Decision | State the outcome and the person accountable for it. | an approved purchase order must create the intended ERP commitment exactly once and make failures visible to procurement and finance |
| Authority | Separate business policy from technical operation. | the source domain owns event meaning, ERP owners approve posting behavior, and integration owners operate delivery and reconciliation |
| Change | Treat corrected and late data as normal cases. | a source event is created, amended, cancelled, retried, or rejected by the target system |
| Exception | Keep a visible route rather than a silent bypass. | a point-to-point mapping that cannot distinguish a safe retry from a duplicate financial posting |
Model the records and handoffs
A reliable ERP integration design uses boundaries that people can inspect. Describe the input record, the validation point, the durable identifier, the state transition, and the acknowledgement from the next system or team. Do not infer ownership from where a value happens to be stored. One application may capture a fact while another applies policy, and a third presents the result. Those roles can coexist when the contract says which service is allowed to create, correct, publish, or merely consume each fact.
The most useful data model is usually small at first: preserve the original event or source value, attach the rule or model version used, record an effective timestamp, and retain the reason for an override. Those details make corrective work possible without rewriting history. They also make related disciplines easier to connect, including CRM Automation: Accountable Workflows and Operating Evidence, Customer Portals in Production: Authority, State, and Release Controls, what changes when operations control rooms move into production. The goal is not documentation for its own sake. It is a system where operations can answer what happened, why it happened, and what must happen next.
| Layer | Design decision | Operational check |
|---|---|---|
| Input | Define identity, grain, required fields, and acceptance criteria. | Can the team reject or quarantine incomplete ERP integration inputs? |
| Policy | Version thresholds, mappings, and eligibility logic. | Can a reviewer see which rule produced the ERP integration result? |
| Action | Make state change, owner, and acknowledgement explicit. | Can retries happen without duplicating the consequence? |
| Recovery | Route disputes, late facts, and corrections to an owner. | Can the prior result be reconciled after a correction? |
Build one observable path
Choose a first path that is consequential enough to matter but narrow enough to replay. For ERP integration, that means collecting real examples before configuring rules: ordinary cases, incomplete cases, contradictory cases, and cases where a downstream consumer has already acted. Run those examples through a test environment with production-like identities and permissions. The outcome should show accepted input, rejected input, the accountable queue, the downstream effect, and the recovery route. A demo that shows only a successful happy path is not evidence that the operating workflow is ready.
- Name the decision and success condition for the first ERP integration path.
- Record business events, canonical identifiers, mappings, validation rules, authentication, delivery receipts, and reconciliation records with an owner and effective-time rule.
- Test a source event is created, amended, cancelled, retried, or rejected by the target system before allowing broad adoption.
- Use durable identifiers and idempotent behavior for retried work.
- Give operators a queue, reason code, and escalation contact for exceptions.
- Instrument delivery latency, validation rejection rate, duplicate attempts, unreconciled postings, mapping changes, and recovery time from the first release.
Set controls that support work
Controls should make unsafe behavior harder while keeping legitimate work moving. Apply least privilege to create, approve, override, and administer actions; log material decisions with their inputs and rule version; and review elevated access on a schedule that matches the risk. A useful control also has an operator story. When a person cannot proceed, the interface should say what evidence is missing, who can decide, and whether the request can be saved or withdrawn. That is much stronger than a generic error or an informal side channel. For ERP integration, the control emphasis is proving that an event can be retried, cancelled, and reconciled without creating an untraceable duplicate in the ERP.
Use primary guidance with local evidence
The implementation details will depend on the systems already in use, but the core practices are well represented in primary documentation. Useful references for this design include Dynamics 365 documentation, SAP Help Portal, Salesforce Help, NIST Cybersecurity Framework 2.0. Read them as technical and governance inputs, then verify every claim against the organization’s own records, obligations, and operating constraints. Vendor guidance can explain supported capabilities; it cannot decide who should own a business exception or which evidence a regulated decision requires. In this ERP integration context, translate that guidance into named local owners, tested configuration, and records that can be inspected during an incident or audit.
Measure reliability and decision quality
Measure ERP integration as a living service rather than a completed deployment. Track delivery latency, validation rejection rate, duplicate attempts, unreconciled postings, mapping changes, and recovery time. Segment results by source, workflow state, policy version, and owner so a rising average does not conceal a struggling queue. Review a small sample of completed and corrected cases alongside the metrics. Numbers reveal a pattern; the records reveal whether people understood the rule, whether the automation had enough context, and whether a customer or colleague encountered an avoidable delay.
Key takeaways
- ERP integration starts with a business decision and a defined evidence boundary.
- Make the source domain owns event meaning, erp owners approve posting behavior, and integration owners operate delivery and reconciliation visible in the workflow.
- Design explicitly for a source event is created, amended, cancelled, retried, or rejected by the target system, not only for routine cases.
- Keep corrections, acknowledgements, and exceptions reviewable.
- Use delivery latency, validation rejection rate, duplicate attempts, unreconciled postings, mapping changes, and recovery time to decide whether the next expansion is justified.
Frequently asked questions
What is the smallest useful scope for ERP integration? Start with one decision where an incorrect, late, or untraceable result creates real cost. Include the normal path and the recovery path. The first release should establish shared language, ownership, and evidence; it does not need to centralize every adjacent process.
When should a person intervene? A person should decide where policy is ambiguous, source evidence conflicts, an action has material financial, customer, or access consequences, or an automated result falls outside an agreed rule. The workflow should preserve the recommendation and the human rationale rather than hiding either one. For ERP integration, intervention is especially important when proving that an event can be retried, cancelled, and reconciled without creating an untraceable duplicate in the ERP.
How do we know the workflow is ready to scale? Expand after the team can replay representative cases, reconcile the output with source records, explain exceptions within the operating target, and show that the named owner actually reviews the signals. Scale is an outcome of repeatability, not simply of higher event volume. In ERP integration, readiness also means that the team has rehearsed the failure modes specific to its decision boundary rather than assuming a successful demonstration is enough.
Review before expansion
Before adding more scope, conduct a ERP integration operating review. Replay a valid event, a duplicate delivery, an invalid payload, and a cancellation. Compare source event IDs, integration logs, target receipts, ERP postings, and repair queue entries. A sound release has an answer for every mismatch, including who can correct mapping data and how the change is tested before it affects financial processing. Publish the resulting actions with an owner and due date, then repeat the same cases after the changes land. A repeatable review rhythm protects the first workflow from quiet drift and gives the next investment decision a firmer basis than anecdote.
Conclusion
ERP integration becomes dependable when its decisions, records, authority, and recovery behavior are designed together. Begin with an approved purchase order must create the intended ERP commitment exactly once and make failures visible to procurement and finance, make the first path observable, and treat exceptions as product requirements rather than inconvenient leftovers. That approach gives engineering and operations a basis for a useful next release: one supported by traceable evidence, meaningful measures, and clear accountability.
