Approval workflow software are worth building when they make a real operating decision safer, faster, or easier to explain. An approval request sent through chat may be quick, but later nobody can reliably answer what was approved, under which policy, with what evidence, or whether the approver had authority. Software is justified when the decision needs consistency, visibility, and a defensible record. Founders should begin with an approval decision with a policy, requester, evidence set, threshold, authorized approver, deadline, and final outcome, because that exposes the people, systems, policy constraints, and evidence a useful product must connect. The objective is not a prettier version of a spreadsheet. It is a dependable path for work that leaves enough context for the next person, survives an integration failure, and can be measured after release.
Key takeaways
- Start with an approval decision with a policy, requester, evidence set, threshold, authorized approver, deadline, and final outcome, not a collection of screens.
- Make explicit which decisions need approval, when a rule can decide automatically, and what authority and evidence an exception requires.
- Keep a named source of truth for important facts and record consequential changes.
- Enforce permissions on the server and test denied paths as carefully as allowed paths.
- Use release evidence and production signals to improve approval workflow software after launch.
Map the approval workflow software decision

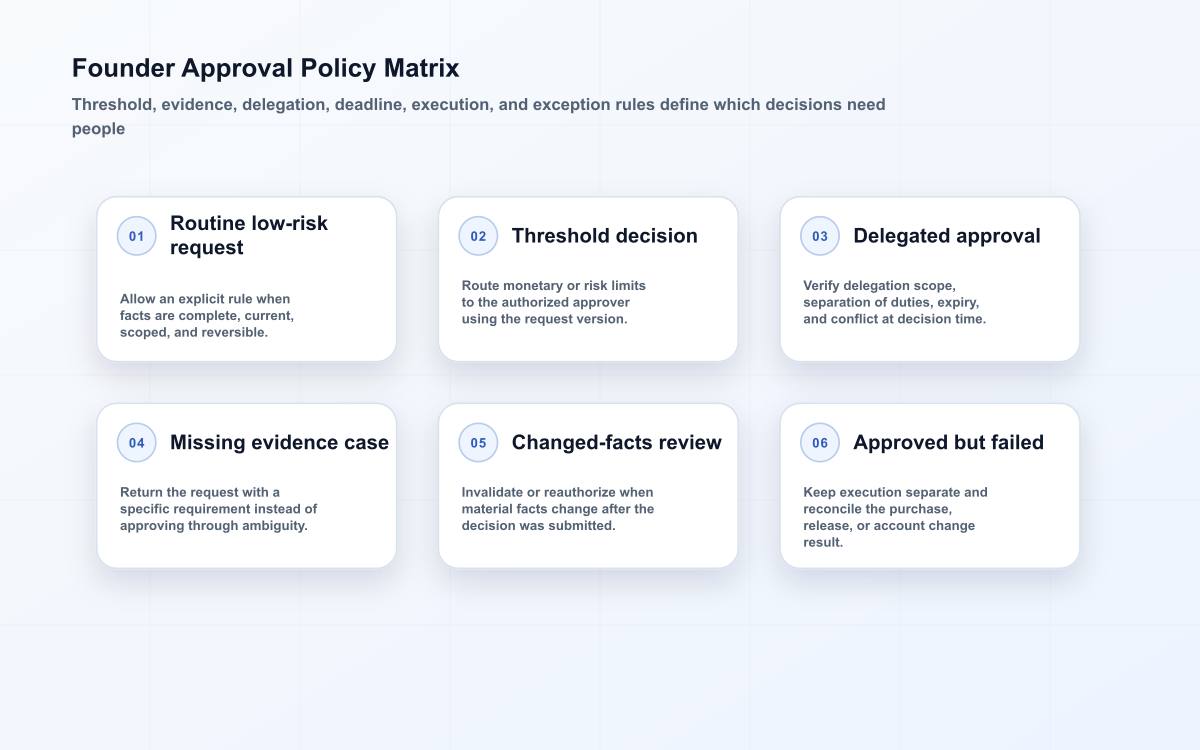

The first workshop should follow a concrete example from beginning to end. Ask who initiates it, what information is needed, what rule determines the next step, who owns a delay, and what a satisfactory outcome looks like. Capture the ordinary path and the exceptions that staff already solve by email or chat. This creates a shared operating model and avoids a common delivery error: building a surface that looks complete while leaving the most consequential handoff outside the system. The resulting map should name which decisions need approval, when a rule can decide automatically, and what authority and evidence an exception requires.

| Planning element | Question to answer | Useful evidence |
|---|---|---|
| Outcome | What business result should this journey produce? | A completed example with a clear owner. |
| State | What changes and who may make that change? | A transition rule and audit entry. |
| Data | Which system owns the fact? | Field lineage and refresh expectation. |
| Exception | What happens when the ordinary path fails? | A queue, timer, and recovery owner. |
Set a deliberate approval workflow software boundary
Write the policy before configuring the workflow. Define what starts a request, the facts used for routing, monetary or risk thresholds, required evidence, service target, reject-and-return behavior, delegation limits, and retention needs. Keep policy terms separate from interface labels so a change in wording does not silently alter a control.
Make data and access explicit

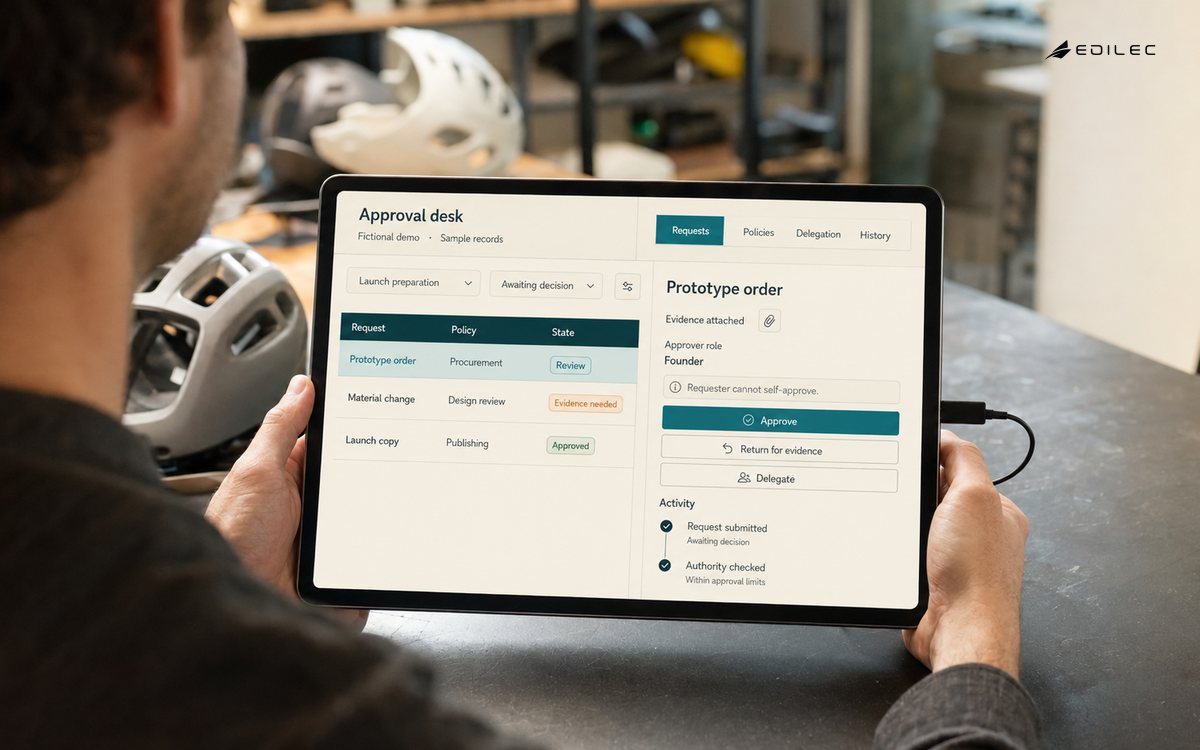

Make the decision record durable. Retain the request version, policy version, inputs used for routing, evidence references, approver identity, delegated authority if applicable, comments, timestamps, and outcome. A resubmitted request should receive a new version or clear amendment chain; otherwise an old approval may be mistaken for approval of changed terms.
| Condition | Control | Release check |
|---|---|---|
| User requests a protected action | Evaluate role, record scope, and action on the server. | Attempt the action with an unentitled account. |
| An integration is retried | Use a durable identifier and record the prior outcome. | Send the same command twice. |
| A record changes concurrently | Detect a stale version or reconcile deliberately. | Submit an edit after another change. |
| A support issue is investigated | Link logs, events, and audit history by correlation ID. | Trace a test item across the workflow. |
Build security and usability in
Enforce separation of duties where the risk warrants it. A requester should not approve their own request simply by changing a client-side field, and an administrator should not obtain unrecorded approval power. Apply server-side authorization to every transition, protect evidence access, and use a reasoned override path with review rather than a universal bypass button. The NIST Secure Software Development Framework is a practical reference for making secure design, verification, release integrity, and vulnerability response part of normal delivery. For browser-facing work, WCAG 2.2 gives testable accessibility guidance that also improves day-to-day task completion.
Assign ownership and change control
Founders need a lightweight but explicit ownership model for approval workflow software. Name the business owner who decides what good looks like, the service owner who is accountable for availability and recovery, the data owner who approves material changes, and the person who may accept residual risk. Keep a dated decision log for policy changes, interface changes, and temporary exceptions. When a rule changes, identify records already in flight and decide whether they remain under the old rule, are recalculated, or need a human review. That discipline prevents a routine release from silently changing the meaning of work already promised to a customer or colleague.
Verify before expanding access
Before widening approval workflow software to another team, tenant, or workflow, rehearse the conditions that usually create expensive support work. Use representative data, deliberately incomplete inputs, slow or unavailable dependencies, duplicate requests, and a user whose permission should be denied. Confirm that the team can find the event, explain the state, correct it without hidden database edits, and communicate the next step. A release gate should include functional acceptance, accessibility checks where relevant, authorization tests, integration contract evidence, and a documented limit on what can be rolled back. Passing a demonstration is useful; passing these operating checks is stronger evidence.
Prepare support and recovery
Write a short support playbook before the pilot. It should state the service objective, ownership hours, dashboards or searches to use, expected state transitions, escalation contact, and safe repair actions for approval workflow software. Include a communication template for a client-facing delay and a reconciliation step for any action that may have completed in one system but not another. Runbooks should be tested with a realistic case, not left as an aspirational document. This is particularly important when an application coordinates several teams: a fast technical restart does not resolve an item whose business owner, evidence, or downstream status remains unclear.
Release with operating evidence
Pilot one decision class with known volume and edge cases. Exercise missing evidence, an unavailable approver, a delegation expiry, changed facts after submission, duplicate notifications, and a downstream failure after approval. Track elapsed time in each state and make the current owner visible; reminders are useful only when an accountable person can act. Use OpenTelemetry documentation as a reference when agreeing how services emit traces, metrics, and logs. Monitoring should answer an operational question: which step is delayed, for whom, and why? It should not be a collection of technical charts disconnected from the work the application is meant to improve. Related delivery practices are also covered in this multi-role business applications guide.
Avoid common approval workflow software failures
The main mistake is automating a vague process. That creates a faster route to inconsistent decisions. Another is treating an approval as the same thing as execution: a purchase, release, or account change may still fail after permission is granted. Represent those outcomes separately and reconcile failures.
Measure and improve
Choose measures that connect software behavior to the operating problem. For this work, inspect approval cycle time by threshold, requests returned for missing evidence, overdue decisions, overrides, delegation use, and execution failures after approval. Establish a baseline before the pilot, segment results by workflow type or role where that changes the meaning, and pair numbers with sampled cases. A lower average time can conceal more work being pushed into an unowned exception queue. Review the evidence with the people responsible for the outcome, then change the policy, interface, integration, or training that the cases actually support.
Keep decisions explainable
As approval workflow software mature, the difficult question is rarely whether the application can execute a rule. It is whether a supervisor, auditor, support colleague, or affected user can understand the decision later. Preserve the facts used at the time, the rule or policy version, the actor or automated service that acted, and the reason an exception was accepted. Explainability does not require exposing private implementation details; it means the accountable team can distinguish a valid decision, an incomplete request, a stale input, and a system failure. Review a small sample of completed and exceptional cases every release. Those reviews reveal ambiguous policy, misleading interface language, and integration assumptions long before aggregate metrics make the problem obvious. For founders, this review is also the clearest way to decide whether the next investment belongs in policy, process, data quality, or software.
Frequently asked questions
Should the first release include every role and exception? No. For approval workflow software, support one complete, valuable journey and the controls needed to operate it responsibly. Defer a role only when there is a safe, owned way to handle its work outside the new application; do not defer the authorization or audit rule that protects the released path.
How should the team handle errors from connected systems? In approval workflow software, decide whether a request is rejected, accepted for later processing, or completed with a warning. Give callers a stable, useful response. RFC 9457 standardizes problem details for HTTP APIs, but error messages should help a user correct an issue without exposing internal implementation or sensitive information.
Conclusion
Approval workflow software become durable when the team can explain the work, data authority, permission boundary, exception route, and evidence of benefit. Begin with the smallest accountable journey, release it with observability and recovery in place, and let measured operating experience determine the next investment. That approach protects both users and delivery capacity while producing software that can grow with the business.
