HRMS Workflow Planning for Accountable Employee Changes

Use HRMS workflow planning to make employee changes, approvals and access updates traceable from request through reconciliation.

Edilec Research Updated 2026-07-16 Enterprise Systems

HRMS workflow planning is best treated as an operating-design decision, not a screen or routing exercise. HR, IT and people-operations leaders should begin with one observed journey: a hire, transfer, leave change, manager update or termination. Follow that journey from initiation to a confirmed outcome, including the moment an operator must make a judgement. The useful question is not whether every task can be automated or displayed. It is whether the organization can show who owns the work, what evidence supports the next action and how the work is recovered when something goes wrong. This guide uses that discipline to turn an ambitious systems idea into a release that people can operate under ordinary pressure. For this workflow step, name the accountable owner, supporting evidence, exception route, and next measurable check.

Start with recent examples rather than an idealized process map. Ask participants which information they trusted, where they had to leave the HRMS, identity provider, payroll application and document repository, and what delayed the case. Include an example involving a retroactive change, missing manager, conflicting employment date and access that did not deprovision. The resulting evidence often exposes hidden approvals, parallel spreadsheets and unclear responsibilities that a requirements workshop misses. It also makes scope practical: the first release should support the normal path, a meaningful exception, administration and support, while deferring adjacent work that cannot yet be owned safely. Within this workflow step, name the accountable owner, supporting evidence, exception route, and next measurable check.

Define the operating outcome

Write the release outcome as an observable statement: when a hire, transfer, leave change, manager update or termination occurs, employee, manager, HR specialist, payroll reviewer and identity administrator can reach an authorized, evidenced and traceable result. Then name the boundary around the employee profile, employment status and associated approval evidence. A boundary is not a technical limitation; it is an agreement about which facts the system owns, which it only reads, and which decision remains outside the release. Make the next step visible in every state. When a user cannot tell why work stopped, the process has simply moved its uncertainty into a queue. When implementing this decision boundary, name the accountable owner, supporting evidence, exception route, and next measurable check.

Design layerDecision to makeEvidence before release
Business eventWhat starts a hire, transfer, leave change, manager update or termination and who may initiate it?Examples drawn from current operations
Record boundaryWhich system owns the employee profile, employment status and associated approval evidence?Named identifiers, permitted editors and consumers
Decision rightWho may decide who may approve a people change and when identity or payroll actions may follow?Authority matrix and delegation rule
Exception pathHow are a retroactive change, missing manager, conflicting employment date and access that did not deprovision handled?Queue, service target and accountable owner
Operating reviewHow will change completion time, payroll correction rate, overdue approvals and access-change reconciliation rate change decisions?Metric definitions and review cadence

Design the record and decision

Model the business record before modelling fields or integrations. For HRMS workflow planning, the record is the employee profile, employment status and associated approval evidence; it needs a stable identifier, effective time, current state, source, owner and history of material changes. Distinguish a system that displays a fact from the system authorized to correct it. That distinction prevents every interface from becoming a competing source of truth. The W3C PROV model is a useful reference when the team needs to preserve the relationship among a record, the activity that changed it and the person or system responsible. Before releasing this data handoff, name the accountable owner, supporting evidence, exception route, and next measurable check.

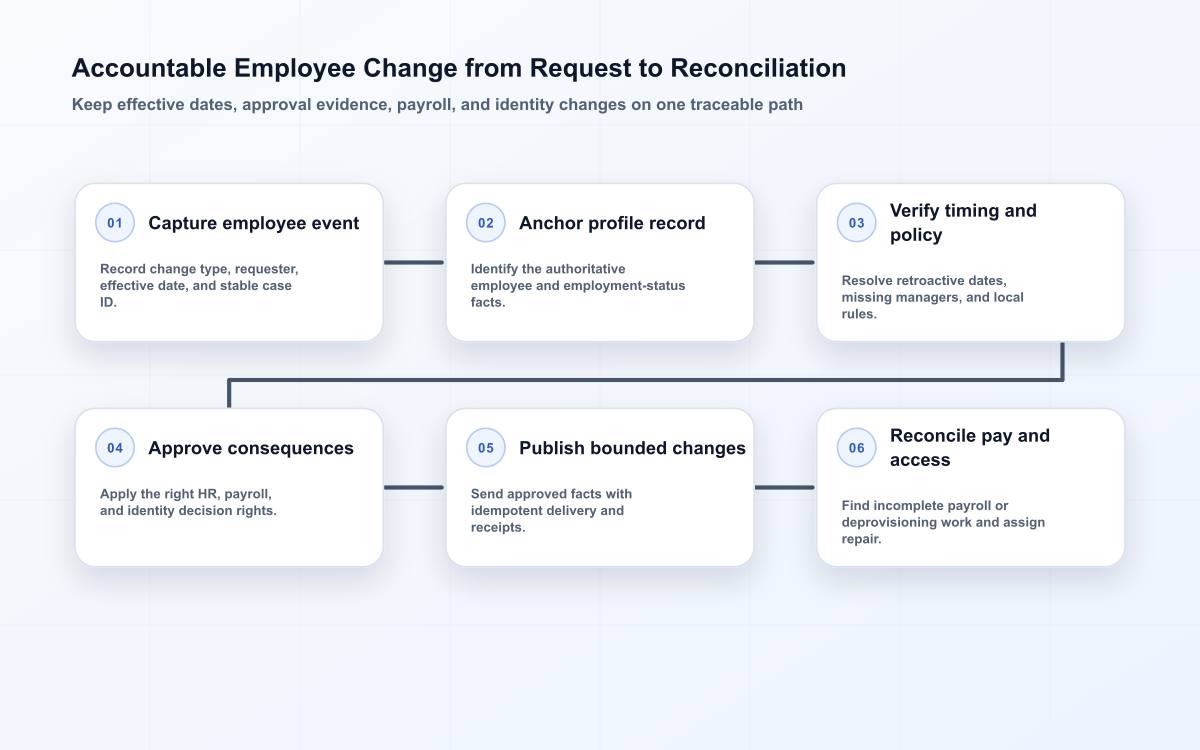

Six-stage HRMS flow for a hire, transfer, leave, manager update, or termination, ending with reconciliation of payroll and access results.
Model the employee change as a business record with effective time and decision authority, then prove that downstream pay and access actions completed or entered recovery.

Use states that answer a real operational question: what has happened, what may happen next, who has the authority to act and what evidence is still missing? Avoid using a generic “pending” status to conceal allowing downstream access or pay changes to outrun the authoritative employment decision. A state should carry an explicit owner and a service expectation. Where policy is ambiguous, route the work to a named reviewer. Automating an unresolved policy does not remove judgement; it only makes an eventual correction harder to understand and audit. While operating this data handoff, name the accountable owner, supporting evidence, exception route, and next measurable check.

Failure conditionRequired behaviorOperational evidence
Required information is absentKeep work recoverable and identify the person who supplies it.Validation message and incomplete-work queue
A downstream system failsAvoid duplicate action; retry under a documented policy.Correlation identifier, delivery state and alert
Two records disagreeProtect the authoritative record and open reconciliation work.Before-and-after values, source and decision owner
A decision is overdueEscalate according to policy without silently changing authority.Ageing measure and escalation history
An override is usedRecord reason, actor and any required retrospective review.Auditable override event and follow-up task

Connect systems with recovery in mind

Integrations should be designed around the event a receiving system needs, rather than around a promise to keep every screen identical. In this case, the HRMS, identity provider, payroll application and document repository need a clear contract for identifiers, authoritative timestamps, allowed updates and expected failure behavior. Send the smallest useful event; retain the source context needed for investigation. Version mappings, expose delivery status and give operators a visible reconciliation queue. A retry without a named owner is delayed failure, especially when a repeated message could create another financial, access or service action. When changing this operating step, name the accountable owner, supporting evidence, exception route, and next measurable check.

For delivery teams working on HRMS workflow planning, this recovery path should connect workflow authority, system-of-record ownership, approvals, exceptions, reconciliation, and reporting to evidence an accountable owner can inspect. Choose a synchronous call only when the initiating user truly needs an immediate response. For work that can complete safely later, asynchronous delivery can protect the user experience while giving operations a controlled recovery path. Both patterns require idempotency, duplicate handling and an answer to “what proves completion?” Review access and audit controls alongside the handoff. NIST SP 800-53 provides a useful control catalogue, but the release still needs test cases that reflect the organization’s actual privileges and exception decisions. In this operating review, move beyond the recovery path only after the owner can show the accepted result, the exception path, and the signal for another review.

Set controls that people can use

In HRMS workflow planning, delivery teams should make the relationship between workflow authority, system-of-record ownership, approvals, exceptions, reconciliation, and reporting explicit and reviewable. Controls work when they are proportional to the consequence of the action. Apply least privilege to material changes, separate incompatible duties where the risk warrants it and preserve a decision trail for exceptions. The NIST Cybersecurity Framework helps teams organize governance, protection, detection, response and recovery; it does not substitute for naming a business owner. Privacy and accessibility belong in this workflow too. Collect only information needed for the decision and test representative journeys with keyboard and assistive technology before calling the service ready. This operating review should close the operating decision only when the result, unresolved exception, and next review condition are recorded.

  • Define a hire, transfer, leave change, manager update or termination with a stable identifier, state model and evidence rule.
  • Name the owner for the employee profile, employment status and associated approval evidence, each decision right and every recovery queue.
  • Test a retroactive change, missing manager, conflicting employment date and access that did not deprovision as release scenarios, not just as notes in a process document.
  • Log material state changes, delivery attempts, overrides and reconciliations in a form operators can use.
  • Review permissions when people change roles, leave teams or receive delegated authority.
  • Give service and support teams a short runbook for triage, escalation and correction.

Measure and improve the service

Measure whether HRMS workflow planning makes work more dependable, not whether a dashboard has more activity. Establish a baseline for change completion time, payroll correction rate, overdue approvals and access-change reconciliation rate, document exactly how each signal is calculated and review it with people who can change the process. Separate normal-path performance from exception performance so a fast average does not hide difficult work displaced to private channels. Review manual bypasses closely: they frequently reveal a missing state, permission, integration rule or policy decision that should be made visible. To govern this evaluation, name the accountable owner, supporting evidence, exception route, and next measurable check.

A dependable HRMS workflow planning design makes workflow authority, system-of-record ownership, approvals, exceptions, reconciliation, and reporting visible to the owner responsible for this operating signal. Run a limited release with users who handle real volume and can identify uncomfortable cases early. During the review, inspect both completed and abandoned work. Ask whether the result, evidence and next owner were clear without oral context. Expand only when the workflow can be supported, reconciled and improved by the people responsible for it. That pacing produces durable evidence for the next investment decision and keeps the system grounded in how the organization actually works. The next step in this operating review is justified when the team can trace the accepted outcome, the fallback route, and the owner of follow-up.

Implementation checklist

  • Collect five real examples of a hire, transfer, leave change, manager update or termination, including a consequential exception.
  • Write the first-release outcome, record boundary and explicitly deferred work.
  • Validate authority and evidence rules with employee, manager, HR specialist, payroll reviewer and identity administrator.
  • Document interfaces, retries, reconciliation and an escalation path before build begins.
  • Instrument change completion time, payroll correction rate, overdue approvals and access-change reconciliation rate with an owner, baseline and review cadence.
  • Release narrowly, test recovery in production-like conditions and revise from observed work.

Key takeaways

  • HRMS workflow planning succeeds when ownership and evidence are as clear as routing or interface design.
  • A focused path with a real recovery model is more valuable than a broad system with hidden manual work.
  • Integration reliability includes observable delivery, duplicate safety and reconciliation, not just a successful demonstration.
  • The best measures connect an operating outcome to a decision a named owner can change.

Frequently asked questions

This operating decision for HRMS workflow planning is strongest when workflow authority, system-of-record ownership, approvals, exceptions, reconciliation, and reporting can be reviewed as one operating record. Should every adjacent process be replaced in the first release? Usually not. Start with the business event and record boundary that cause the most costly uncertainty, then integrate or retire surrounding tools once the new path has evidence. How much automation is appropriate? Automate repeatable, explainable decisions with a safe exception route; keep ambiguous or consequential decisions reviewable. Who owns the system? Business leaders own policy and outcome, while technology owners make the service secure, observable and maintainable. Both must agree on the recovery duty. For this part of the system, test one expected case, one ambiguous case, and one failure with a documented recovery action. Acceptance in this operating review requires a visible outcome, a bounded exception path, and a measurable reason to revisit the decision.

Conclusion

A dependable HRMS workflow planning initiative makes work more accountable, not simply more digital. Define the operating outcome, establish the record and decision model, make connections recoverable, apply usable controls and review real evidence. That sequence gives HR, IT and people-operations leaders a service that can move ordinary work efficiently and still explain itself when an exception matters. Within this part of the system, test one expected case, one ambiguous case, and one failure with a documented recovery action.
