What Operations Teams Should Know About Data Pipeline Planning

Data pipeline planning turns operational data movement into a dependable service with clear source contracts, timing expectations, quality checks, recovery, and ownership.

Edilec Research Updated 2026-07-12 Data & Analytics

What Operations Teams Should Know About Data Pipeline Planning starts with a practical question: can operations teams that depend on timely records but do not need to manage every implementation detail use an operations-aware data pipeline plan to decide whether the data needed for a workflow is complete, current, and safe to use at the agreed decision time without reconstructing the number in a spreadsheet or asking for private context? The answer depends less on how many charts or automated steps exist than on whether the reader can inspect meaning, scope, timing, and responsibility. Data Pipeline Planning is useful when it connects a stated decision to evidence that is current enough for that decision, and when it makes uncertainty visible instead of quietly averaging it away. This guide focuses on the operating choices that make the result explainable in routine work and defensible when a result is challenged.

Start with the decision data pipeline planning must support

Describe the work moment before designing the data product. For this subject, the relevant decision is whether the data needed for a workflow is complete, current, and safe to use at the agreed decision time. Ask the people who take that decision which record they inspect first, what would make them wait, and what response follows a material change. Their answers establish a decision horizon, a tolerable freshness window, and the detail needed to investigate. A weekly planning discussion has different needs from an intraday exception queue. Treating both as the same reporting requirement usually creates a crowded interface and an ambiguous service level. A compact decision statement also provides a useful scope boundary: every field, transformation, and visual should improve the action, the explanation, or the recovery path.

  • Ask operations users when the data becomes useless, not only when a job should run.
  • Separate source arrival, processing completion, and publication time.
  • Define a stable business key before relying on retries.
  • Make failure status understandable to the people planning work.

Make evidence inspectable in data pipeline planning

The working evidence for data pipeline planning is source contracts, expected arrival windows, observable quality rules, run status, replay behavior, and a named response owner. Put this information where a reader can use it, not only in a handover document. State what one row or event represents, distinguish business time from load and publication time, and preserve identifiers that make a published result traceable. A source can be authoritative for one question but not for every question; document that boundary. Where records are matched across systems, make the matching rule, ambiguity handling, and effective date reviewable. This is especially important when a summary combines events, snapshots, or manual corrections, because an unnoticed one-to-many join can produce a credible-looking but wrong total.

ElementQuestion to settleEvidence to retain
Source contractWhat records, fields, timing, and change notice are expected?An accountable provider and versioned agreement.
Processing grainWhat event or entity is handled per record?Keys, ordering, and deduplication rules.
Quality ruleWhat condition makes the output unfit for use?Observable check and severity.
RecoveryHow is data replayed or corrected?Runbook, owner, and impact communication.

Design controls and exceptions before publication

The central risk is that a pipeline can appear healthy because it ran successfully even though an upstream system supplied an incomplete or changed dataset. Controls should therefore test a specific promise, not merely confirm that software completed a run. Check source arrival against the decision window, validate required fields and permitted values, and reconcile material totals with their accountable record. Define what happens for each severity: a low-impact issue may call for a visible warning, whereas an issue that changes a commitment, priority, or externally used result should hold the measure or report. Every condition needs an owner, a response route, and a record of disposition. The Microsoft governance guidance similarly emphasizes ownership, documented policies, and controls that fit normal work rather than creating an opaque gate.

  • Exercise a late source scenario before launch.
  • Reconcile a replayed period with the original records.
  • Test access to operational logs and run status for the resolver.
  • Document which downstream decisions must be paused when quality fails.

A controlled operating path for data pipeline planning

Build the first release around one source-to-decision path with its actual late-data and recovery scenarios. Use representative records, including an uncomfortable edge case, to test the definitions and the handoffs. Confirm that readers have only the access they need, that a resolver can see enough detail to act, and that a failed check is understandable outside the delivery team. Quality checks work best when they sit close to the transformation or publication step they protect; dbt data tests is a useful technical reference for treating assertions as executable checks. Release notes should identify changed meaning, affected history, and any limitation that a reader needs to carry into a decision.

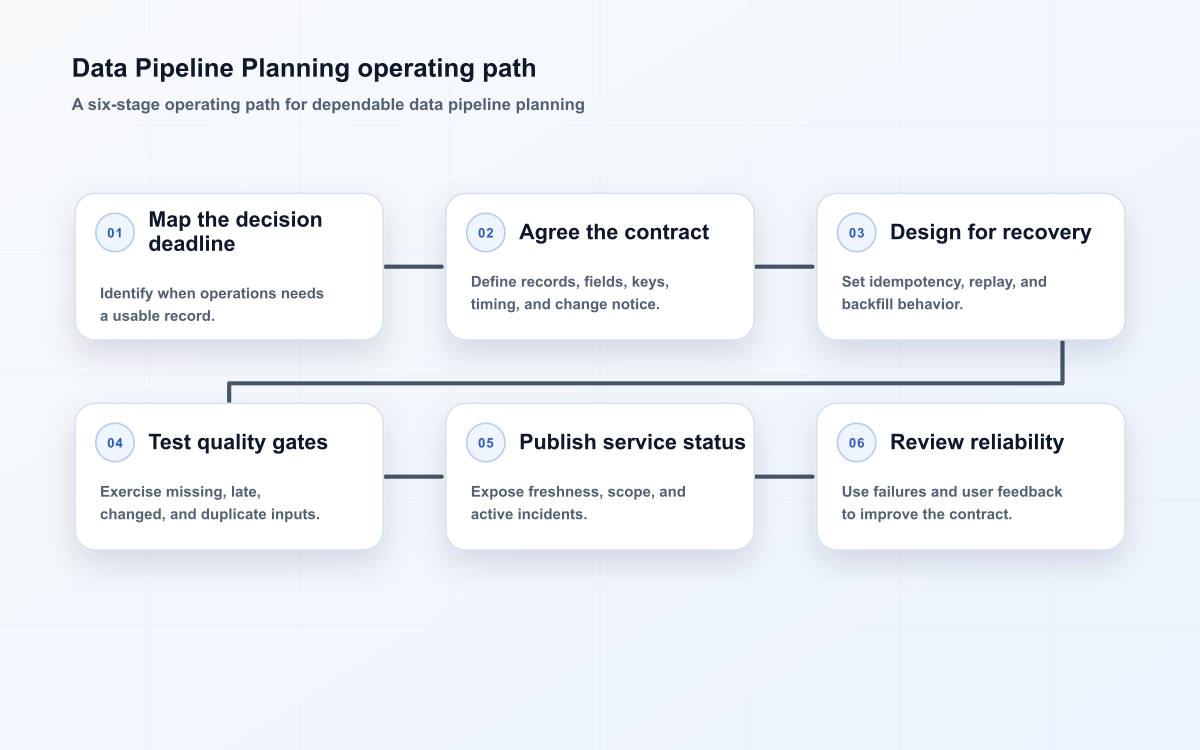

Data Pipeline Planning operating path
Six connected stages show how data pipeline planning moves from a defined decision to ongoing review.
SituationWhat to checkExpected response
Late deliveryCompare arrival with the decision deadline.Warn, hold, or replay according to stated impact.
Schema changeDetect unexpected fields or types at intake.Quarantine and coordinate a contract update.
Duplicate eventApply idempotency key and audit result.Prevent double counting and preserve evidence.
BackfillScope historical effects and downstream reprocessing.Approve, run, reconcile, and notify consumers.

Operate data pipeline planning as a maintained service

A release is not evidence that the service is dependable. Monitor missed arrival windows, schema changes, duplicate events, failed reprocessing, and downstream users discovering issues first. Review a small sample of results with the domain owner and compare the published value with the source evidence, especially after a change in process, policy, or instrumentation. Separate a data defect from a legitimate change in the business; both matter, but their remedies differ. Keep a lightweight log of questions and incidents so recurring ambiguity becomes a definition, model, or workflow improvement rather than another local workaround. The NIST Data Governance and Management Profile work is useful context here: governance is an organizational practice that connects data management choices to accountable risk decisions.

Implementation choices that protect the decision

Choose tooling after the decision contract is clear. A warehouse, semantic layer, orchestration service, or BI platform can support data pipeline planning, but none removes the need to decide grain, ownership, timing, and recovery. Prefer interfaces that preserve lineage from a summary to its inputs, role-based access that matches the work, and observable status for freshness and controls. The Google Cloud data analytics architecture guidance provides a useful architecture perspective on separating ingestion, processing, storage, and consumption concerns. The same principle applies across platforms: a clean boundary makes changes easier to test and failures easier to explain. For further implementation context, see a related planning guide, a related planning guide, a related planning guide, data contract engineering notes.

Change management is part of dependable data pipeline planning, not a cleanup task for a later phase. Keep a compact change record whenever a source field, business rule, threshold, model, or access decision changes. It should say what changed, why it changed, who approved it, which readers or historical periods may be affected, and how the team checked the result. Use a staged release for material changes: compare old and proposed calculations on representative records, obtain the domain owner’s interpretation, and communicate the effective date before the next decision cycle. When a historical value is intentionally restated, preserve both the reason and the scope so readers do not mistake a definition change for operational movement. This practice is especially valuable when new teams inherit the service, because it turns inherited assumptions into inspectable evidence. It also gives business and delivery owners a shared way to decide whether a change needs a simple note, a controlled rollout, or a temporary hold.

Frequently asked questions about data pipeline planning

How many measures should the first release include? Include only the measures needed for the stated decision and its investigation path. A smaller set with definitions, freshness, and accountable owners is more useful than a broad catalog of unexplained values. Add a measure after a real reader can name the decision it changes, the source that supports it, and the person who will maintain its meaning. In data pipeline planning, that restraint keeps the first release tied to a decision rather than a catalog.

What should happen when data quality is uncertain? Do not make readers infer the situation. Show affected scope and freshness, then follow the agreed response: qualify a low-risk result, hold a material result, or route an exception to the named resolver. The key is consistency. A visible exception with a known owner protects trust better than a clean-looking result whose limitations are discovered later. For data pipeline planning, that visible response protects readers from acting on an uncertain result.

Key takeaways for data pipeline planning

  • Anchor data pipeline planning to one recurring decision and a defined time horizon.
  • Make grain, ownership, source authority, freshness, and limitations visible to readers.
  • Attach every material quality condition to an agreed response and resolver.
  • Release in the real work setting, then improve definitions from questions and incidents.

Conclusion: make data pipeline planning useful under scrutiny

Data Pipeline Planning earns trust when it helps people act without asking them to take the logic on faith. Begin with the decision, document the evidence and its limits, make exceptions operational, and keep the result reviewable as source systems and business rules change. That discipline turns a one-time dashboard, model, or scheduled job into a service that can support real work.

Continue with related articles

Data pipeline planning for operations teams

A practical guide to data pipeline planning that covers decision design, data ownership, governance, quality controls, rollout, and the measures that make reporting useful.

Data & Analytics · 8 min

Data Contracts: Engineering Notes

Data contracts helps product teams make a bounded decision with reliable data, clear ownership, and practical operating controls.

Data & Analytics · 12 min read
