Deployment Rollback Plans: Prepare the Decision Before the Release

Prepare compatibility, stop conditions, controlled exposure, and reconciliation before a release ever needs to be reversed.

Edilec Research Updated 2026-07-15 Cloud & DevOps

Deployment rollback plans are a planning and operating capability, not a tool purchase. Prepare compatibility, stop conditions, controlled exposure, and reconciliation before a release ever needs to be reversed. The useful first step is to connect a real client or customer outcome to an owner, a technical boundary, and evidence that the team can use when normal delivery is interrupted.

Key takeaways

  • Start deployment rollback plans from the business or customer outcome that can be harmed, then select controls proportionate to that consequence.
  • Name the service owner, operating authority, and fallback decision before automation obscures the handoffs.
  • Pilot a narrow real path, including controlled failure and recovery, before standardizing it for every team.
  • Measure the evidence that changes the next decision rather than collecting activity metrics for their own sake.

What deployment rollback plans needs to solve

An image revert may not restore database state, queued work, feature settings, or customer entitlements. Recovery must be designed with data, traffic, and communications in view.

Decision areaWhat to decideWhy it matters
Outcome and ownerIdentify the critical journey, accountable service owner, and consequence of failure for deployment rollback plans.Technical choices need a customer and operational context.
Scope boundaryState the release hypothesis, audience, success signals, compatibility window, containment options, and reconciliation owner in the release plan.A bounded first release can be tested and supported.
EvidenceChoose the health, change, access, and recovery record required for deployment rollback plans.Teams should not reconstruct important facts during an incident.
AuthoritySet who can approve, pause, contain, and verify a material change.Fast action depends on clear decision rights.

Set a practical scope and architecture

State the release hypothesis, audience, success signals, compatibility window, containment options, and reconciliation owner in the release plan. Build the first version around one meaningful service path and document its dependencies, access model, data handling, and expected failure behavior. A concise service brief should describe what healthy looks like to a customer, where the important state lives, and which assumption would require the design to change. This keeps architecture choices anchored to a supportable result rather than a broad platform promise.

Planning artifactMinimum contentEvidence of readiness
Service briefCustomer outcome, owner, critical journey, and consequence of interruptionProduct and service owners agree what healthy means.
Dependency mapData, identity, integrations, limits, and likely failure pathsThe team can describe expected behavior when a critical dependency is slow or absent.
Operating contractRoutine changes, access, alerts, escalation, and recovery authorityA responder can act without first discovering ownership.
Change recordIntent, risk, validation, stop conditions, and recovery optionReview distinguishes a known trade-off from an unknown risk.

Design the operating path for deployment rollback plans

Deployment rollback plans should be written before release because reversal is a product and data decision, not just a command. Consider a new checkout rule that writes a discount field. If old code ignores the field, a traffic shift or artifact rollback may be safe; if a migration deletes a legacy column, rollback could extend the outage. Define the release hypothesis, customer signals, stop thresholds, authority to act, and the least harmful containment option: disable a flag, reduce traffic, rate-limit a path, restore a snapshot, or revert the artifact. Then test the decision with the actual people and access route used in production.

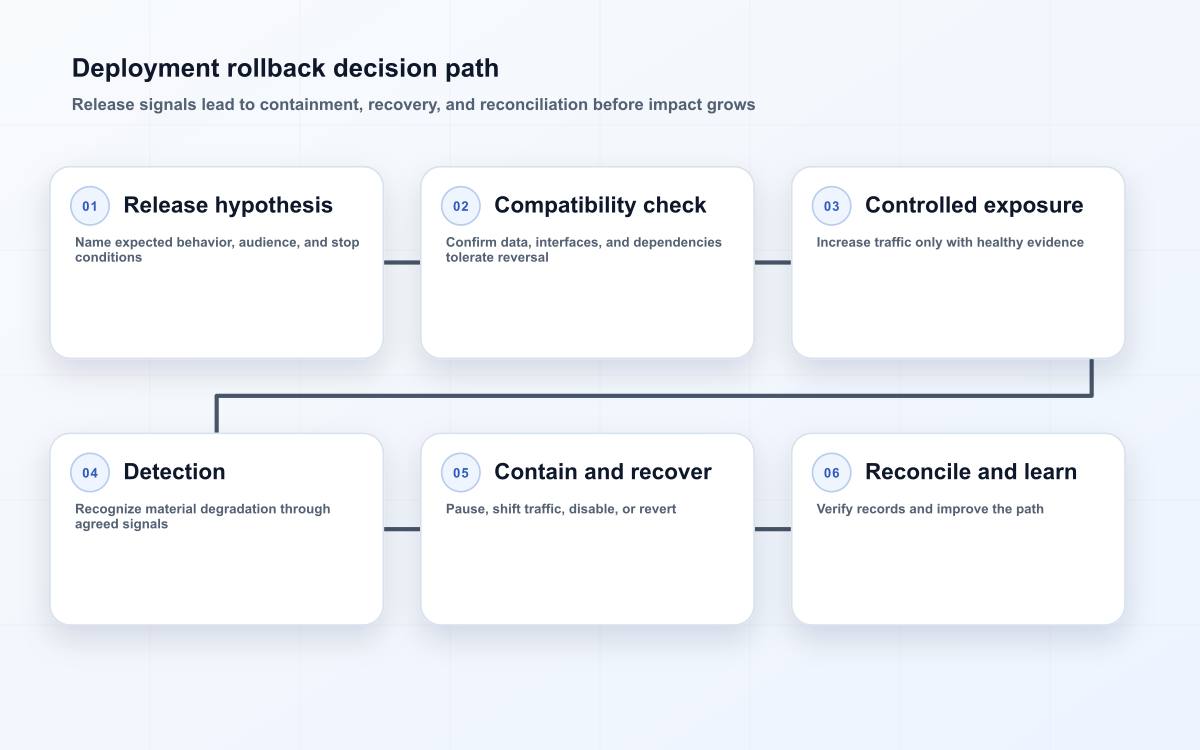

Deployment rollback decision path
Deployment rollback decision path shows the operating decisions, evidence, controlled action, and learning loop described in this guide.

Decide containment before customer impact grows

Release conditionAcceptance checkOperating risk
Stop thresholdError, latency, and customer outcome thresholds are written with a bounded observation window.Teams debate whether a release is bad while the impact expands.
State compatibilityThe change documents old/new code behavior, migrations, queues, and cache consequences.A nominal rollback makes records unreadable or repeats side effects.
AuthorityAn on-call owner can pause exposure without waiting for an unavailable approver.A reversible incident becomes prolonged because decision rights are unclear.
ReconciliationThe plan identifies records, messages, or payments that need verification after containment.Service health returns while customers retain incorrect business outcomes.

Put controls where the work happens

Prefer expand-and-contract migrations, idempotent jobs, and feature controls. Give responders access to execute prepared recovery paths and preserve decision evidence.

  • Give every material alert, approval, exception, or recovery decision a named owner and escalation route.
  • Keep changes to access, configuration, and production state reviewable and traceable.
  • Document pause and fallback conditions in the normal workflow, not only in an incident binder.
  • Exercise recovery and access paths with the people who will use them in production.
  • Treat repeated exceptions as feedback on the supported operating contract.

Pilot the path before scaling it

Rehearse a credible failure: detect a controlled unhealthy signal, stop exposure, contain, validate user behavior, reconcile records, and revise the plan.

Pilot questionHow to test itDecision enabled
Can customers complete the critical path?Use a representative workflow and service signal.Proceed, redesign, or narrow scope based on outcome evidence.
Can the team operate it?Have actual service and support owners perform routine work.Clarify ownership, improve documentation, or reduce complexity.
Can the team recover it?Introduce a controlled fault or failed change and follow the runbook.Fix recovery gaps before wider exposure.
Can the team govern it?Review access, audit history, cost or capacity, and exceptions.Accept the operating model or add focused controls.

Measure decisions, not activity

Metrics for deployment rollback plans should reveal whether the intended service outcome is holding and whether the team can make a timely operating decision. Establish a baseline before the pilot and attach context to material changes. Do not use a single number as a verdict on people; use it to locate the next improvement while the evidence is fresh.

MetricWhat it revealsReview use
Customer outcomeCompletion, success, or timeliness for the critical journeyCompare against the agreed service objective.
Detection and responseTime to recognize, own, contain, and verify a material problemImprove routes, authority, and runbooks.
Control adherenceChanges using the supported, evidenced pathInvestigate exceptions and friction.
Recovery confidenceRecent exercises that reached business validationPrioritize untested or unreliable services.

Frequently asked questions about deployment rollback plans

Is rollback always right?

No. A flag disablement, traffic shift, rate limit, or partial fallback may contain harm more safely than an artifact revert.

Can Kubernetes undo a migration?

A Deployment can restore its pod template, but not external database state. Design and test data changes separately.

Who authorizes a rollback?

Set authority by risk. On-call responders need power to stop customer harm; major repair can involve a designated incident or service owner.

A practical checklist for deployment rollback plans

  • Confirm the service owner, support contact, and authority to pause or contain a material issue.
  • Keep the decision record, current configuration, dependency map, and verification evidence discoverable to the people on call.
  • Run a controlled exercise before wider rollout and record the actual time to detect, act, and verify recovery.
  • Review exceptions and repeated manual steps; they identify where the operating contract needs improvement.
  • Set a review date after significant product, dependency, staffing, or compliance change.

For rollback readiness, include customer state in the plan. Decide what happens to requests already accepted, messages already emitted, emails already sent, and entitlements already changed. Some effects cannot be undone, so the safest containment may be to stop further exposure and run a compensating operation. State that possibility before release approval rather than promising a universal undo.

Keep the plan alive after launch

Keep the recovery plan close to the release. A responder should find the revision, feature setting, migration status, traffic control, dashboard, stop threshold, owner, and customer communication route in one place. After the drill or incident, compare the plan with what happened. Update it when a step was unclear, too slow, or dependent on unavailable access.

Make deployment rollback plans survive real handoffs

The enduring test for deployment rollback plans is whether a capable person who was not present for the original design can make the next safe decision. Keep stop conditions, state compatibility, and customer reconciliation in a concise operating record that is linked from the normal delivery and support path. The record should distinguish facts from assumptions, name the current owner, and say what evidence is needed before an exception becomes a permanent change. During a staff change, vendor incident, or urgent customer request, this clarity is more valuable than a polished architecture diagram because it shows who may act and how success will be verified. Review the record after every meaningful release or incident. Remove instructions that are no longer true, add the context that responders had to discover, and turn recurring verbal advice into a visible control or supported workflow. This review habit prevents the service from quietly depending on a few people who remember why an old decision was made.

Handoff itemQuestion to answerOwner check
Current stateWhat version, configuration, and operating condition is in effect for deployment rollback plans?A named owner can locate the evidence quickly.
Decision boundaryWhich action can proceed routinely, and which needs escalation?Authority matches the service consequence.
VerificationWhat customer, technical, and operational signals confirm the action worked?The result is recorded before work is declared complete.
Review triggerWhich change, incident, or date requires the plan to be revisited?The operating record remains current.

Conclusion

Deployment rollback plans create value when they become a dependable operating capability rather than another layer of tooling. Start with one accountable service path, make failure and recovery concrete, and use pilot evidence to decide what deserves standardization. That is a plan clients can fund, operate, and improve without relying on untested assumptions.
